Monday 27th June 2016 – Sunday 12th March 2017
Our long awaited extension is starting today.
Beginning with a new kitchen!
Before work starts

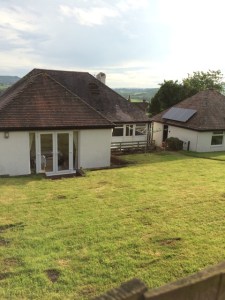

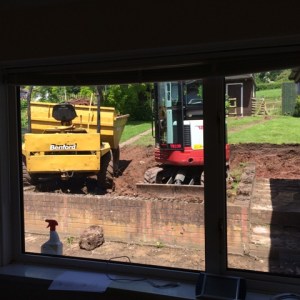

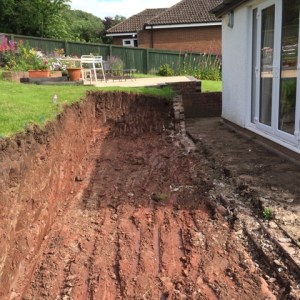

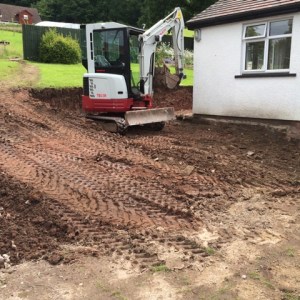

The back of Springdale

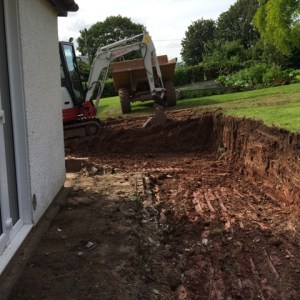

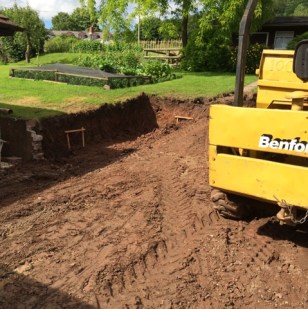

The area in front of the fence will be dug
out until it is in line with the room with
the patio doors.
The kitchen will stretch from the
table and chairs as far as the end of the wall
that can be seen on the right.
Monday 27th June 2016

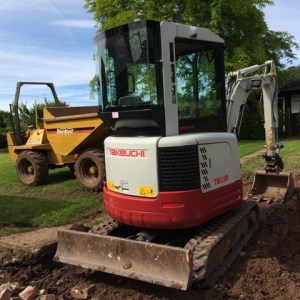

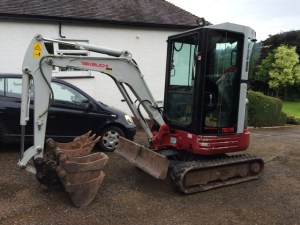

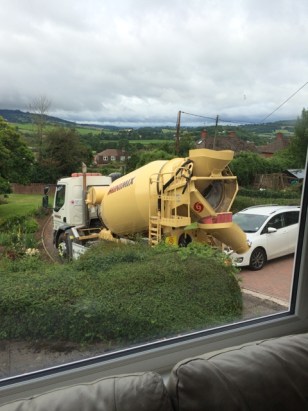

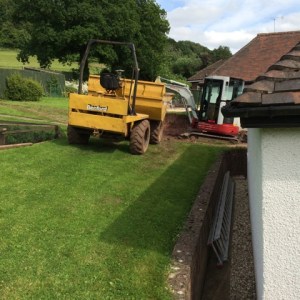

Machinery arrived. Weather lovely. Forecast is not for the rest of the week.
Photos showing the story of today
Excavation Continues -Day 2
Day 3 – Digging out resumes

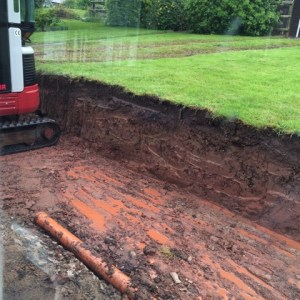

Weather forecast was correct. Lots of very heavy rain over the past 2 days.

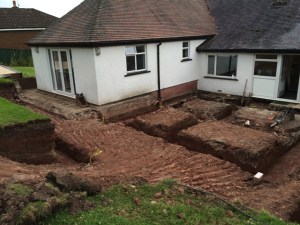

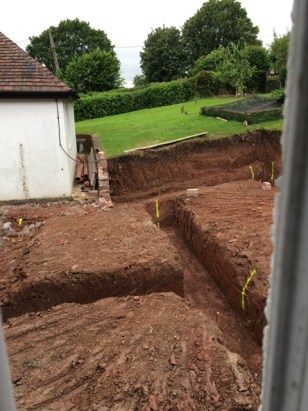

State of play after today’s work is shown in the photos below.

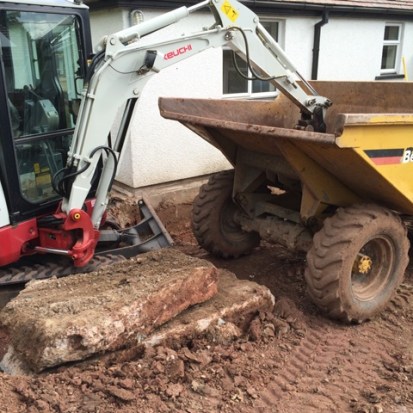

Large pieces of concrete found in ground needed a jackhammer drill to break them up into moveable chunks

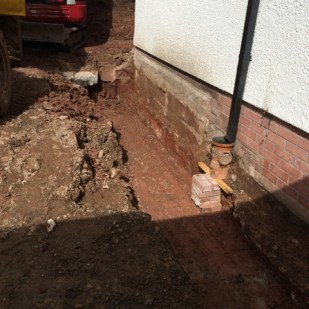

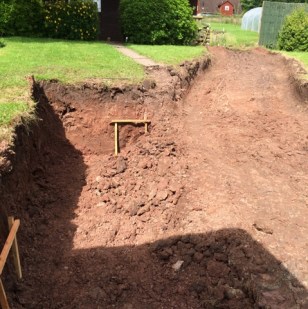

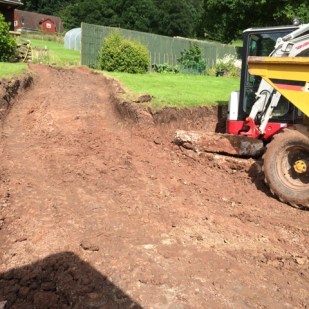

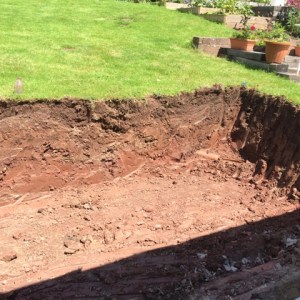

Ramp to garden and fields

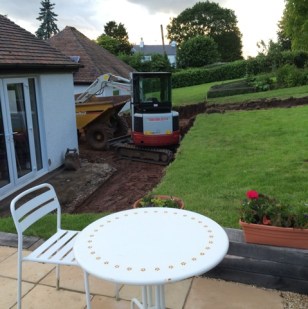

View of trenches so far from patio

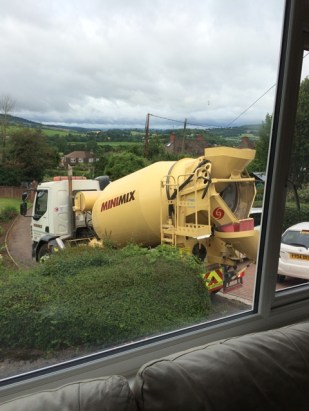

Monday July 4th
The forecast was dry.
Here are photos for Monday’s work:

Digger at work
Day 5 and 6 – Tuesday 5th July and Wednesday 6th July
Lots of changes to be seen now.
Foundations are really taking shape.
Photos below
Building Control Officer will come to inspect the foundations tomorrow

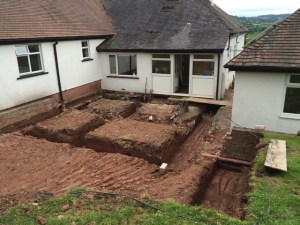

Thursday 7th July 2016

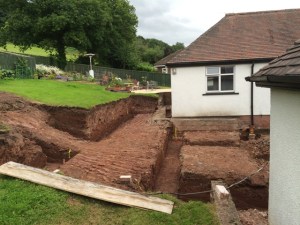

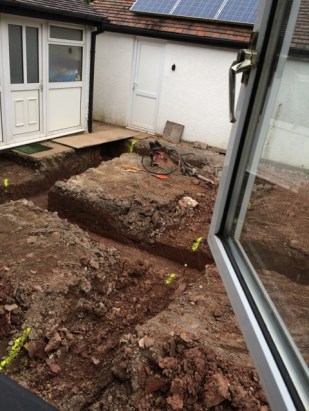

All areas are now prepared for concrete.
The Building Control Officer has been to inspect the excavation and everything is in order.
Photos below
Day 8 – Friday 8th July
Friday 8th July – Day 8

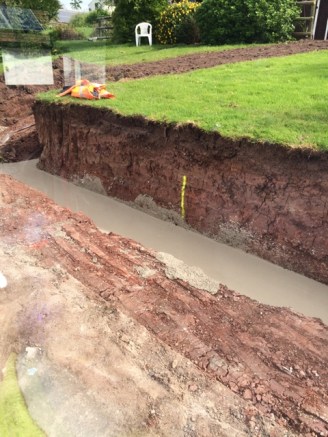

Concrete filling

‘Before’ pictures
‘During’ pictures
Gate had to be removed

Pipes laid for pumping concrete

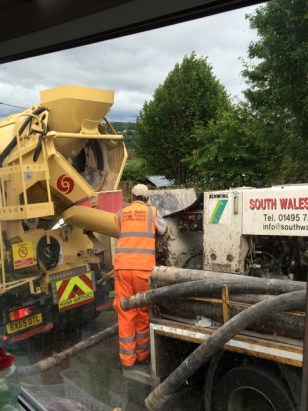

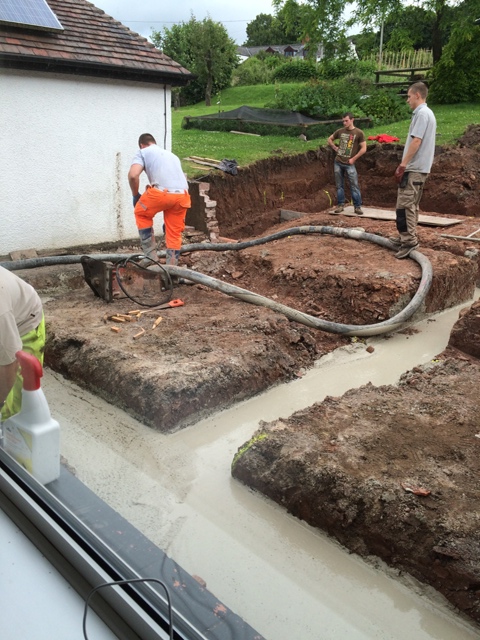

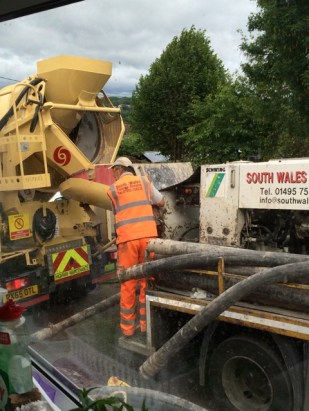

Concrete pump started up

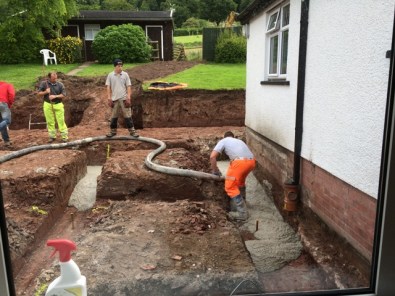

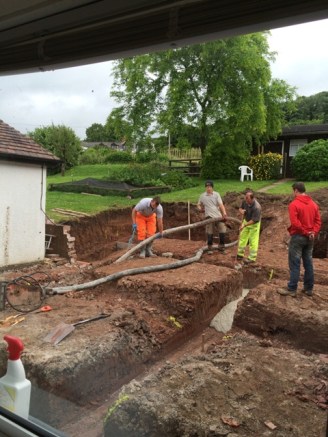

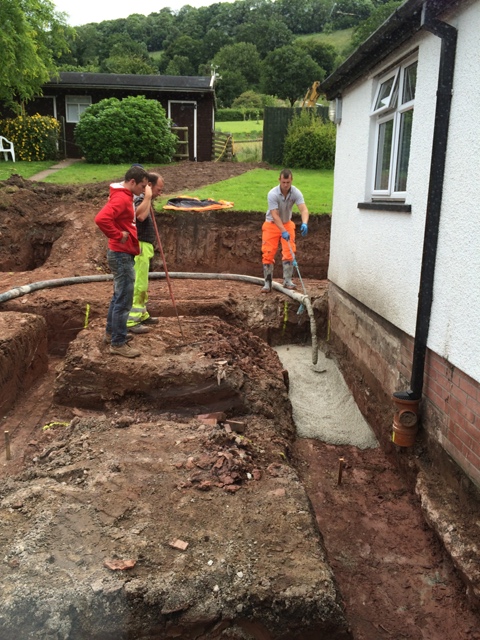

Trenches being filled
More concrete arriving

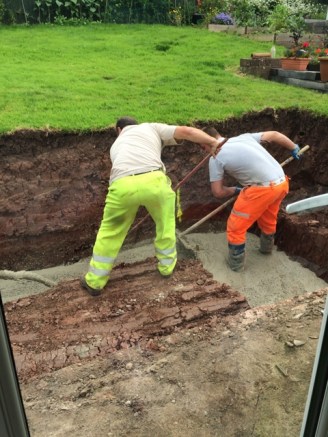

Levelling concrete to peg height
More concrete filling

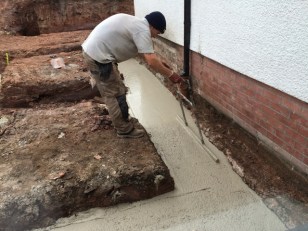

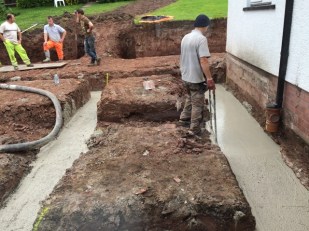

Tapping out air bubbles and smoothing
Finishing off and creating a working area
‘After’ Pictures

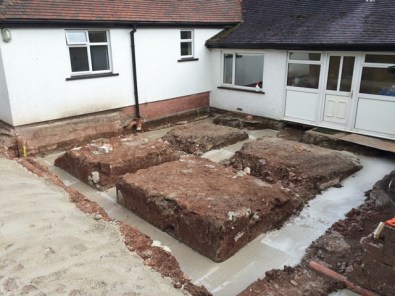

Finished Foundations
A great morning’s work!
Day 9 – Tuesday 12th July

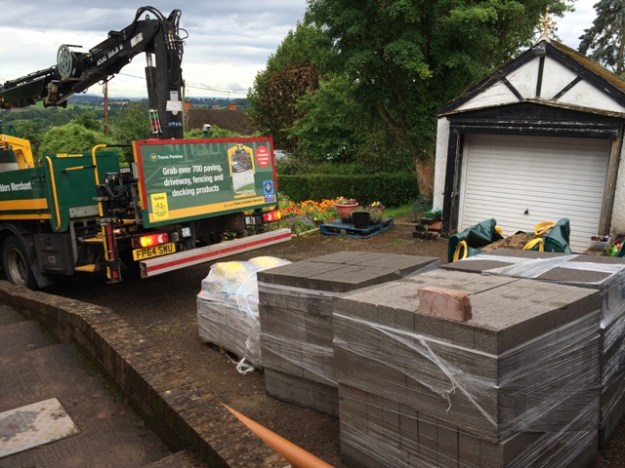

Delivery of building materials
Foundations are all hardened and ready for building

Day 10 – Wednesday 13th July

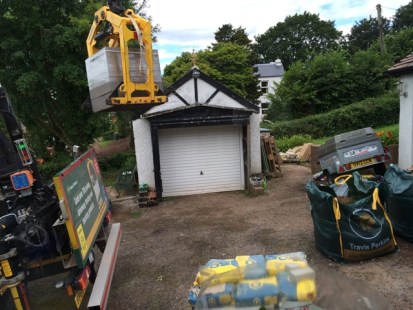

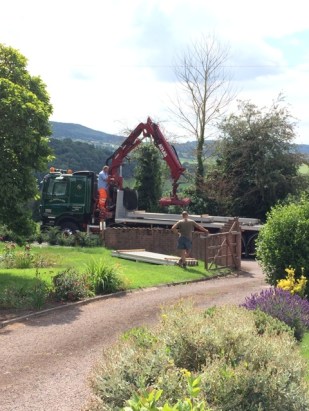

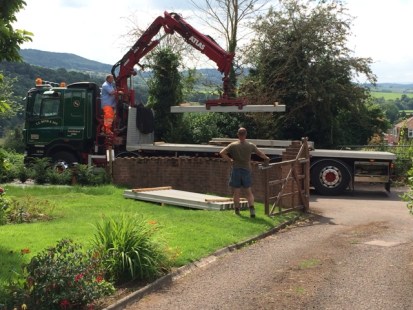

Craning in the building materials
Day 11 – Thursday 14th July

Brickwork is now in place as far as possible.
The next step is to order the block and beams for the flooring.

Foundations behind new lounge, currently a bedroom

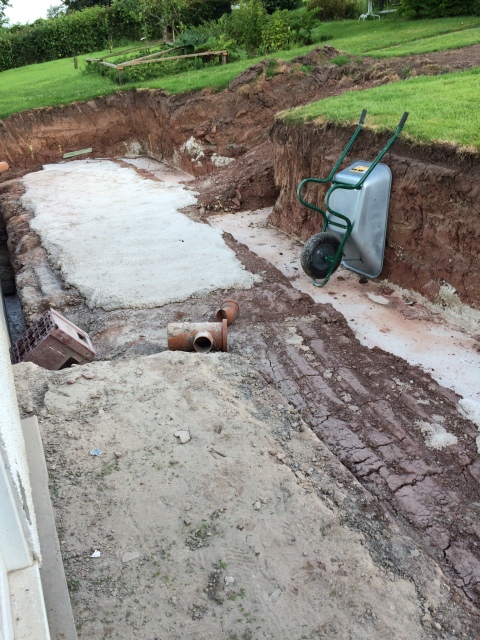

Day 12 – Friday 22nd July

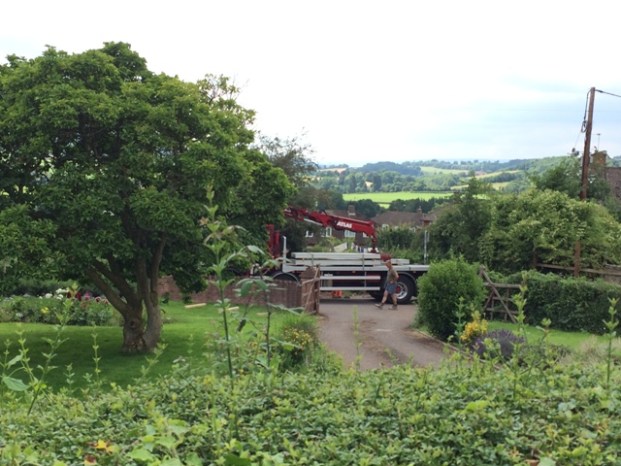

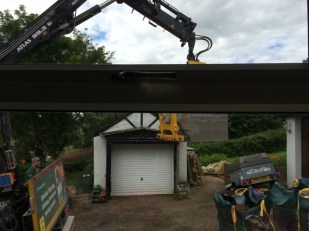

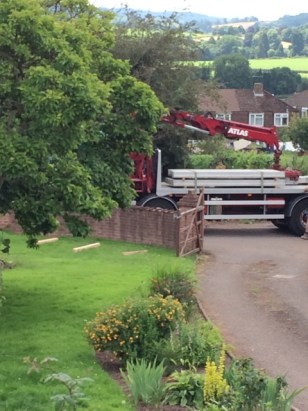

Block and Beams for the new flooring delivered today.
Brickwork Stage at end of day 12

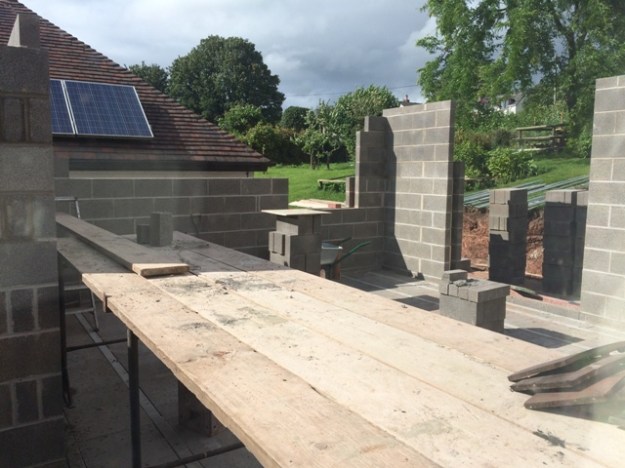

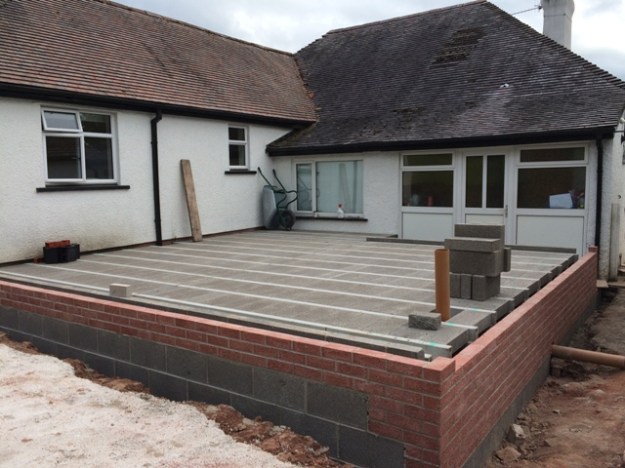

Now ready for block and beam stage

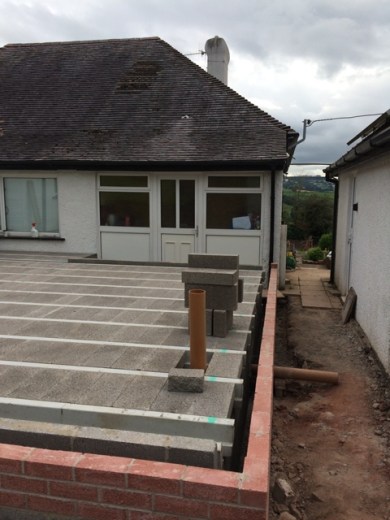

Day 13 – Monday 25th July 2016

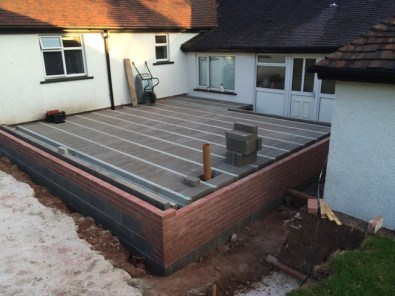

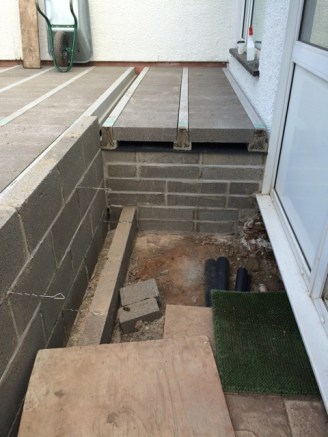

The block and beam flooring was installed today. It is absolutely solid.
Hard, heavy work for the builders.

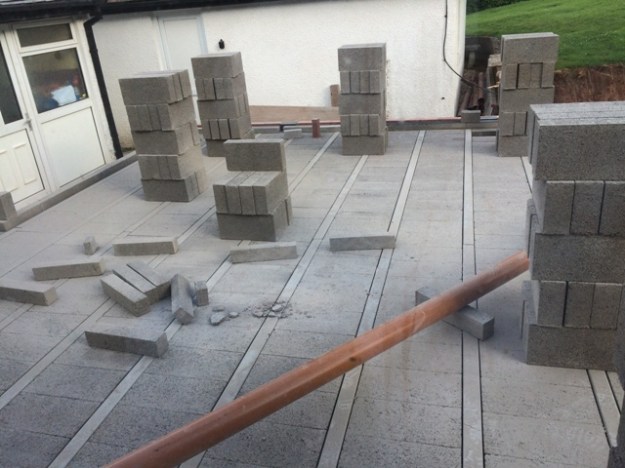

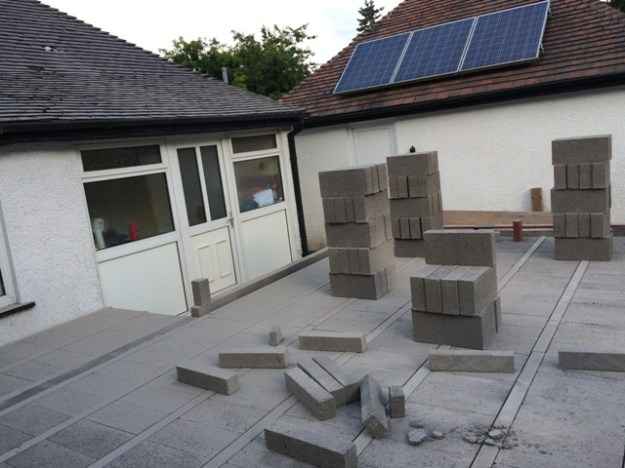

Day 14 – Wednesday July 27th 2016
Building Work Continues

Day 15 – Thursday 28th July 2016

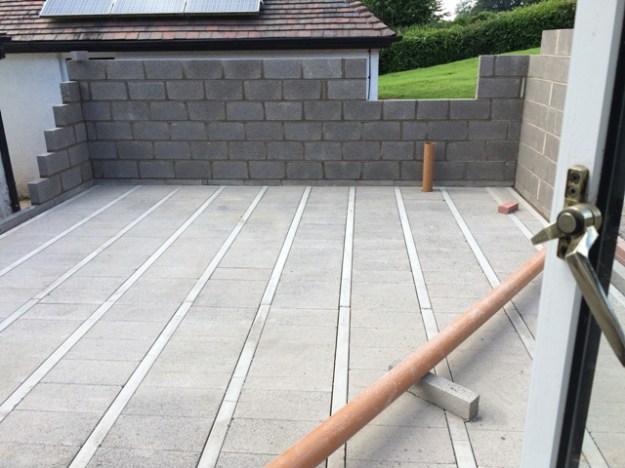

New walls for kitchen going up today

Waste pipe for kitchen sink

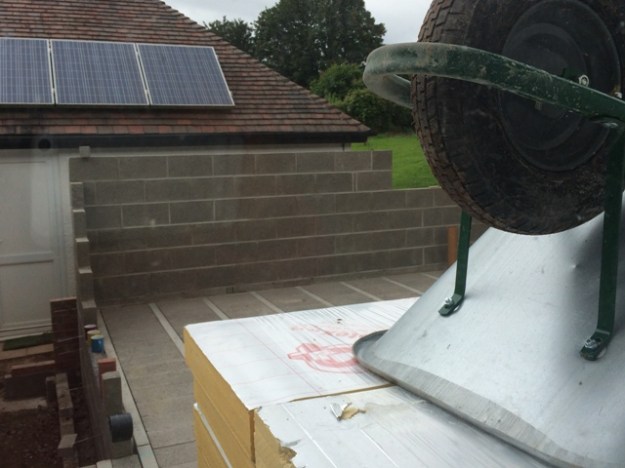

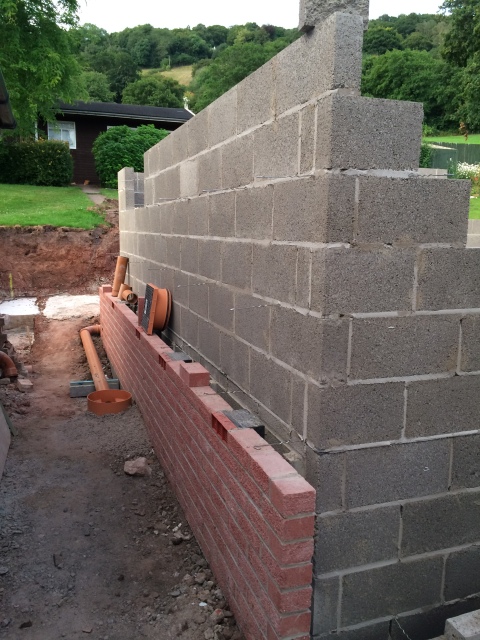

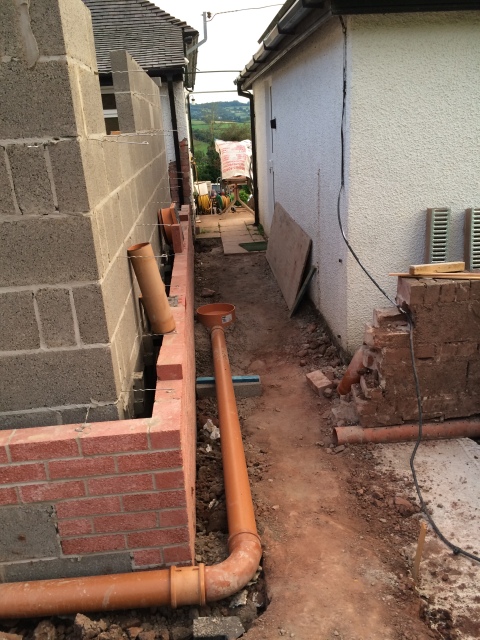

Day 16 – Friday 29th July 2016
Walls and Drains

View from Utility Room – New Patio doors taking shape

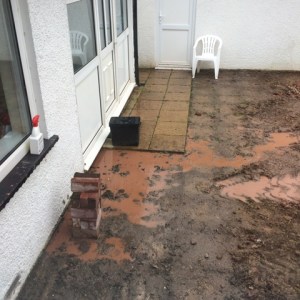

Getting the Drainage Correct

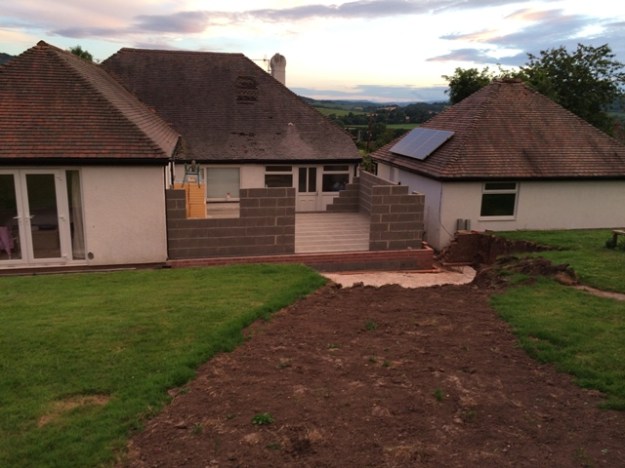

Gap for Patio Doors

Kitchen window gap appearing over drain pipe

View from Stable – Back of Springdale – compare with first picture at the top of this page
Day 17 – Monday 1st August 2016

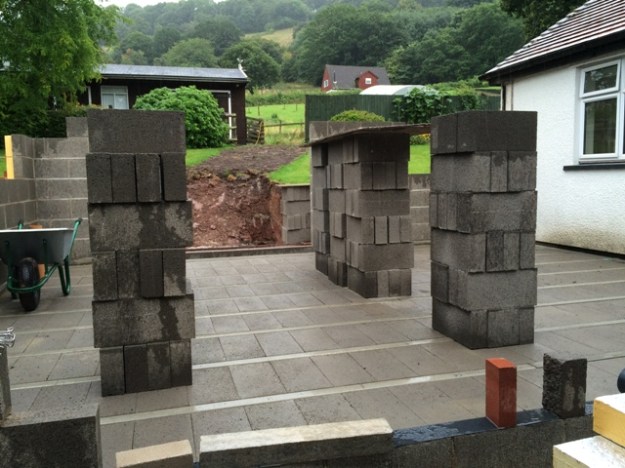

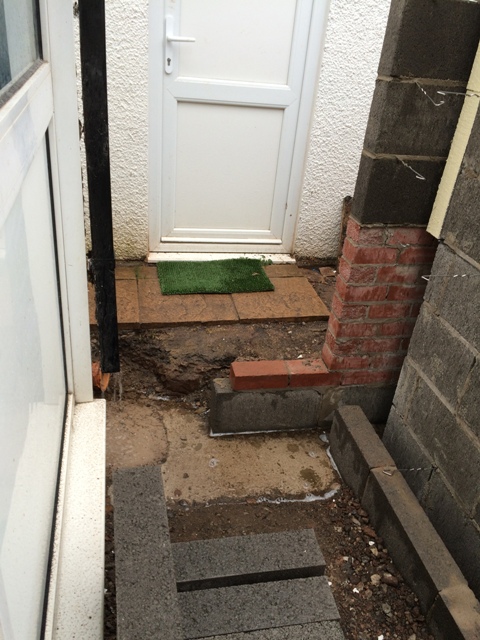

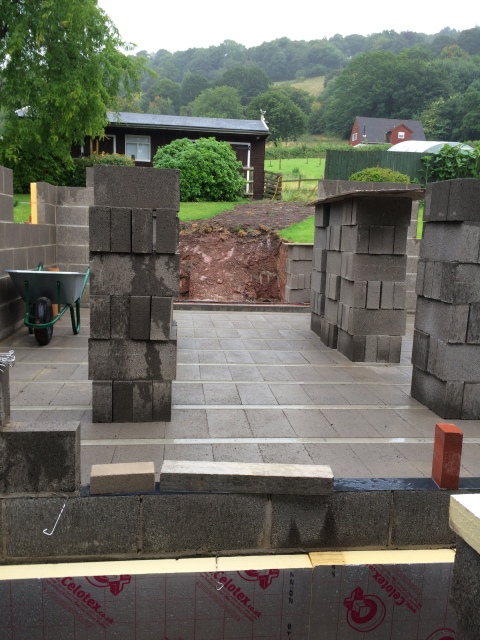

Very wet day

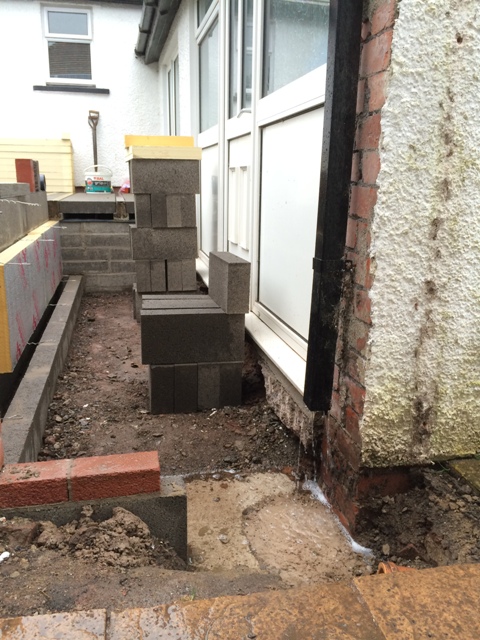

Insulation beginning and more work on drains

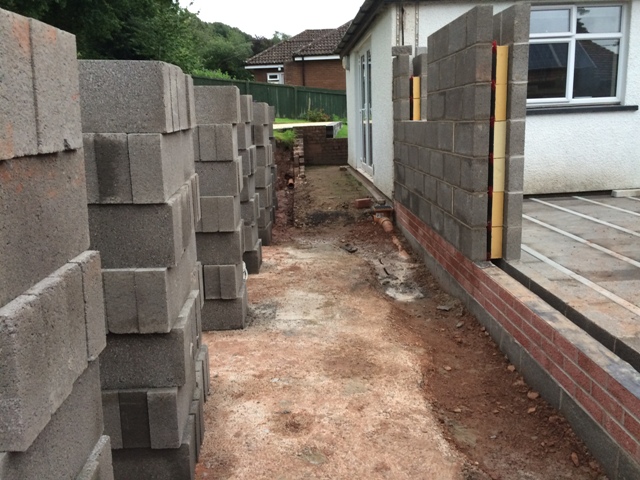

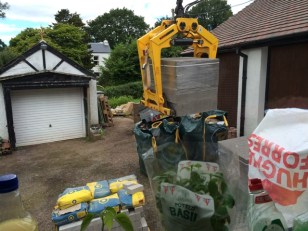

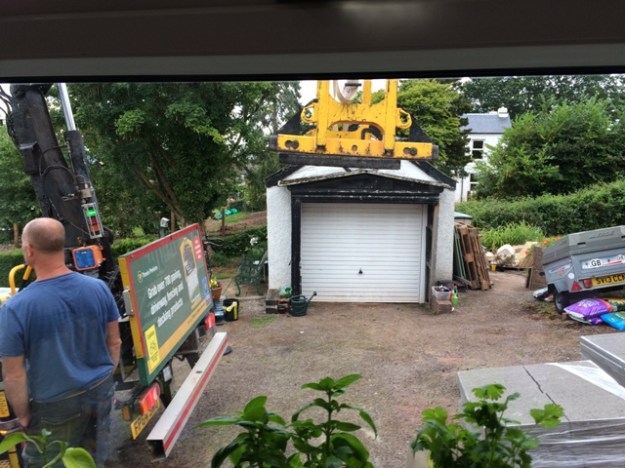

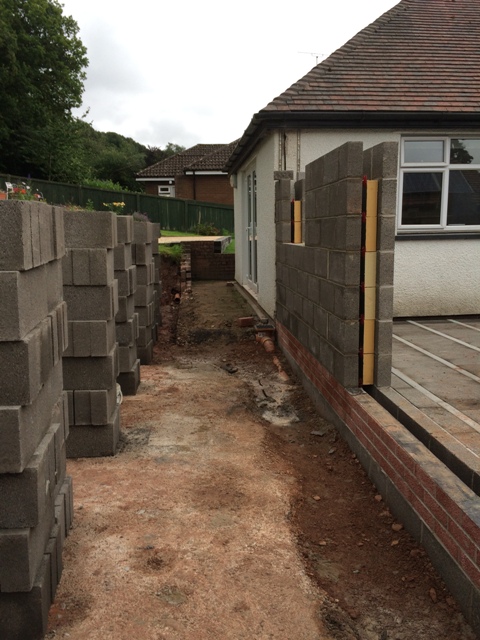

More blocks being delivered Truck size is limited by width of drive Therefore that limits weight that can be delivered

Bricks stacked to hand for builder

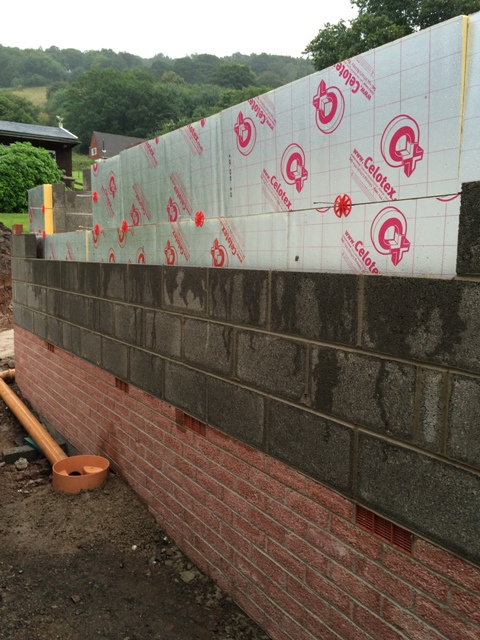

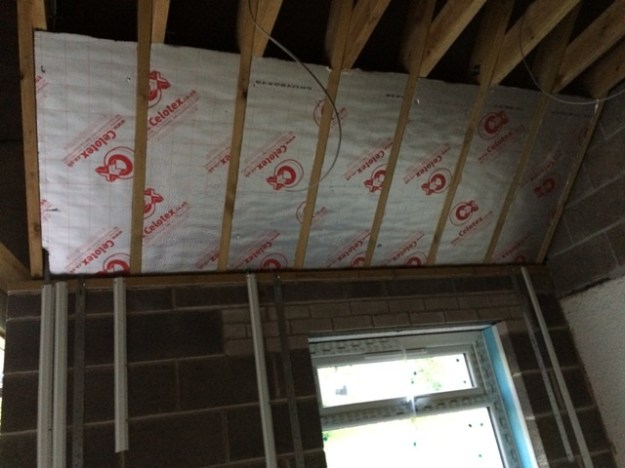

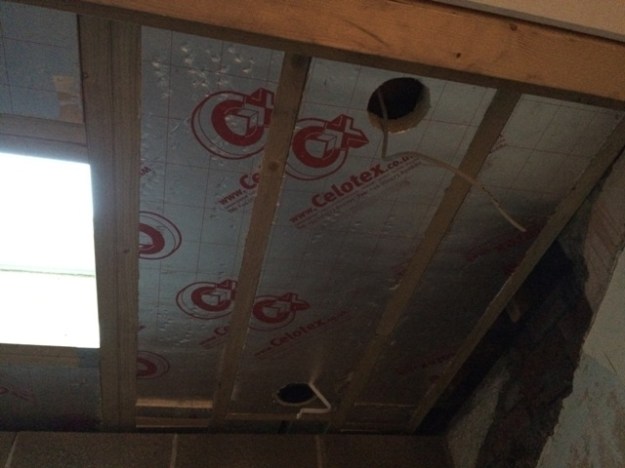

Insulation – celotex repels water

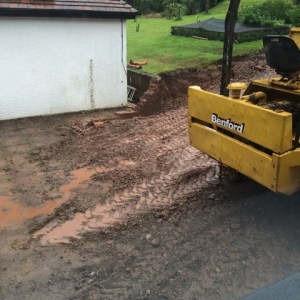

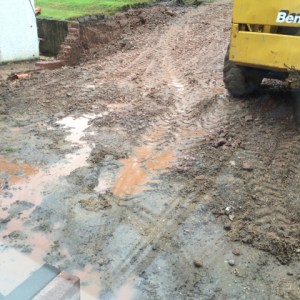

Rain stops play again

A whole lot of rain

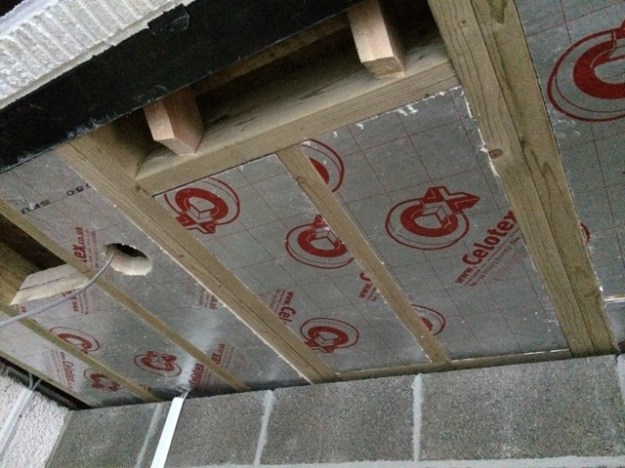

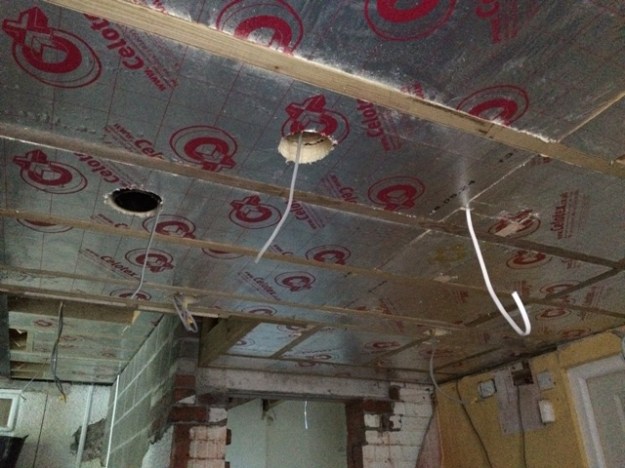

Insulation between double block work
Day 18 – Tuesday 2nd August 2016

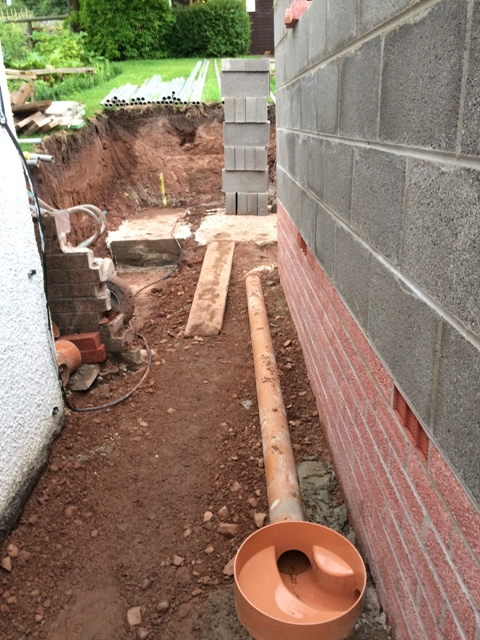

Brick work is rapidly growing.

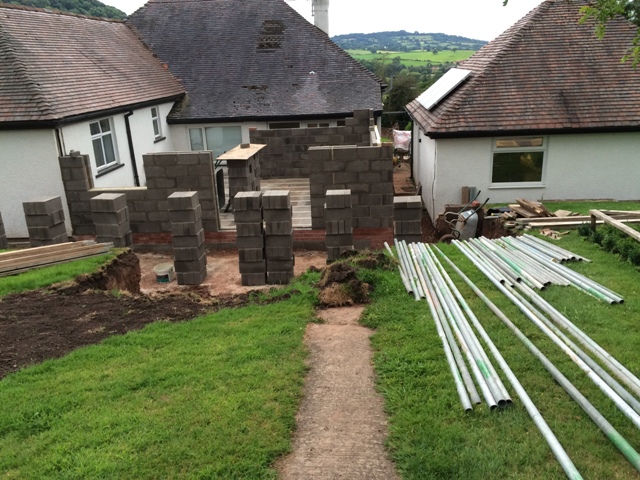

Scaffolding waiting

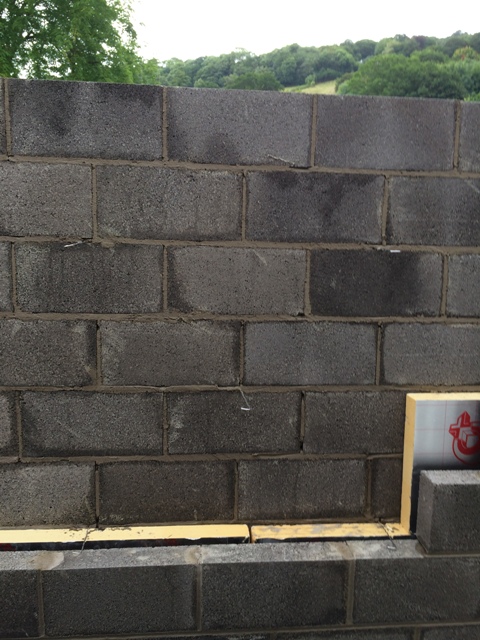

View from back door
Day 19 – Wednesday 3rd August 2016
Kitchen area is taking shape

Scaffolding ready

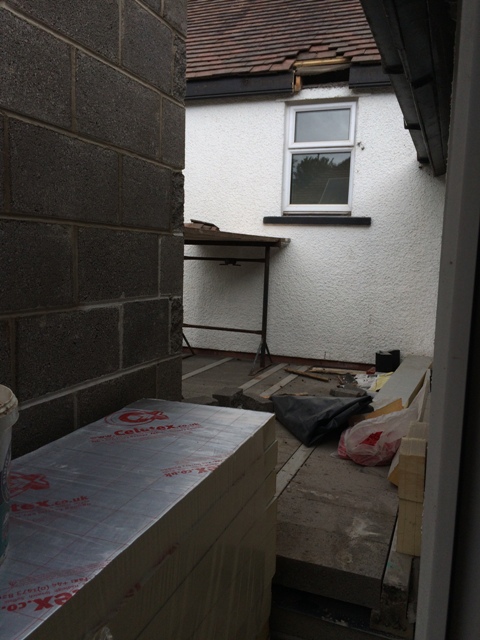

Area for Lintel

Day 20 – Thursday 4th August 2016

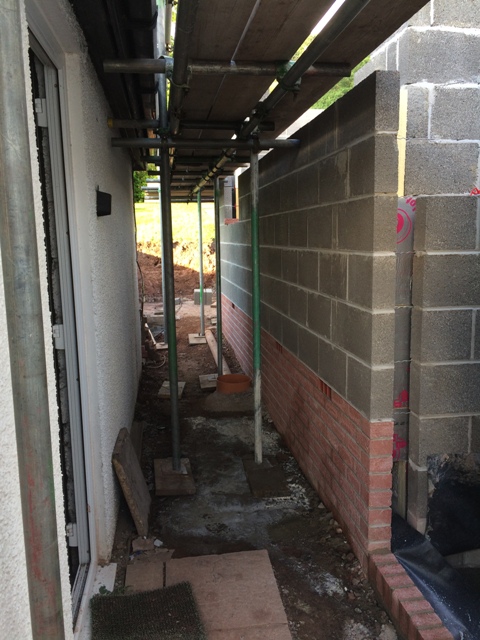

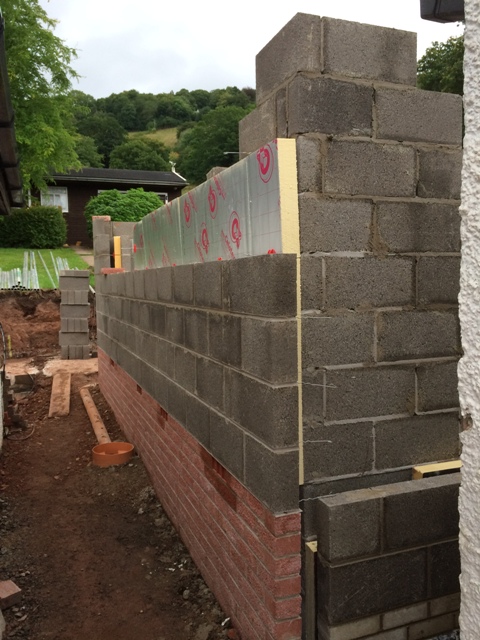

Between New Kitchen and Garage

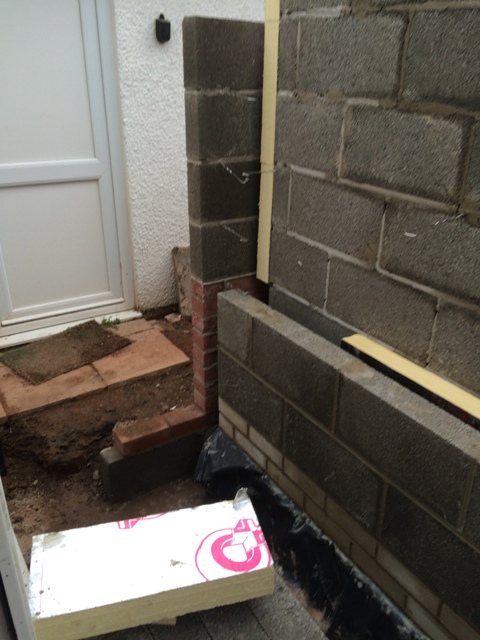

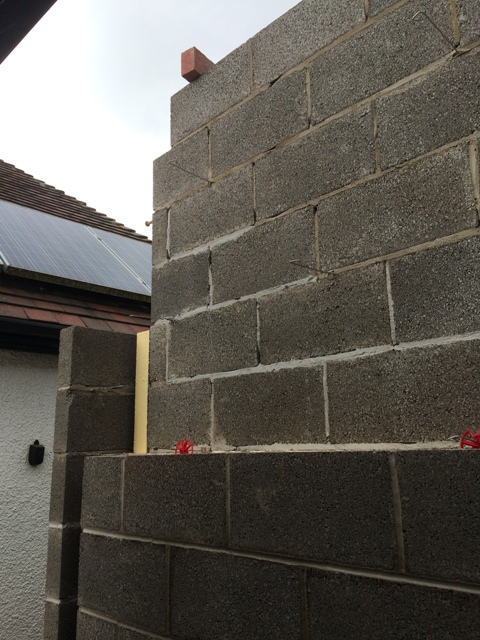

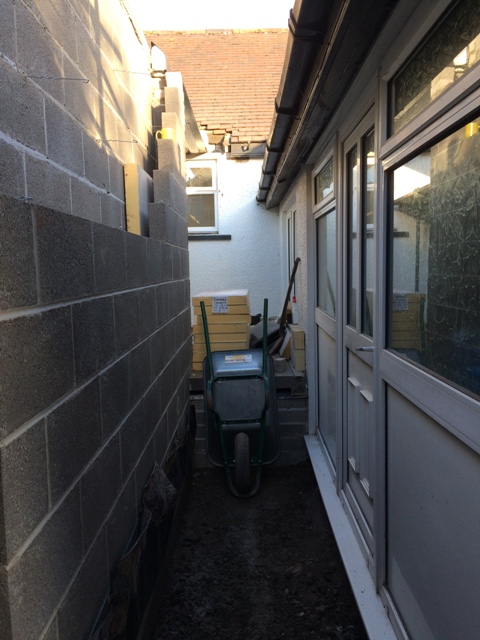

New entrance to kitchen from utility room

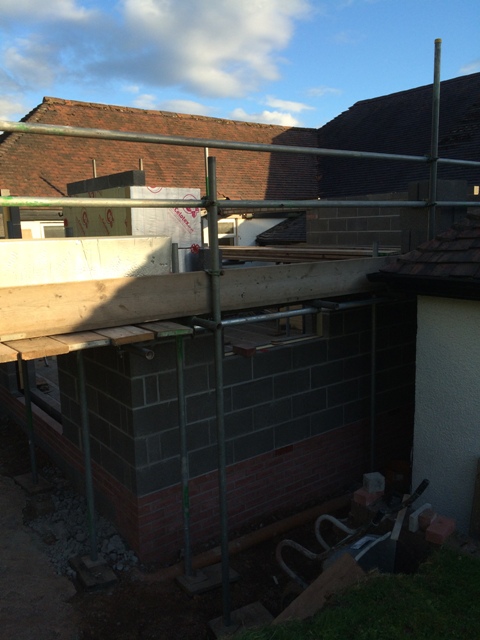

Corner of New Kitchen

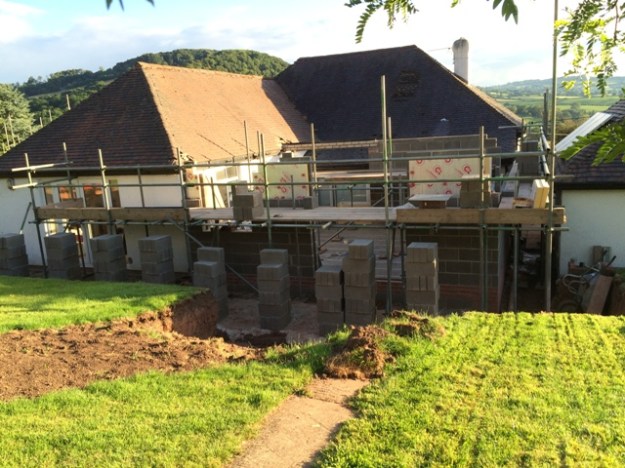

Day 20 – Progress so far

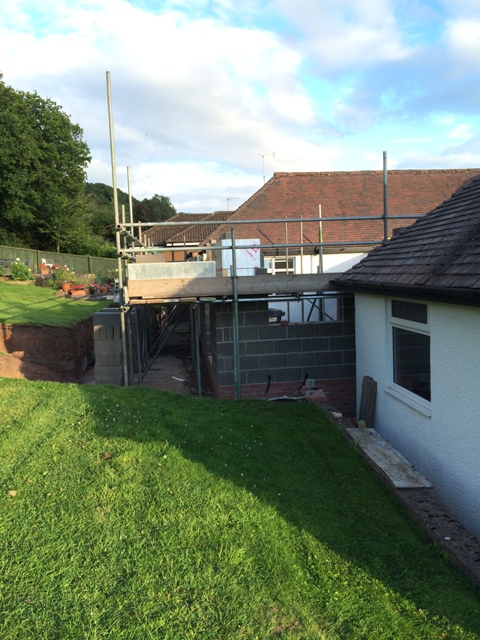

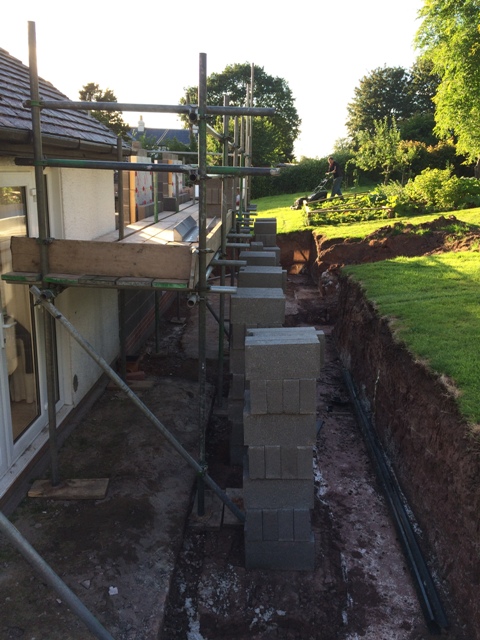

Scaffolding around back

View along back of house day 20
Day 21 – Friday 5th August 2016

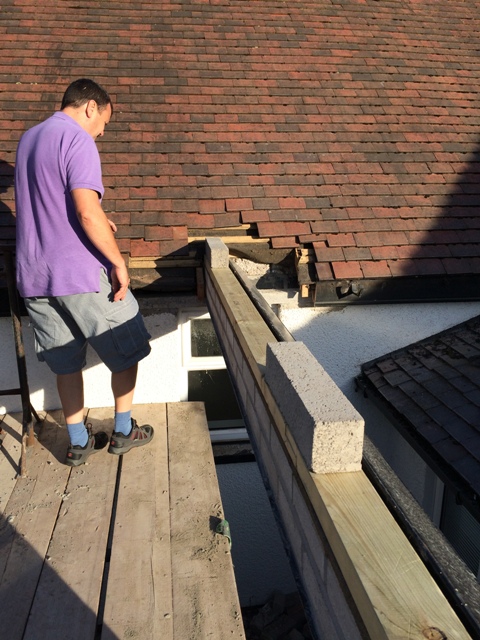

Checking new lintel

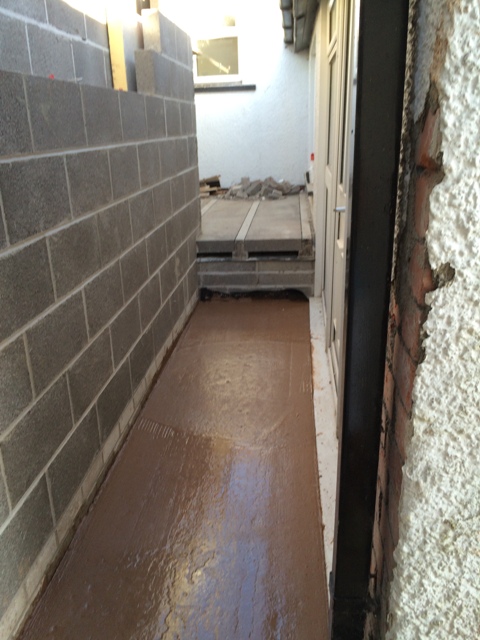

Concrete slab for utility

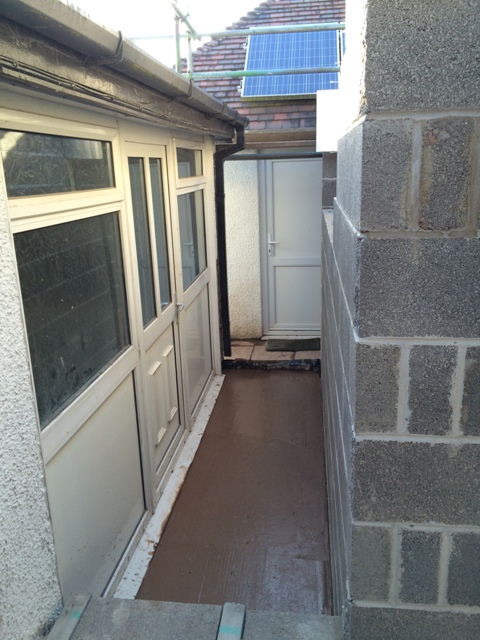

View of garage through new kitchen

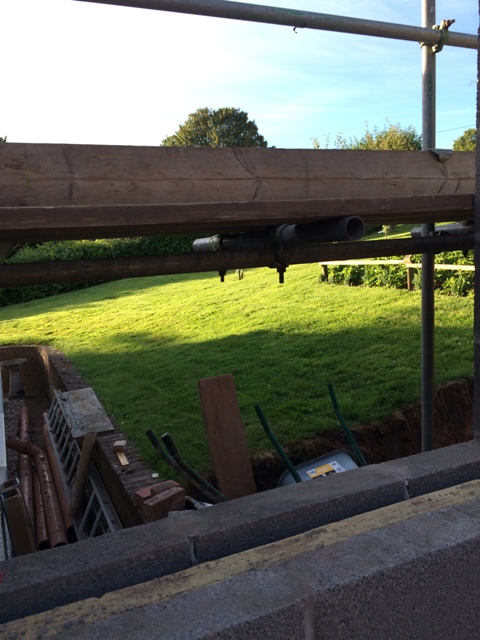

Looking through new window position

Top of new kitchen

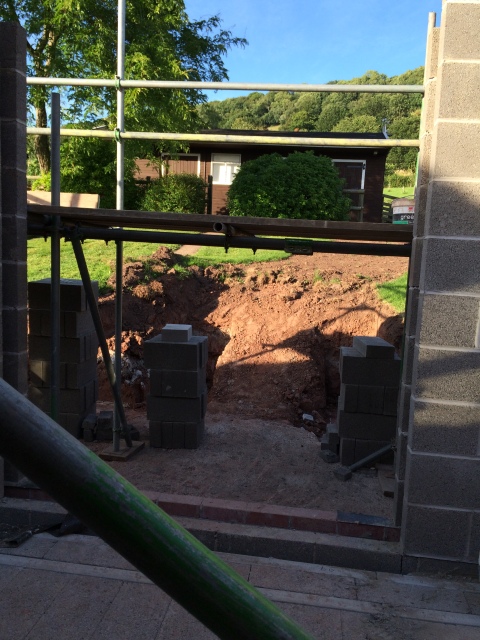

View from kitchen through patio door to steps eventually

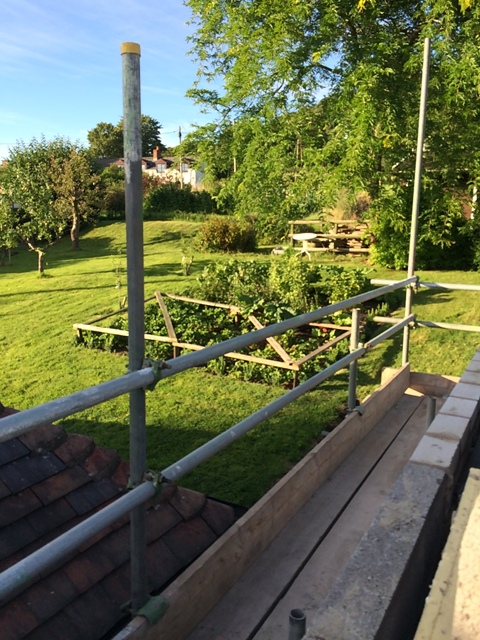

View of back garden

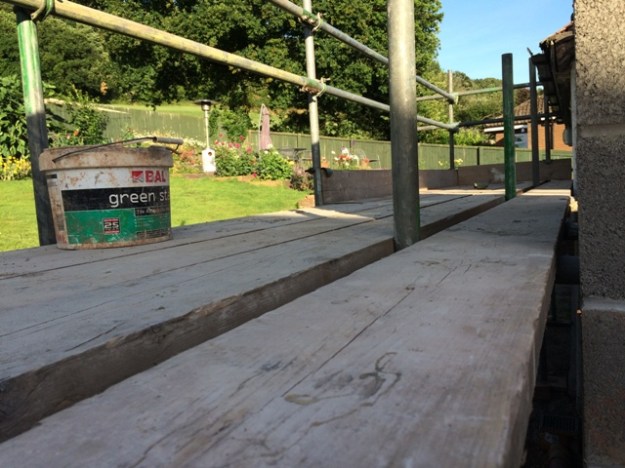

View of patio through scaffolding

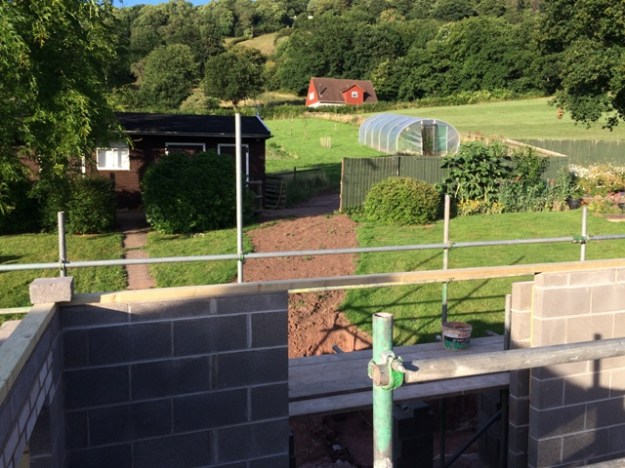

View of polytunnel from top of scaffolding

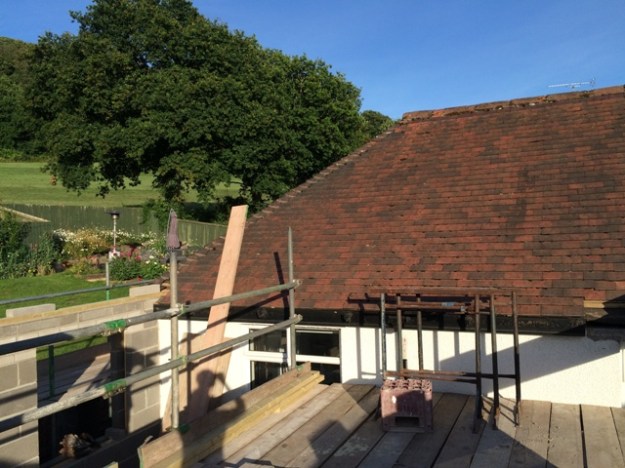

View over garden to field 2

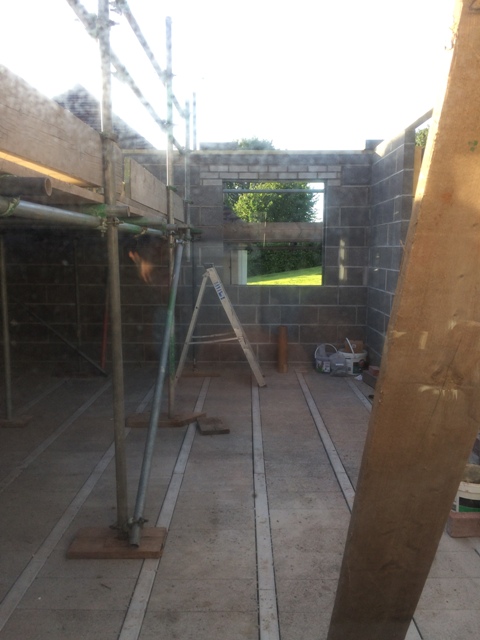

View to new kitchen window position
Day 22 – Saturday 6th August 2016

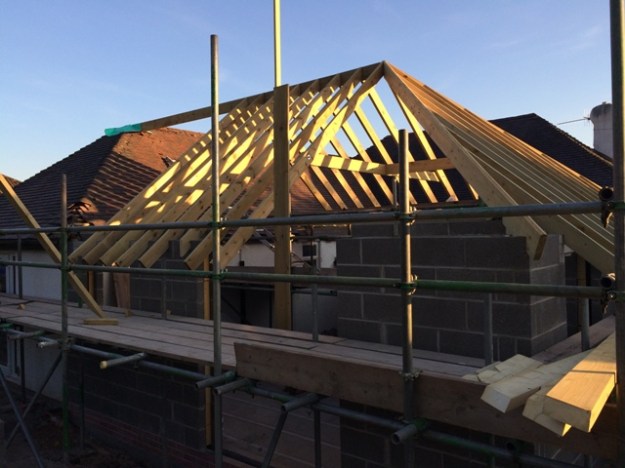

Roof Construction begins

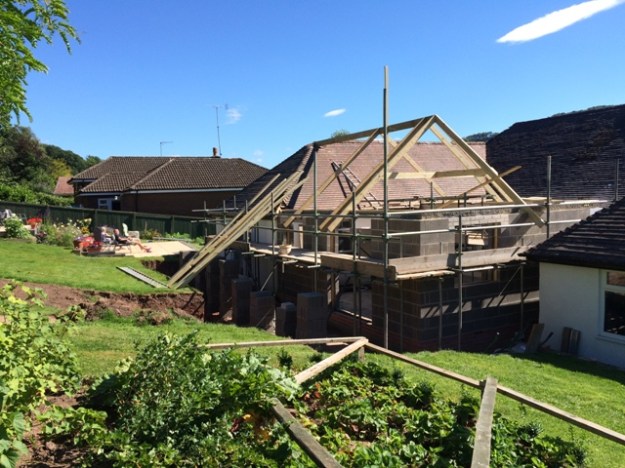

Beginning of new kitchen roof

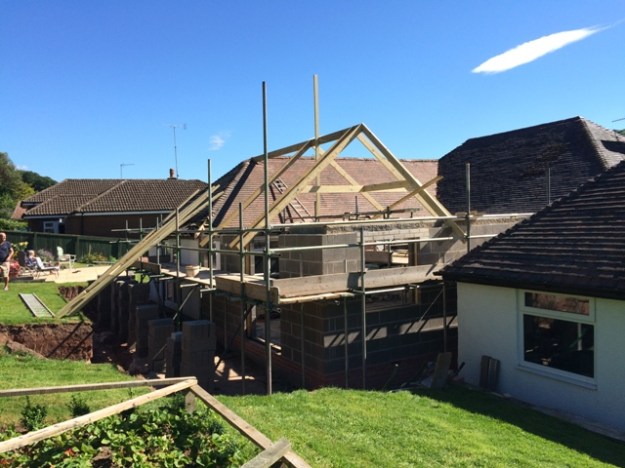

Beginning of new kitchen roof picture 2

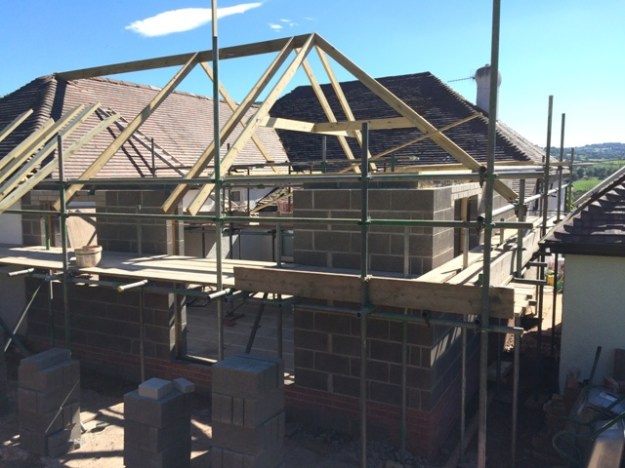

Beginning of new kitchen roof picture 3
Day 23 – Sunday 7th August 2016
Kitchen Roof Construction

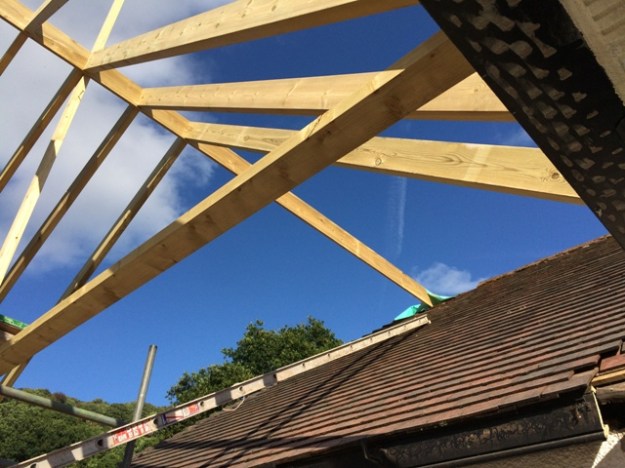

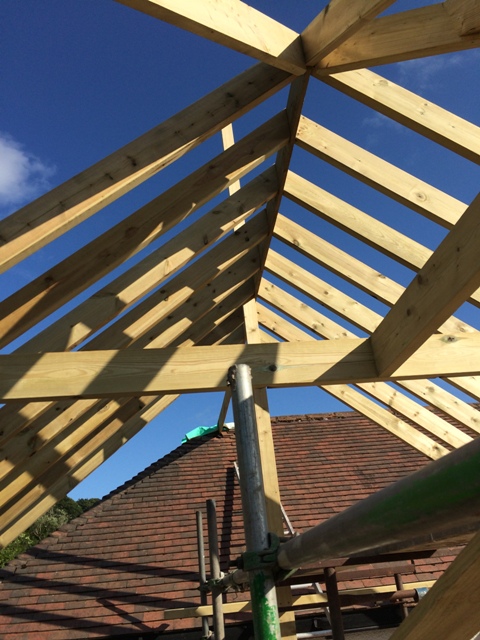

Kitchen roof so far

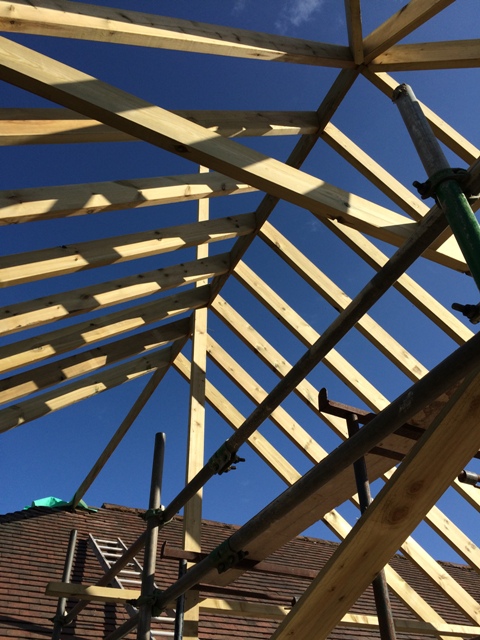

Kitchen roof so far picture 2

Kitchen roof so far picture 3

Progress day 23

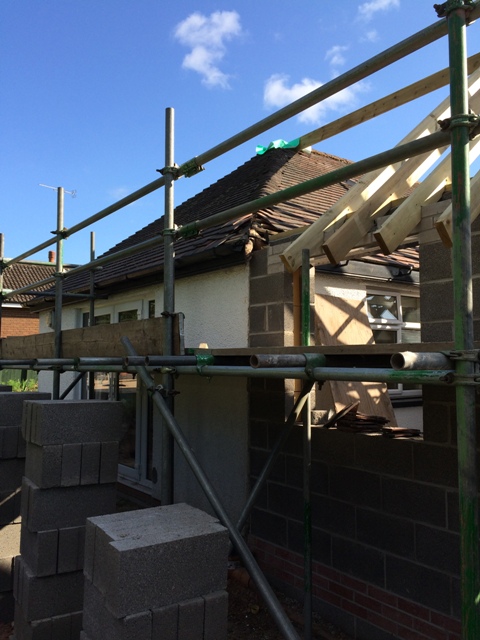

Progress day 23 picture 2
Day 24 – Monday 8th August 2016 – BATS
Our property is in an area that has potential for bats, therefore it was deemed necessary that we should have a bat survey carried out before any work could go ahead on the roof of the property.
We had dawn and dusk observations completed last year. During the first bat activity survey, Springdale was identified as a transitional/ day roost for a low number of common bats.
Therefore a Method Statement was drawn up which instructed us on how we must go about our new extension.
In hindsight we now understand what we did wrong.
This is what happened.
Some work to the roof has already been carried out without supervision of a bat licensed ecologist contrary to the licence conditions.
Everything is on hold. No further work can be carried out to the existing roof without supervision.
We have breached planning conditions and have been reported to Natural Resources Wales.
We must await their decision.

If anyone out there is in the same position, a word of warning – do not go ahead and touch the roof without a bat licensed ecologist being employed on site prior to works commencing and during any removal of roof tiles.
Read the Method Statement carefully. Our report was 29 pages long. The Method Statement was on page 17. So it is advisable to read it all.
The local authority have now also been informed of our breach of planning conditions.
We now also have a Shwegler 1 FE Bat Box on the garage as recommended and we will need to install another three on the front of the house on completion of the building.
Day 25 – Monday 15th August 2016
Work continues on the permitted part of the new roof. No parts of the old roof may be touched without supervision from a bat licenced ecologist.

Work on retaining wall begins

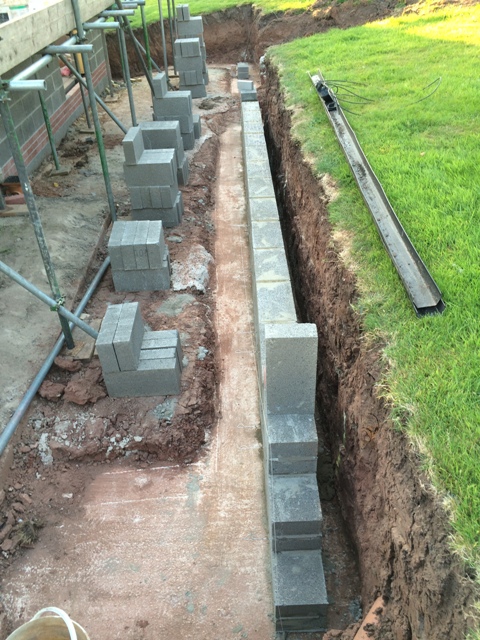

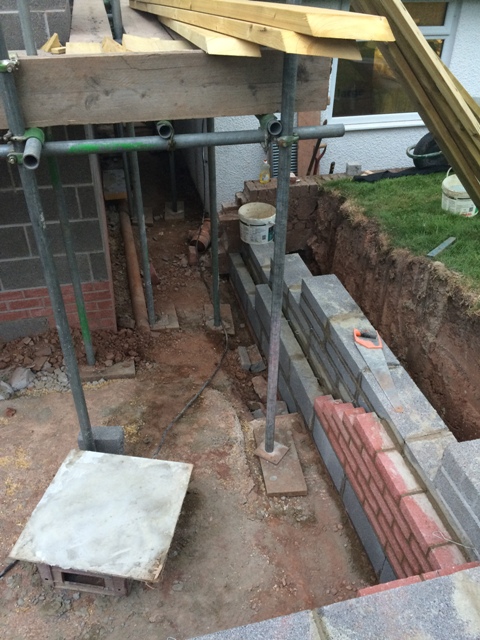

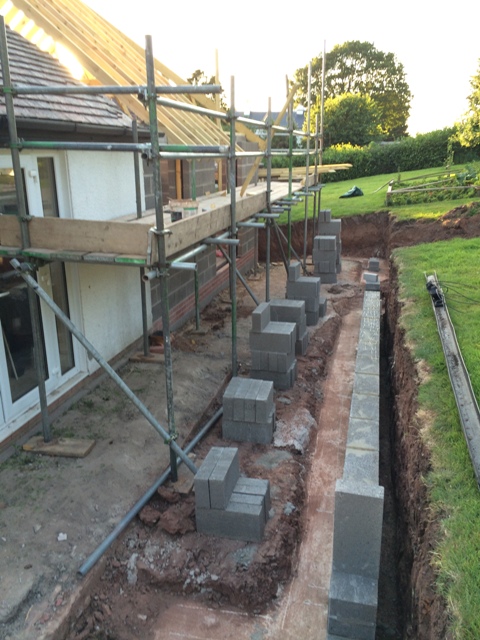

Retaining Wall

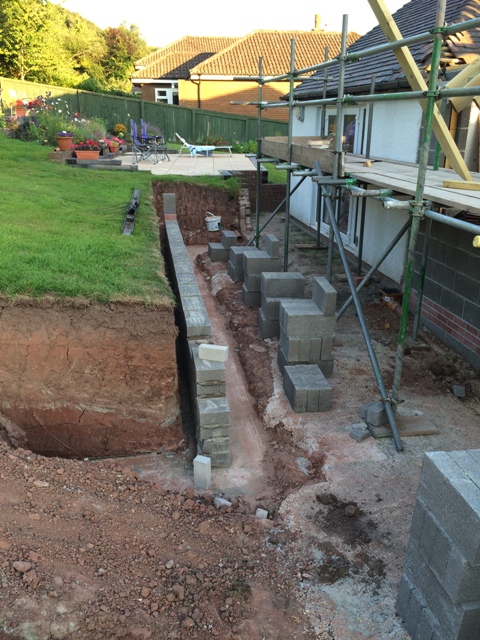

New retaining wall

Day 26 – Tuesday 16th August 2016
Progress on New Kitchen Roof

Progress of roof

Progress of roof 2

Progress of roof 3

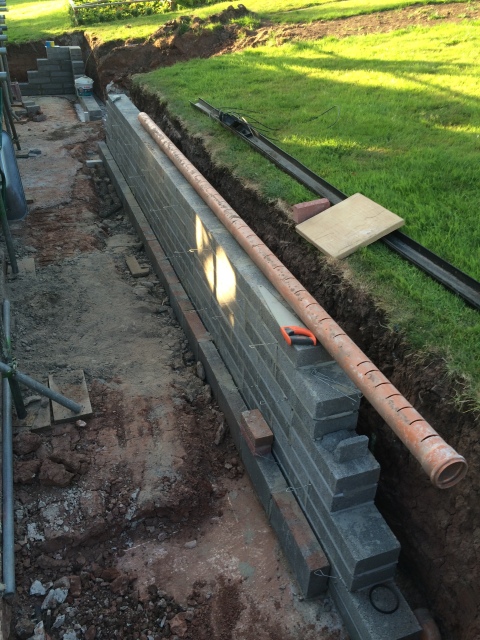

Retaining Wall and drainage
Day 27 – Wednesday 17th August 2016
Breach of Bat Licence
This is an extract of the email we were sent: I would like to take this opportunity to remind you that any breach of licence is considered to be a breach of the legislation, and we have a duty to act upon such cases, as this was reported timely and works have now halted to allow for the ecologist to be present, in this case please consider this a warning.
Should any further breaches occur we will have no option but to refer this matter to the police for investigation.
Therefore no work has been carried out, but can now continue once we have been supervised during tile removal.
Work today on the retaining wall
Day 28 – Thursday 18th August 2016

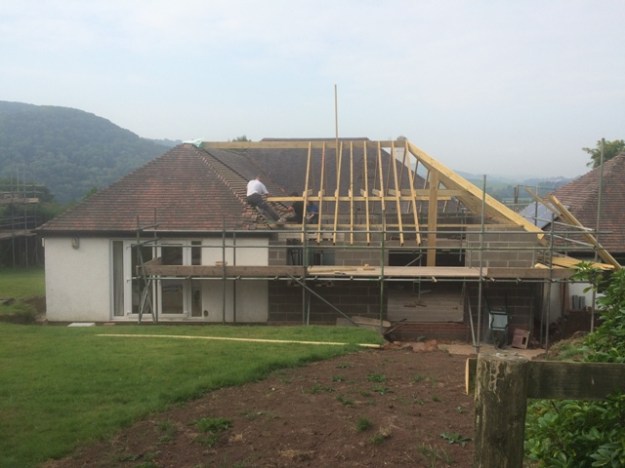

Removal of roof tiles with bat ecologist on site

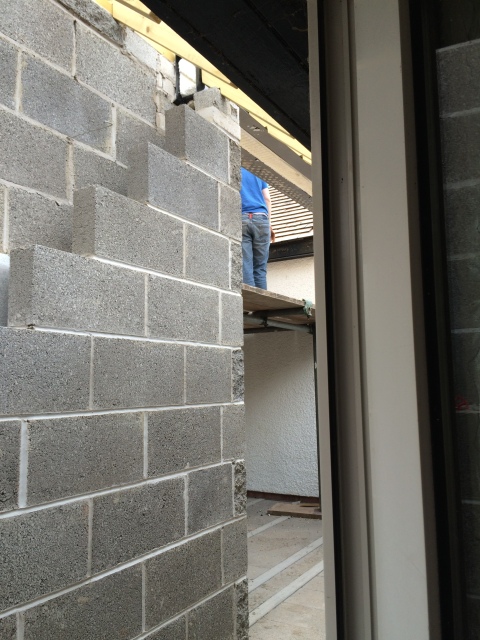

Ecologist on site

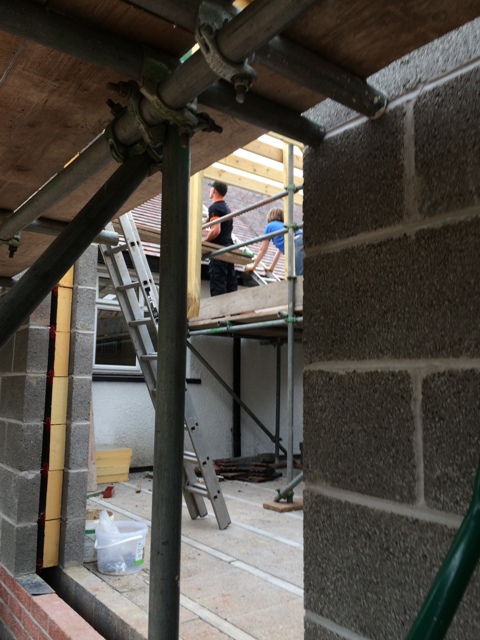

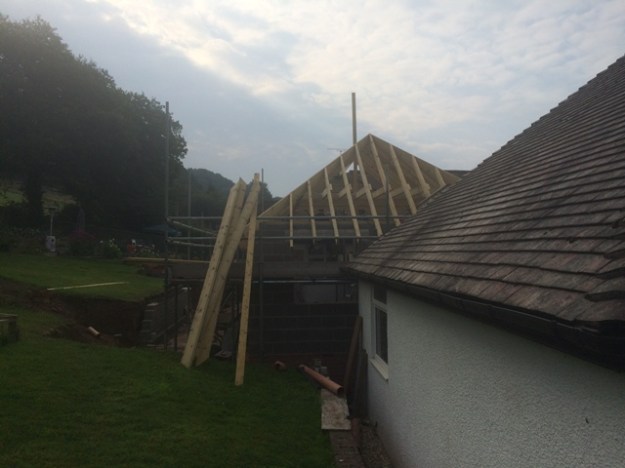

Tile Removal with supervision 2

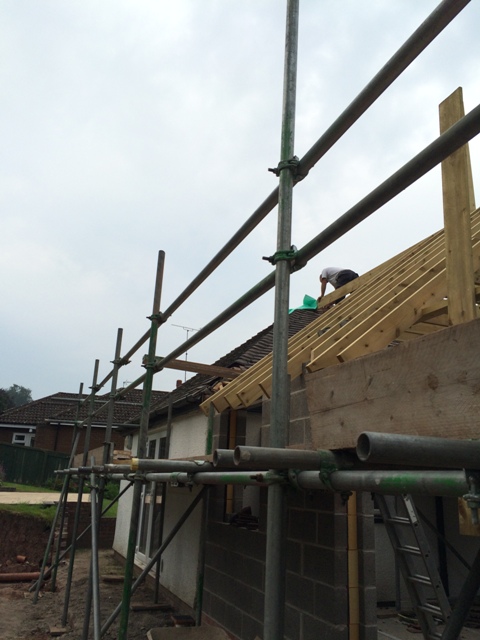

Tile Removal with supervision

Progress of retaining wall

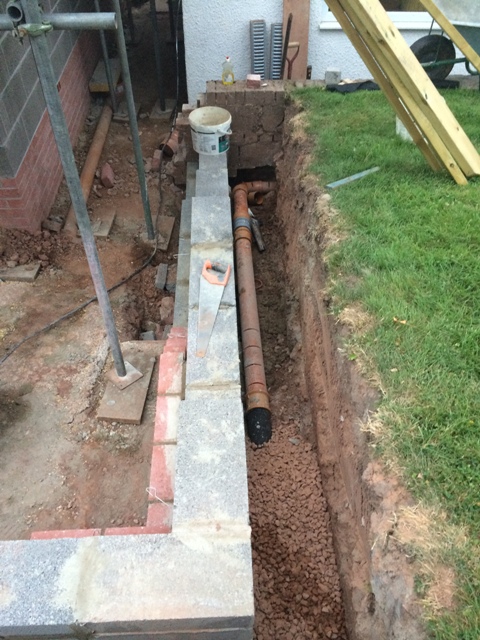

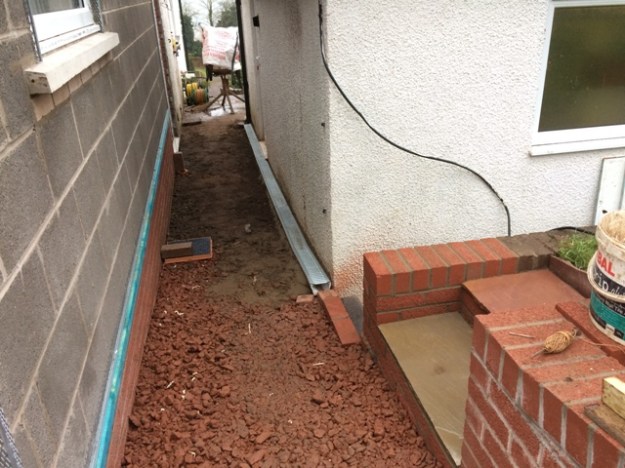

Ground drains

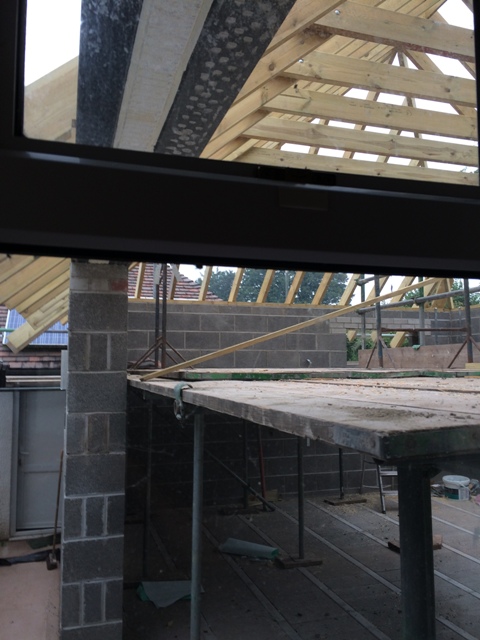

Inside Kitchen Area

Top of patio doors

Top of patio doors 2
Day 29 – Friday 19th August 2016

Rain! Heavy! No proper rain for a few weeks, till last night and this morning, just as all roof tiles have been removed – typical!
By lunch time rain was so heavy, the builder and his mate went home. Rain stops play again.

Filling back of retaining wall

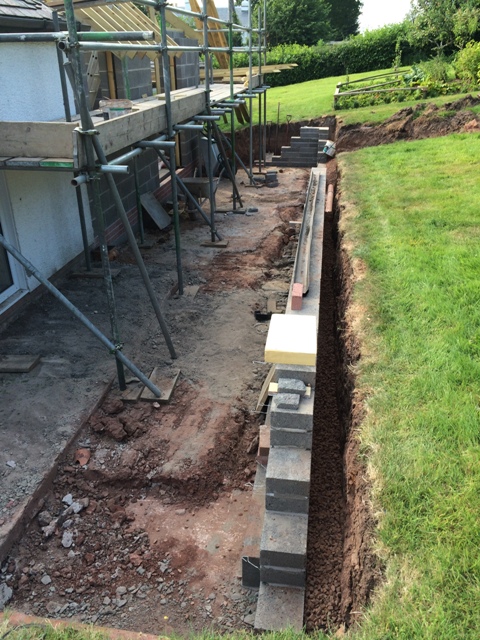

Retaining wall
Days 30 and 31 – Monday 22nd and Tuesday 23rd August 2016
Work concentrated on the retaining wall behind the new kitchen and the new step area that will give us quick access to the garden. The soil is clay and heavy, and although it has been well compacted over the years before its disturbance for this build, it needs to be held back with a strong wall.

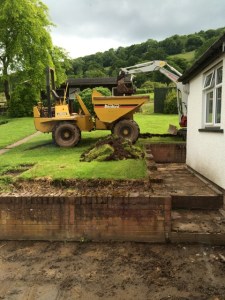

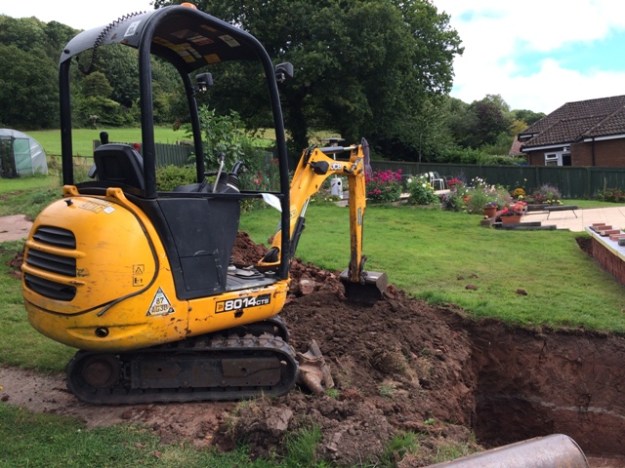

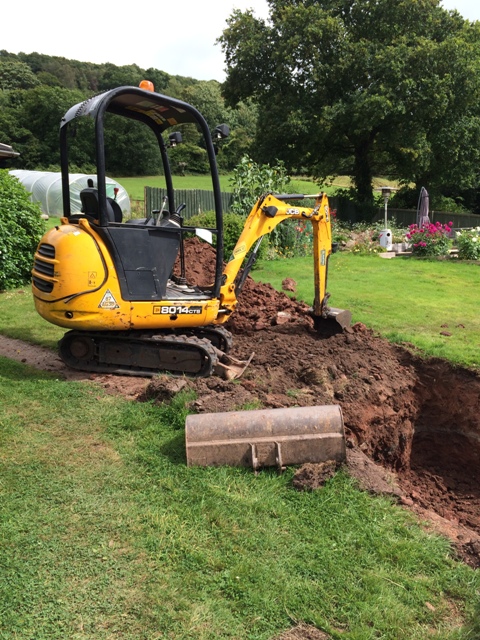

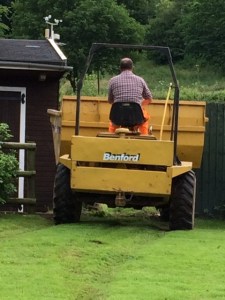

Digger to remove remaining soil for steps
As the height of the garden from the new patio is well above the ground level, about six steps will be required. This means more digging out to create space for the steps, also taking into consideration the width of each step and the drop of each step.

Digger removing remaining soil

View from bedroom

2nd View from bedroom
Day 32 – Wednesday 24th August 2016
Roofer and builder here today. Photos below of progress

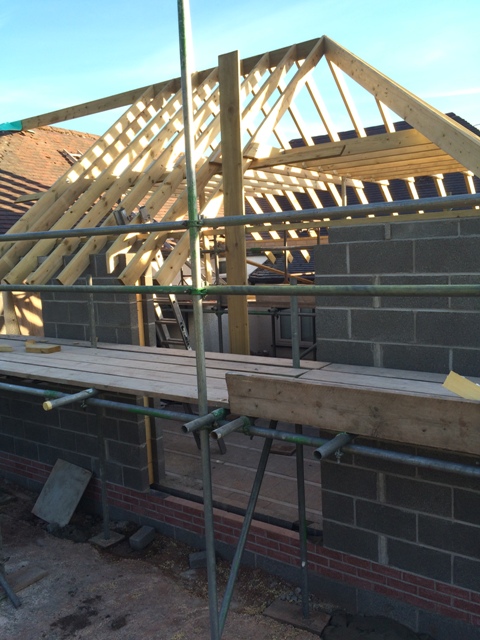

Roof progress

Roof progress 2

Wall and Step Progress

Wall progress
Day 33 and Day 34 – Thursday 25th and Friday 26th August 2016
Thursday was fine first thing, then heavy rain stopped the work

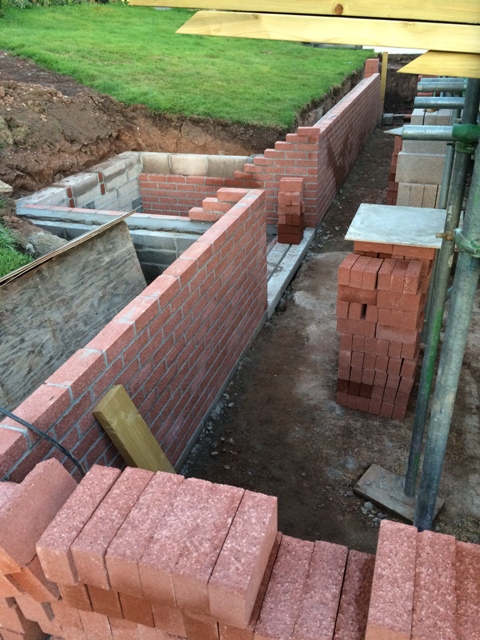

Retaining Wall and Steps

Step progress 2

Step progress

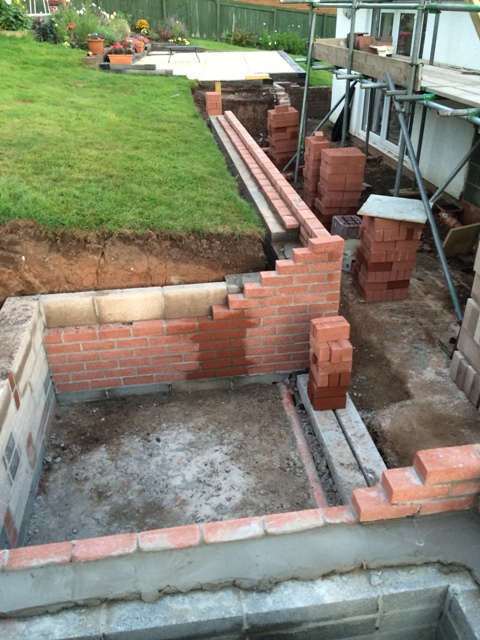

Wall progress

Wall progress 2
Day 35 – Saturday 27th August 2016
Although the weekend the roofer continued work today.

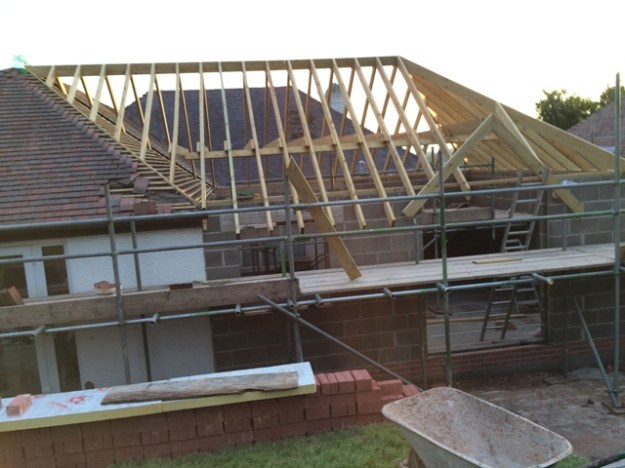

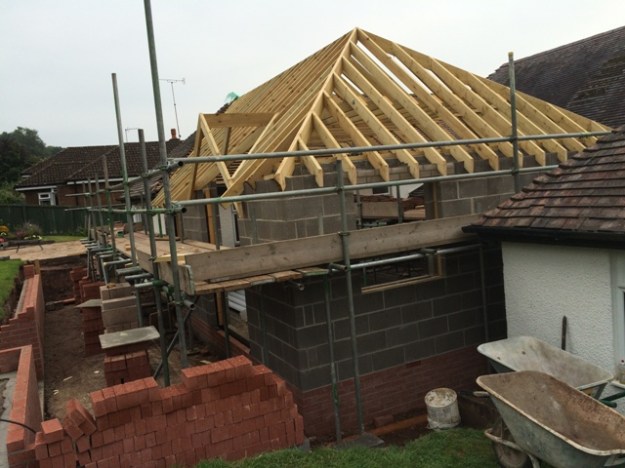

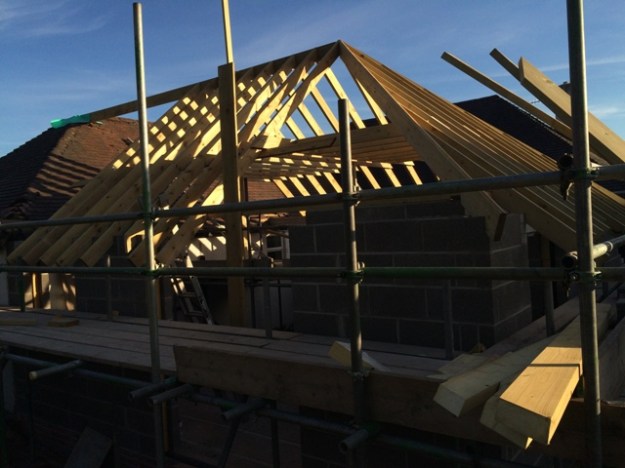

Roof Progress

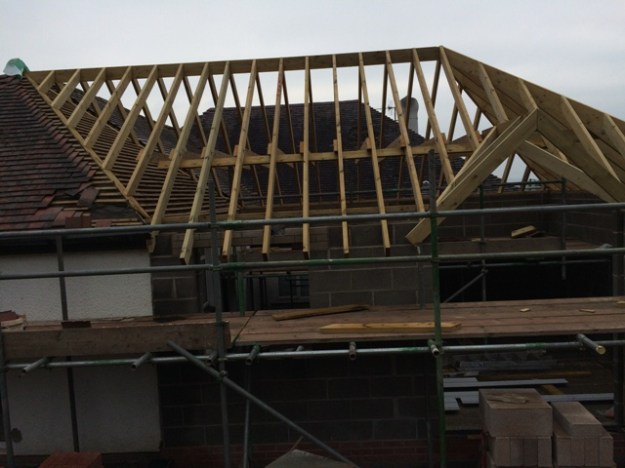

Roof Progress 2

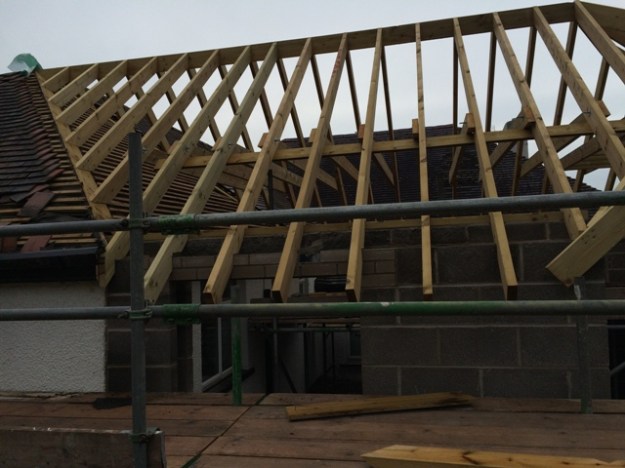

Roof Progress 3

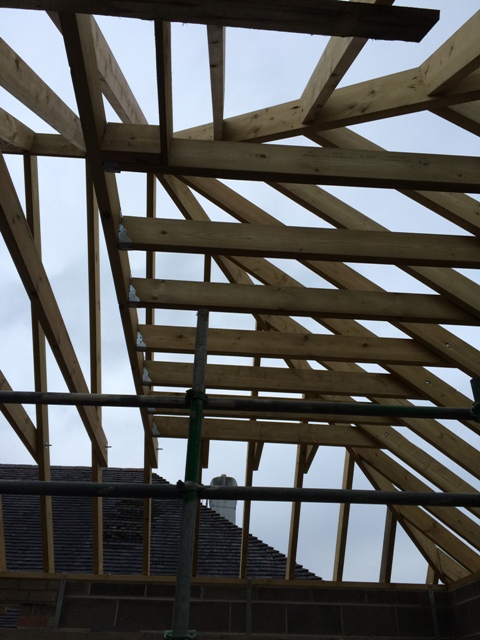

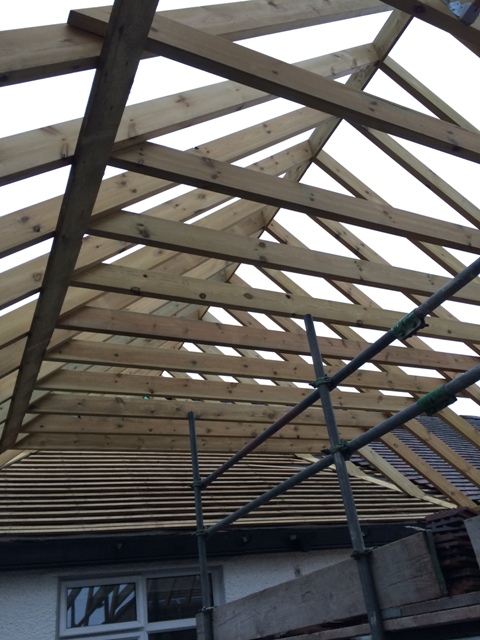

View up to new ceiling height in kitchen

View up to new ceiling height

View down to new step area and new kitchen extension
Day 36 – Tuesday 30th August 2016
Batons and roofing felt was delivered today.
More work on the retaining wall and steps.

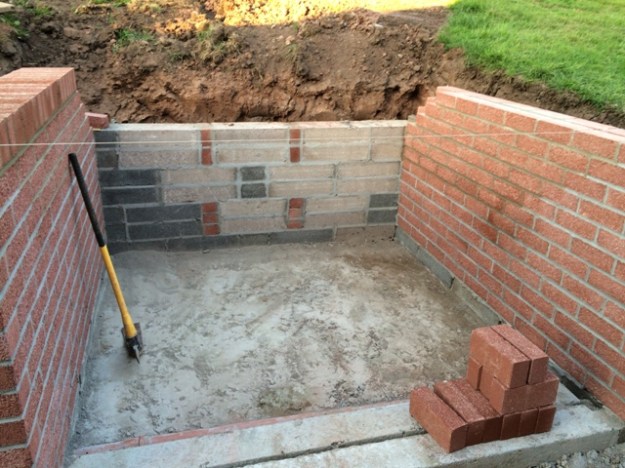

Step area

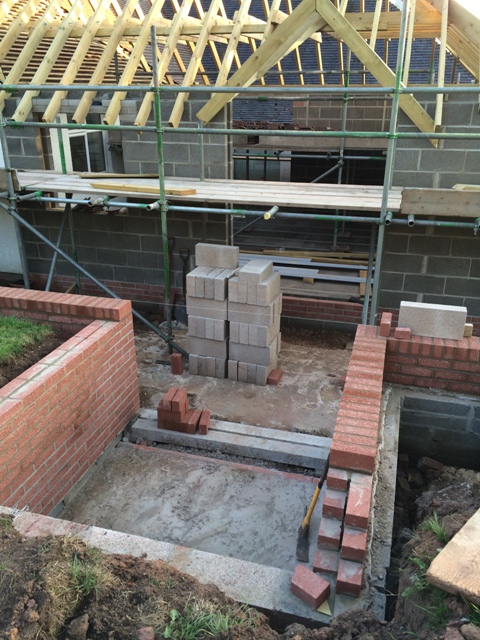

View from above of the new steps area

Another view of retaining wall

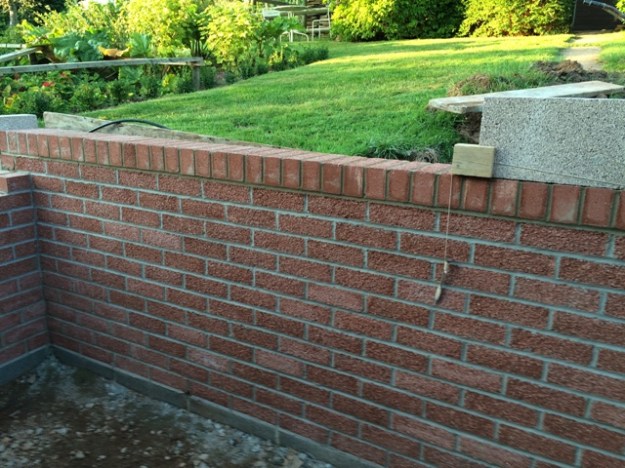

Wall from new patio area

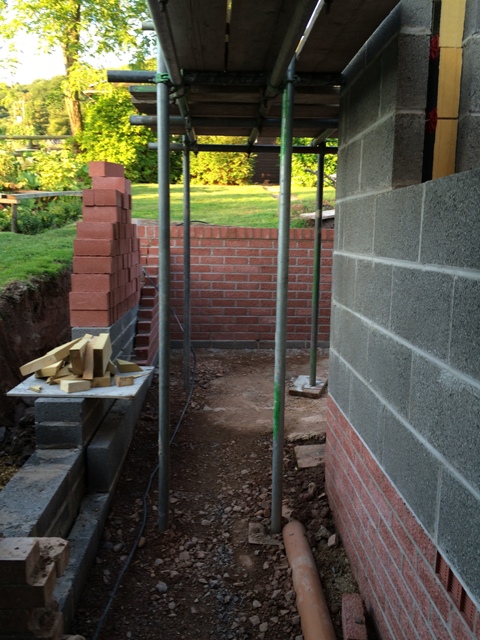

Wall view from side of garage
Day 37 – Wednesday 31st August 2016
Building Control Officer visited today to check on progress.

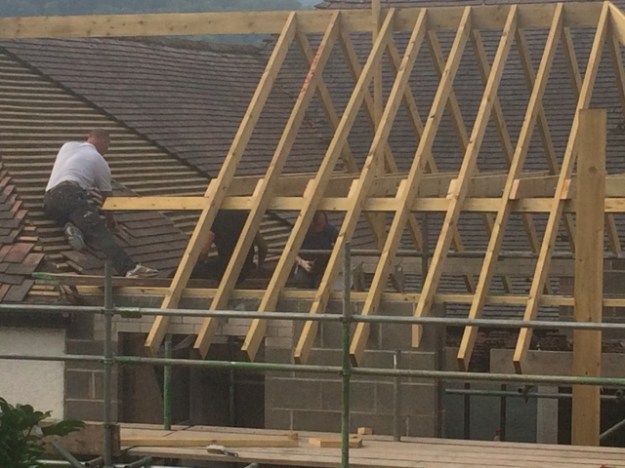

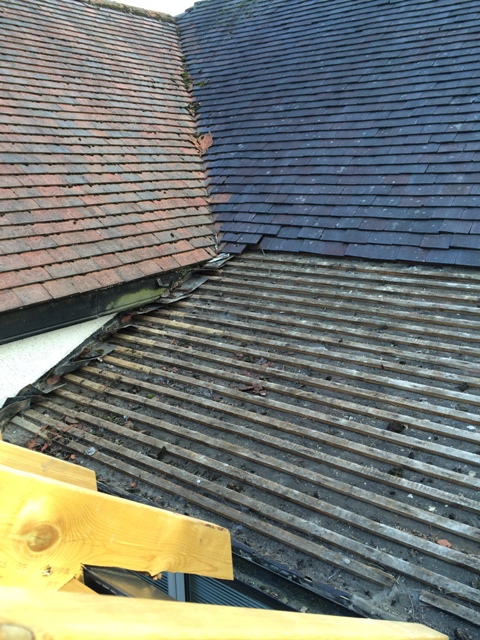

Also Bat licenced Ecologist came in the afternoon to supervise the removal of tiles from existing utility room roof and small bedroom roof as required by the bat licence.

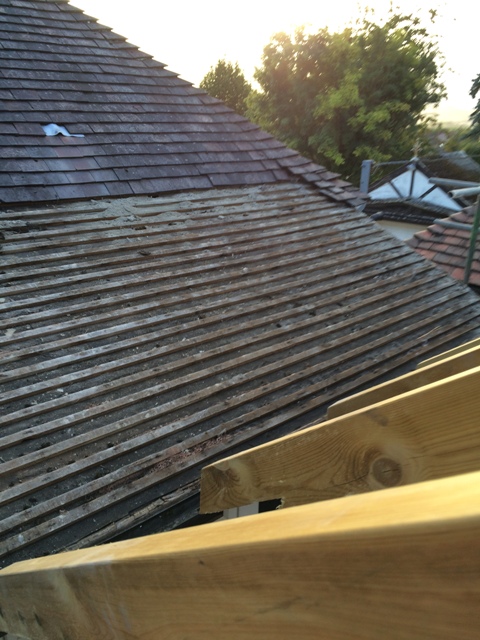

Tiles removed over the utility room, picture taken from scaffolding

Tiles removed from roof over small bedroom, this will be a new bathroom, picture taken from scaffolding

Another view over utility room roof where tiles have been removed under supervision of bat ecologist

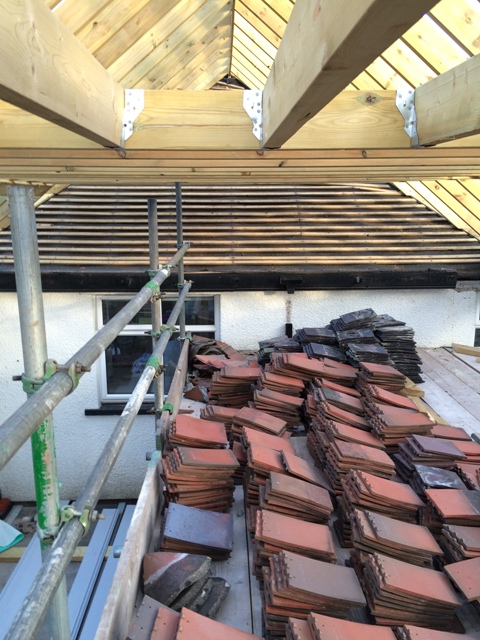

Up on Scaffolding – Tiles all removed from old existing roof over utility room and small bedroom

View to main roof over existing master bedroom, this will be the new lounge

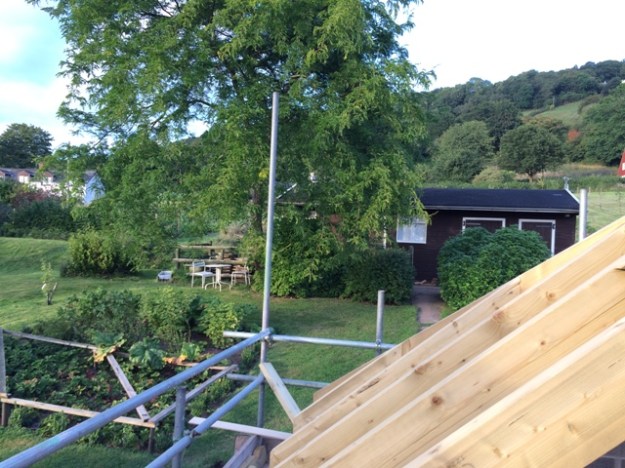

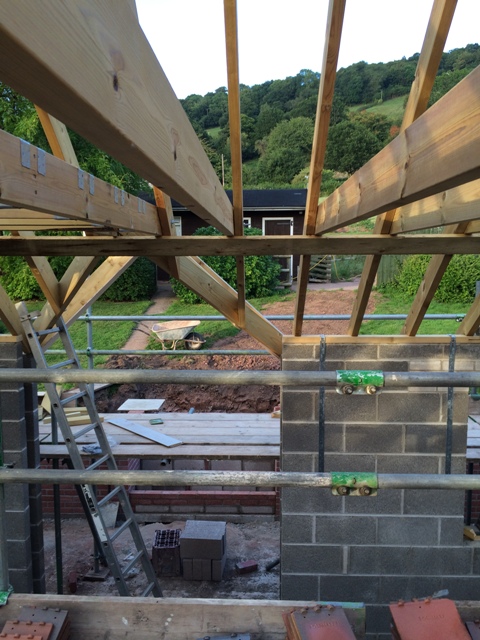

View to garden from scaffolding above new kitchen

View to back garden from scaffolding over new kitchen

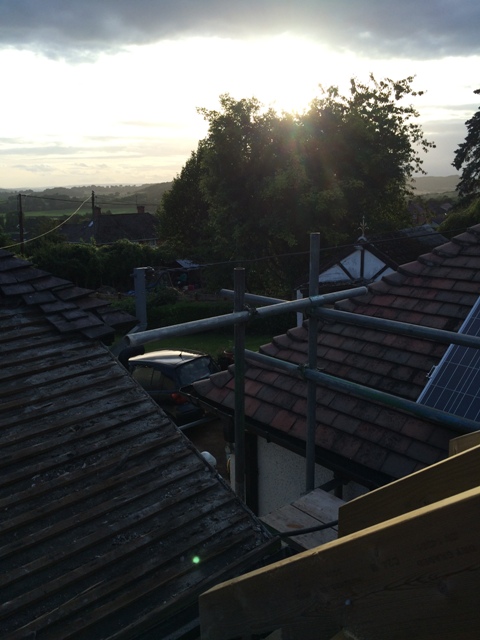

View from scaffolding

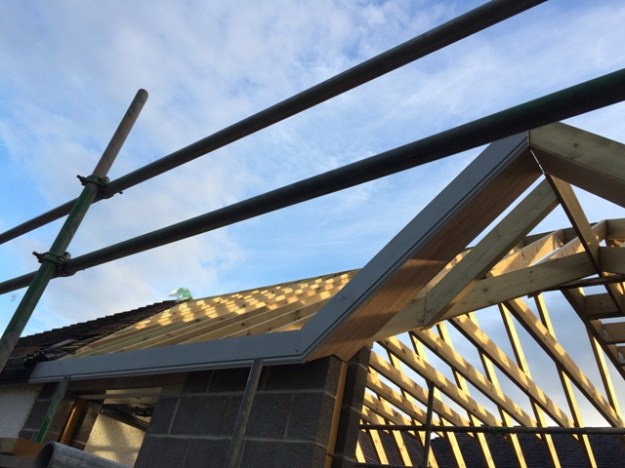

New Fascia board partly in place over position for patio doors

Progress on the new step area from patio
Day 38 – Thursday 1st September 2016
Progress on steps today

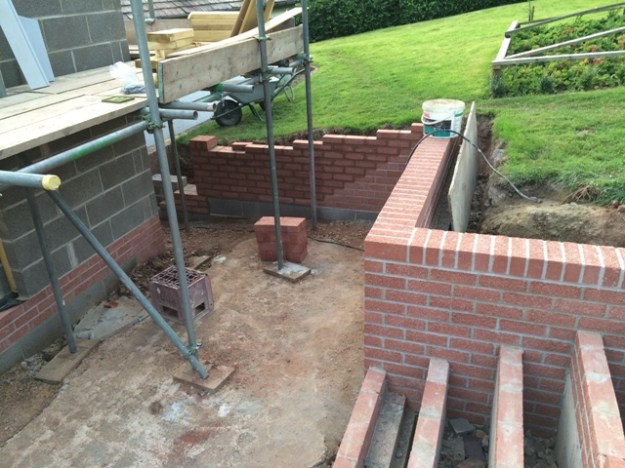

Step progress

Step progress 2
Saturday 3rd and Sunday 4th September 2016
Heavy, heavy rain

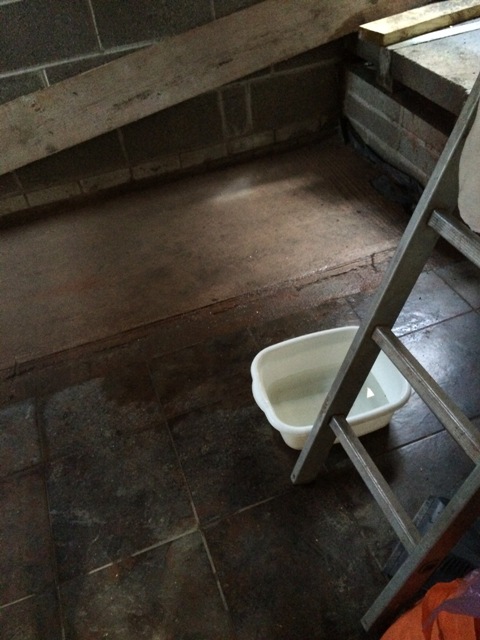

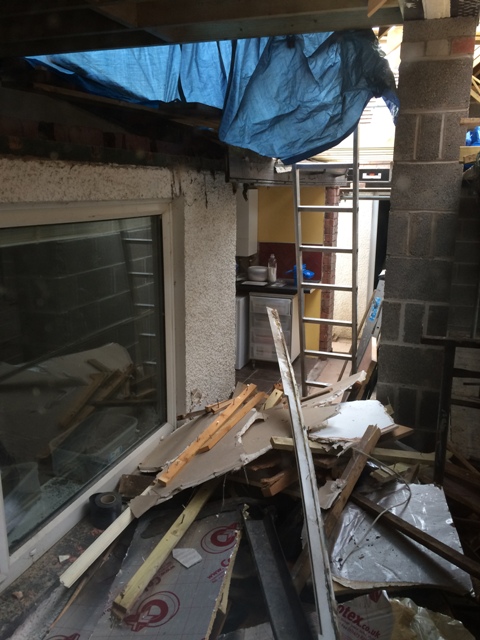

This resulted in a lot of leaking rain water finding its way into the utility room and the small bedroom.

Saturday-3rd-September-small-bedroom-roof-leaked-badly-tiles-have-been-removed

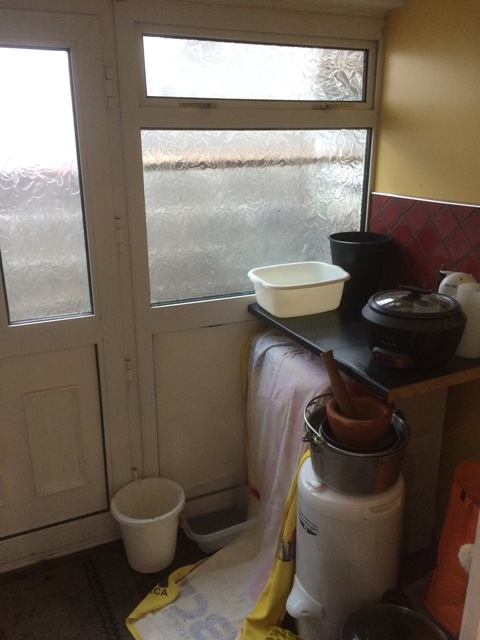

Saturday-3rd-September-utility-roof-leaked

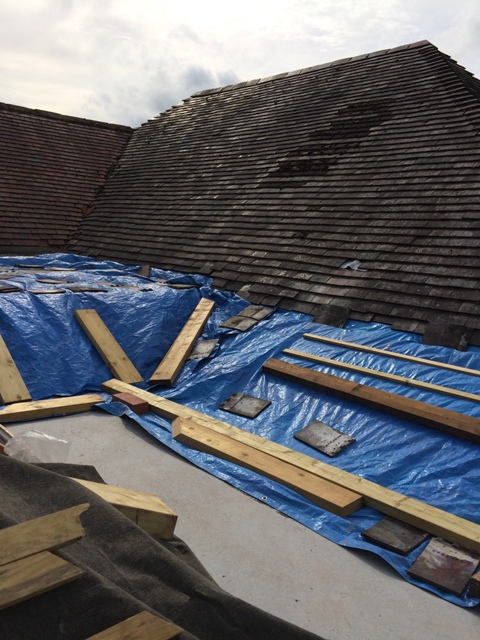

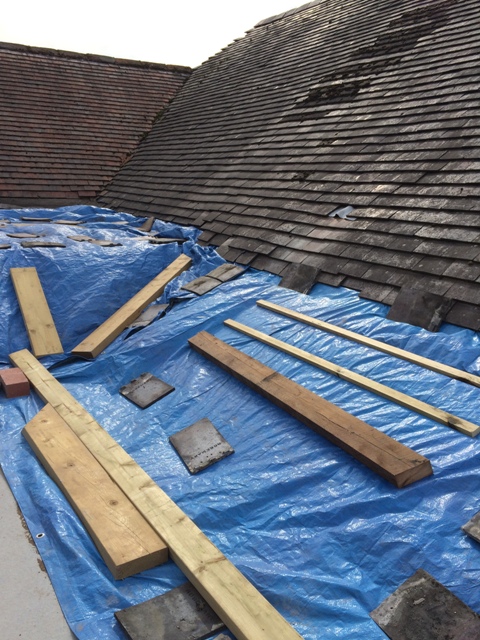

Sunday – tarpaulins now in place over old roof
Day 39 – Monday 5th September 2016

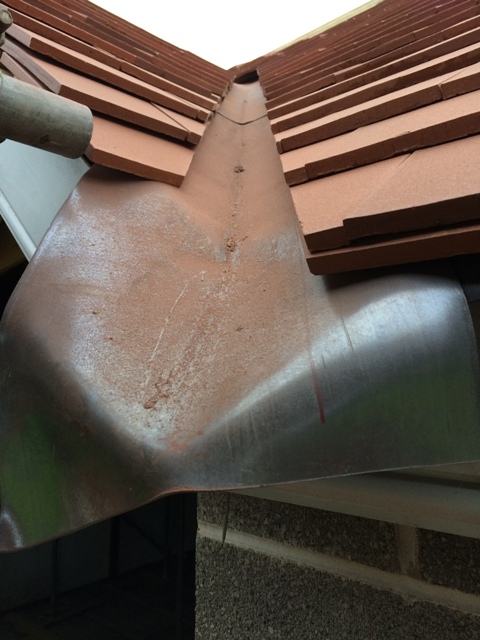

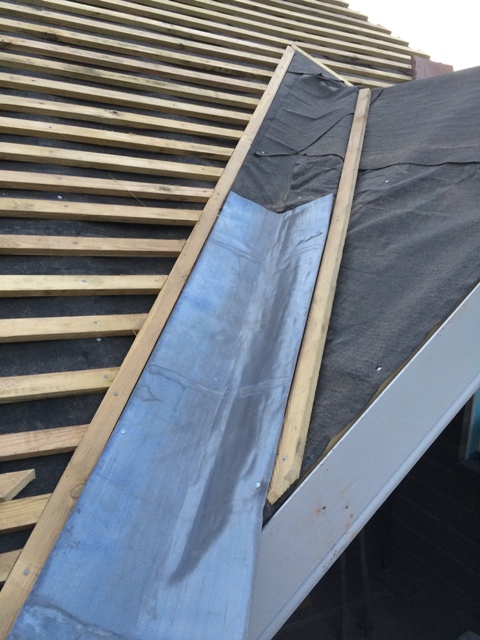

Today the roofer returned and completed the valleys on the hips of the roof. Also the fascia board was completed. The builder added vents to allow air into the roof space and any water vapour to escape. We are not allowed to have breathable membrane on the roof as it may harm any potential bat visitors.

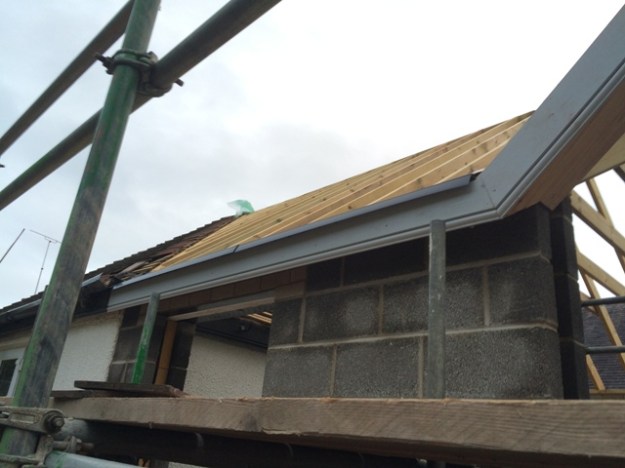

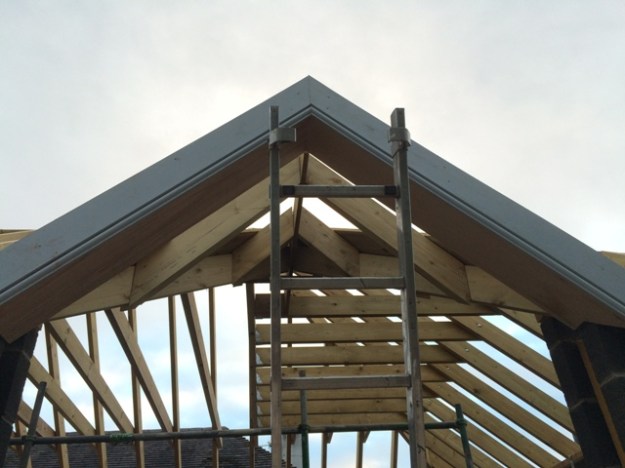

Fascia Board

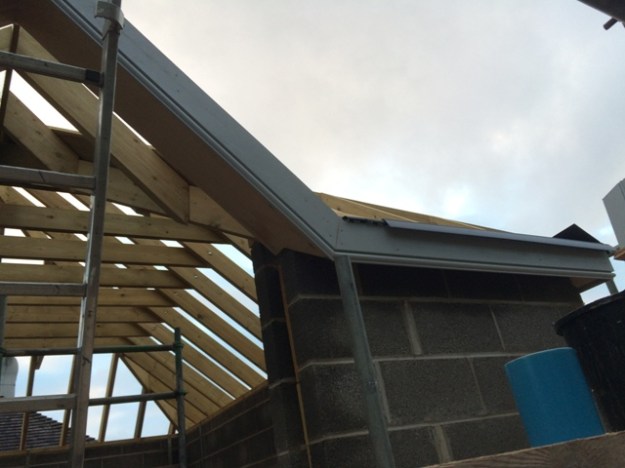

Fascia Board 2

Fascia Board 3

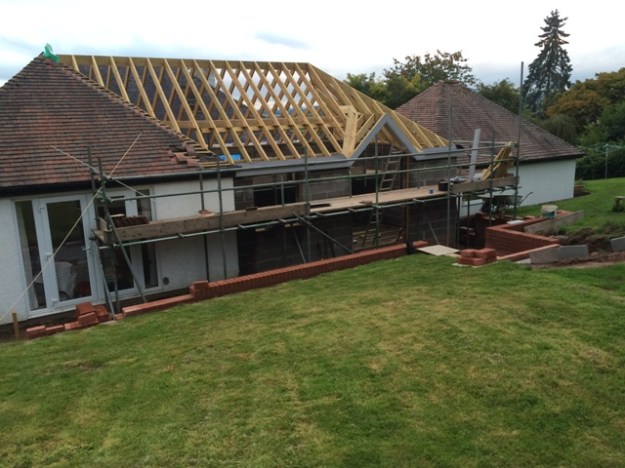

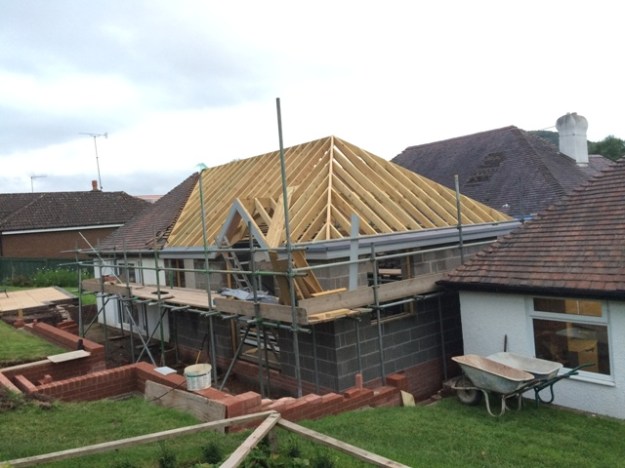

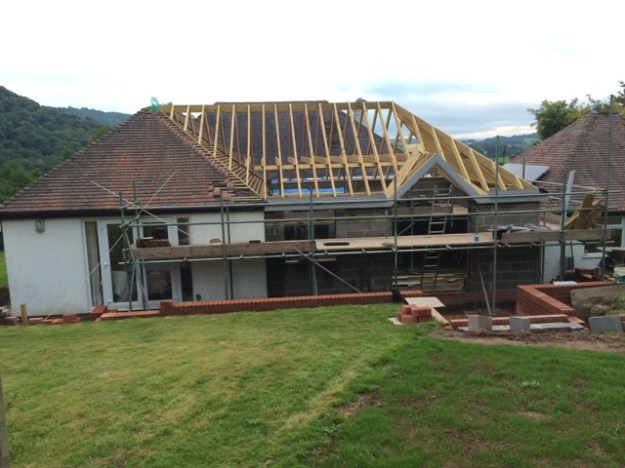

back-of-house-progress-so-far-day-39

back-of-house-progress-so-far-day-39-another-angle

back-of-house-progress-so-far-day-39-another-angle-2
Day 40 – Tuesday 6th September 2016
Main steps are really taking shape now. Also felt and battening on the roof began.

Main-steps-now-back-filled-and-with-concrete

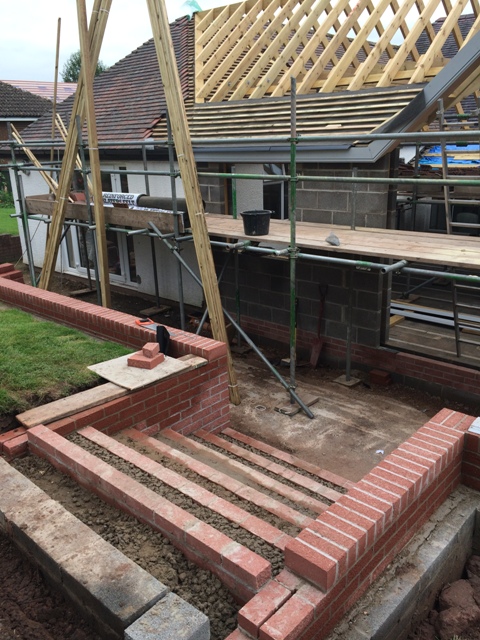

Main-steps-filled-with-concrete-and-view-up-to-roof-where-felt-and-battening-has-begun

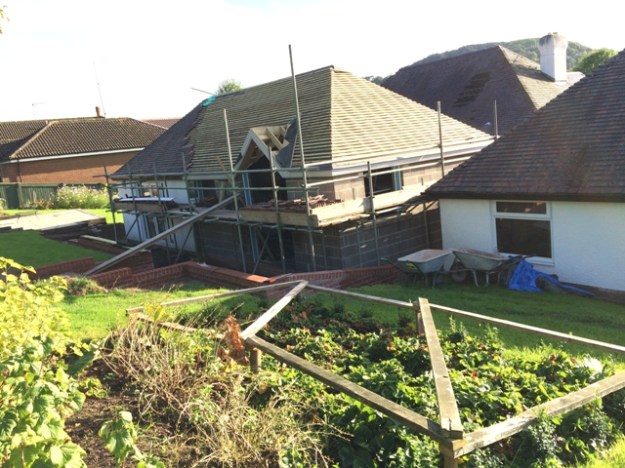

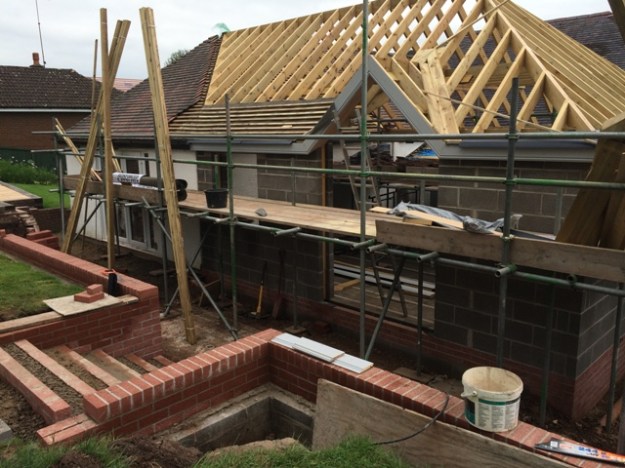

Main-steps-and-roof-view-progress-so-far
Also the builder collected fibre glass coated board for part of the flat roof that will eventually be over new utility room and new bathroom.
Day 41 – Wednesday 7th September 2016

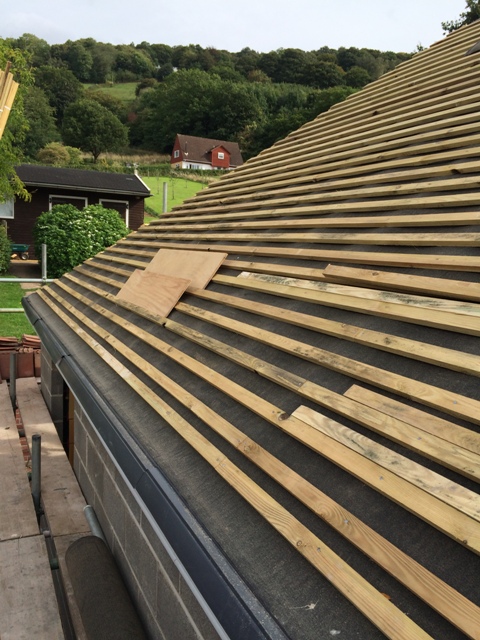

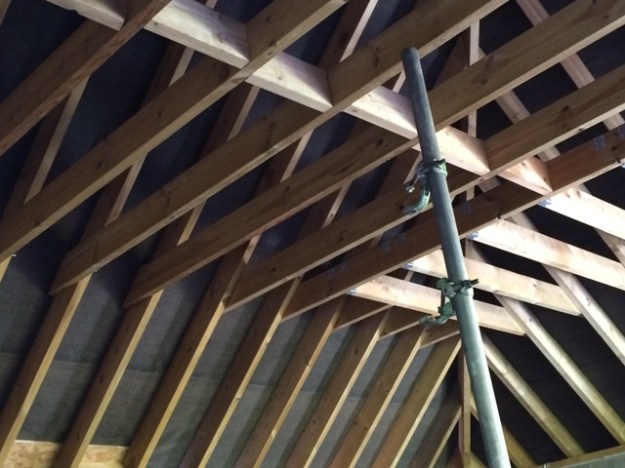

Felt and battening going up onto new kitchen roof.

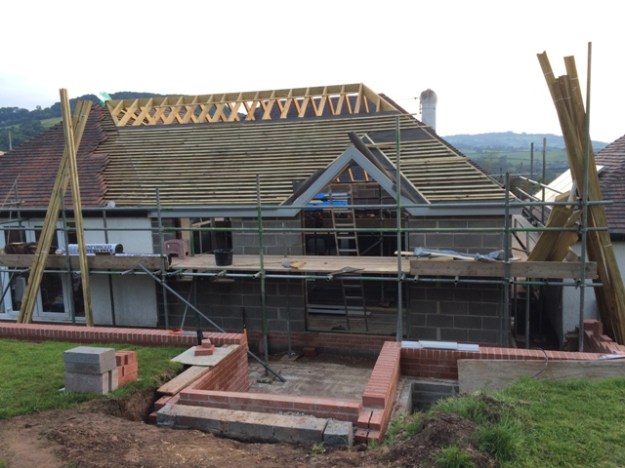

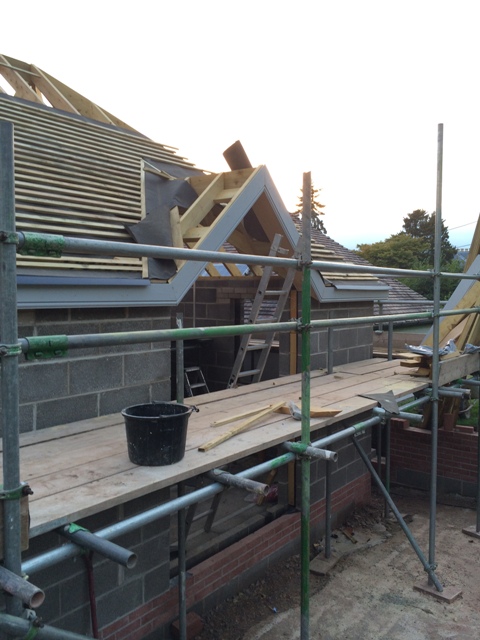

felt-and-battening-progress

felt-and-battening-progress-2
Day 42 – Thursday 8th September 2016
Progress of retaining wall and back view of house

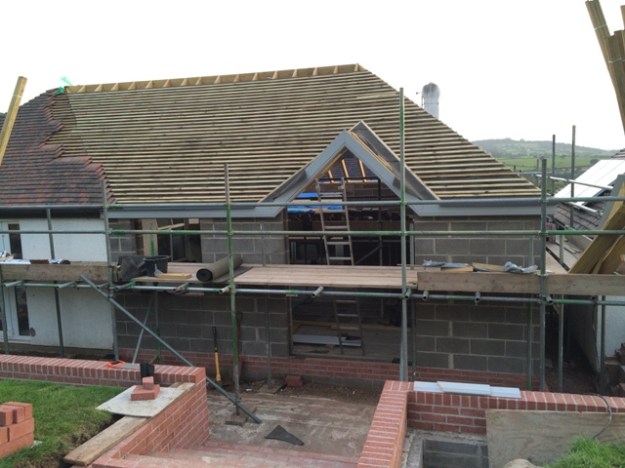

roof-and-walls-of-steps

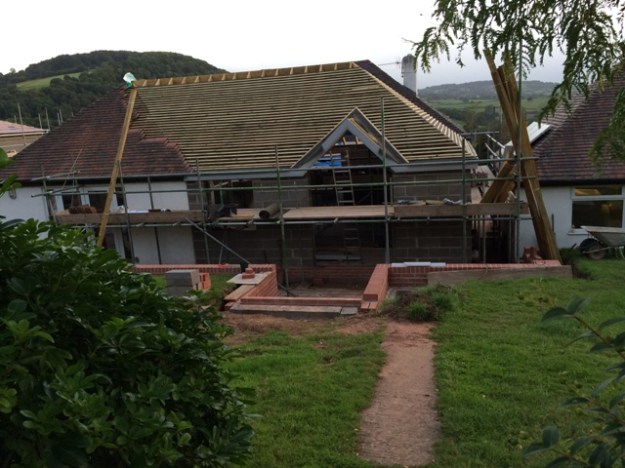

view-of-new-extension-from-back-garden
Days 43 and 44 – Friday 9th September and Monday 12th September 2016
Views of progress on steps and extension

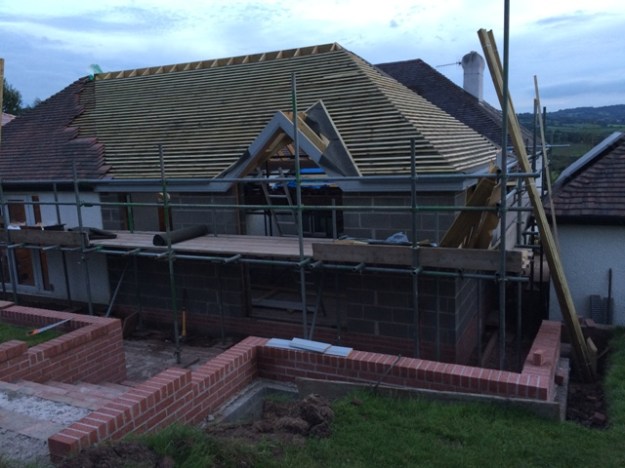

back-view-of-kitchen-extension

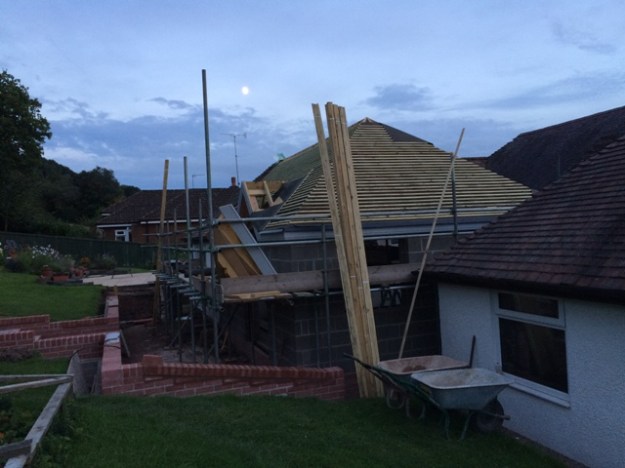

side-view-of-new-extension

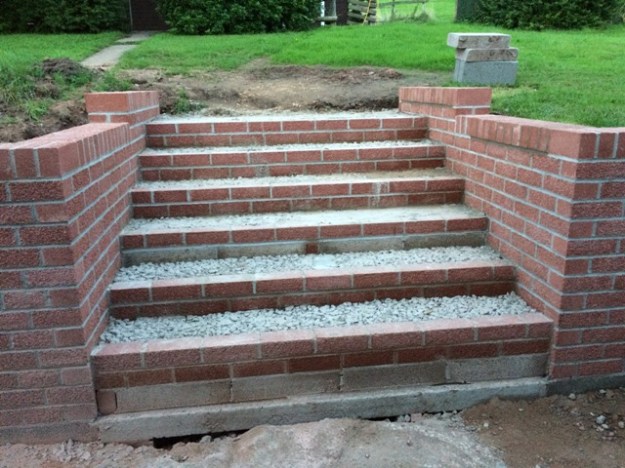

new-main-steps-progress-so-far
Day 45 – Tuesday 13th September 2016

Thuderstorms wet-room-roof-leaking-again

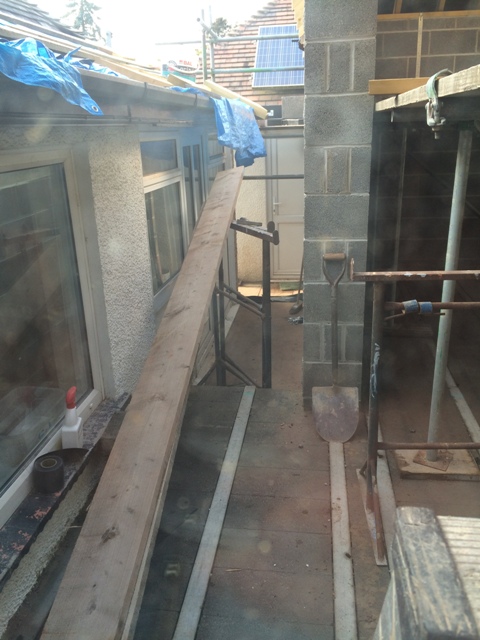

view-to-new-lintel-above-position-of-backdoor

view-through-extension-from-old-small-bedroom

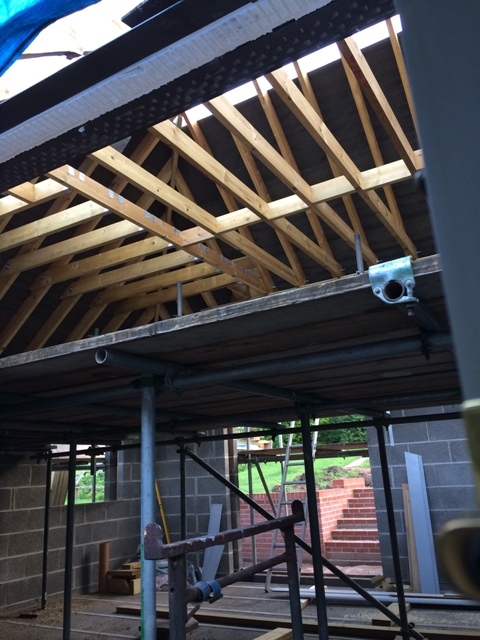

inside-new-kitchen-extension-view-of-roof-area

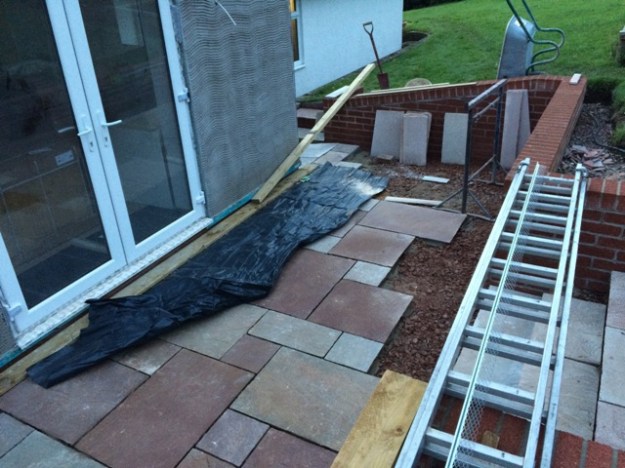

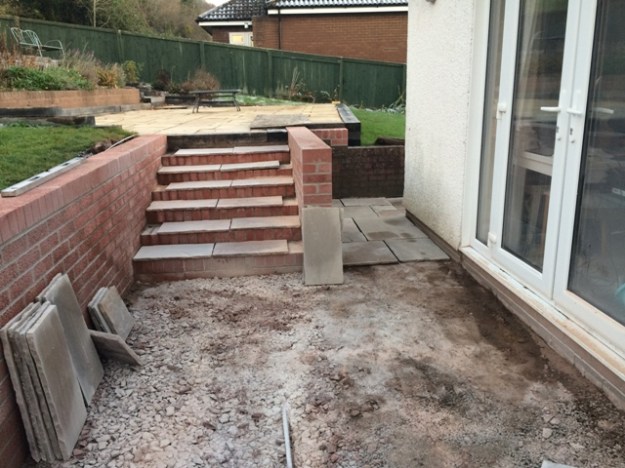

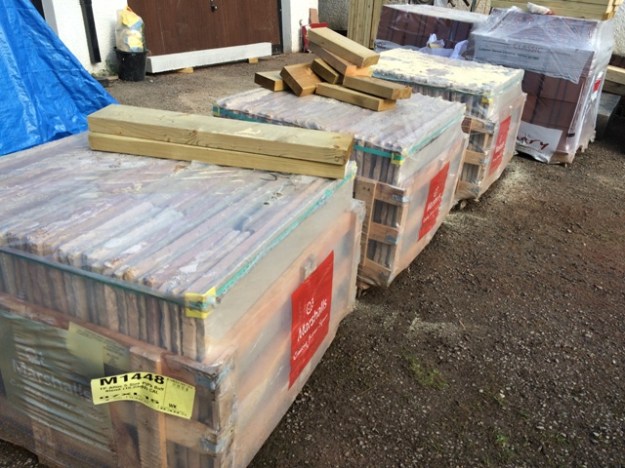

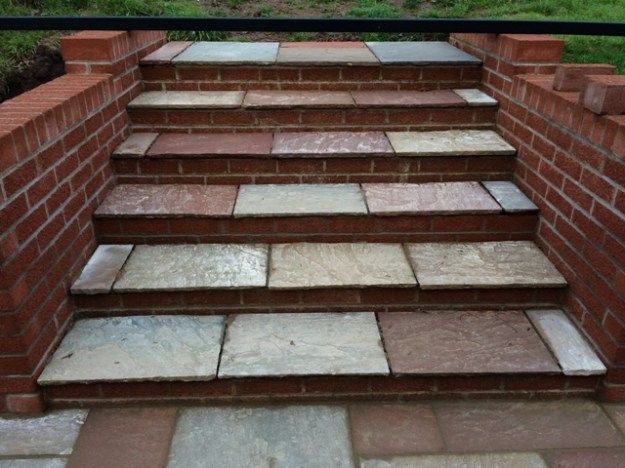

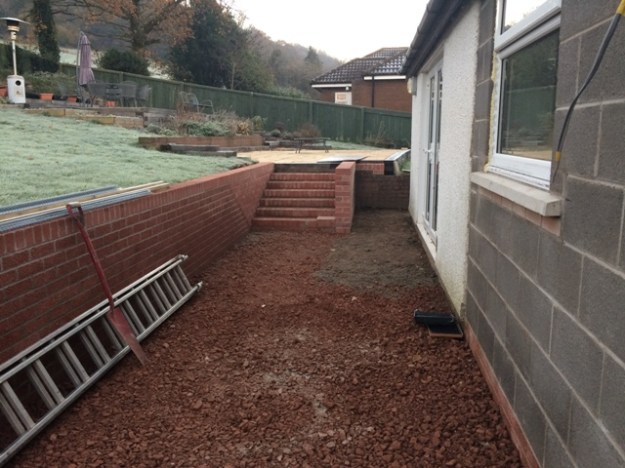

new-slabs-for-patio-and-steps
Day 46 – Wednesday 14th September 2016

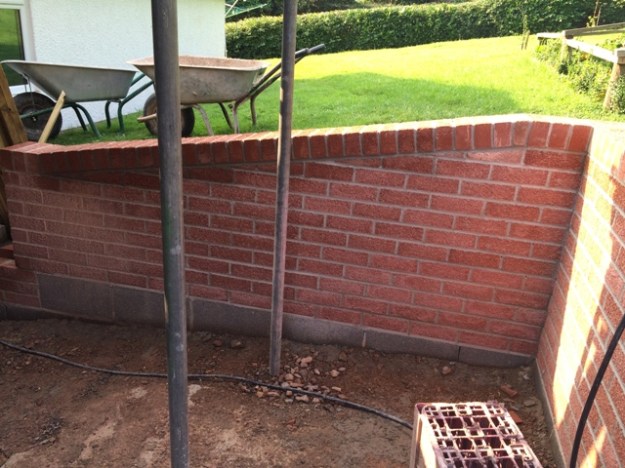

sloping-wall-corner-to-side-and-rear

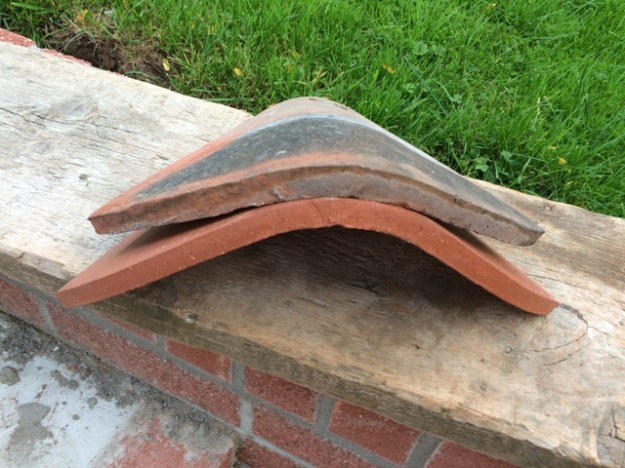

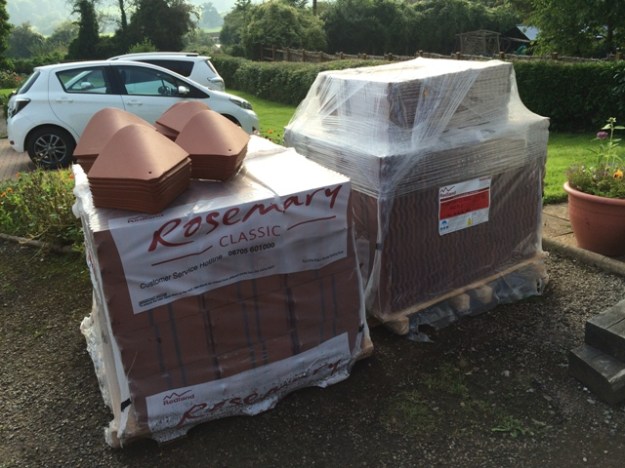

rosemary-tiles-for-new-roof-matching-old-tiles

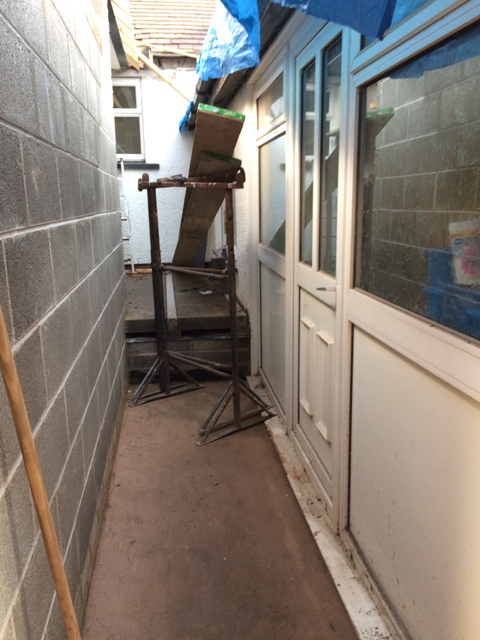

new-entrance-to-house-via-back-door-into-utility

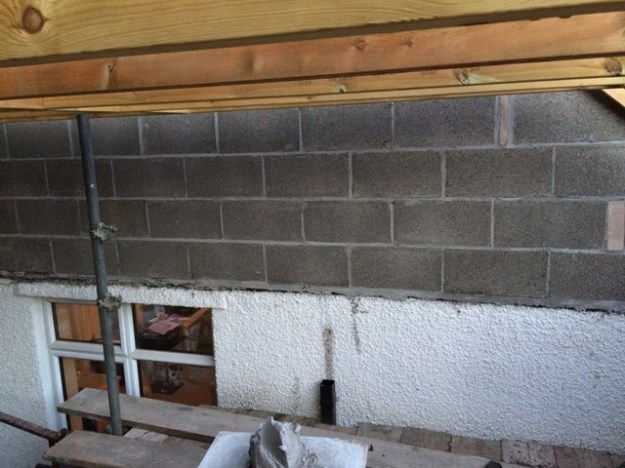

Block work now built up higher on left side of utility

lintel-above-new-back-door-area
Day 47 – Thursday 15th September 2016
The start of the disruption in our living space.
New supporting beams being inserted joining old house to new extension.

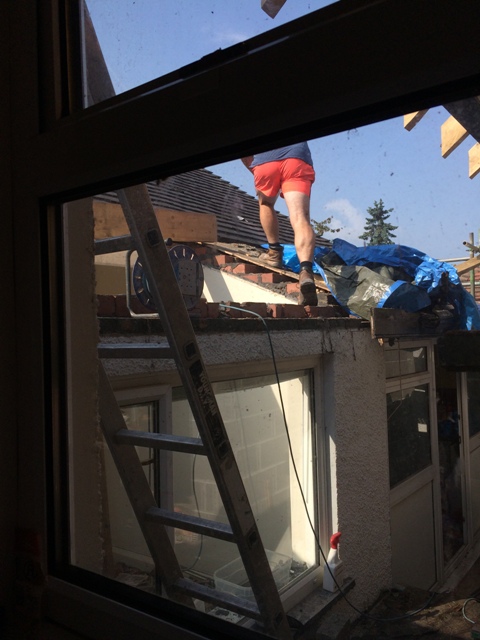

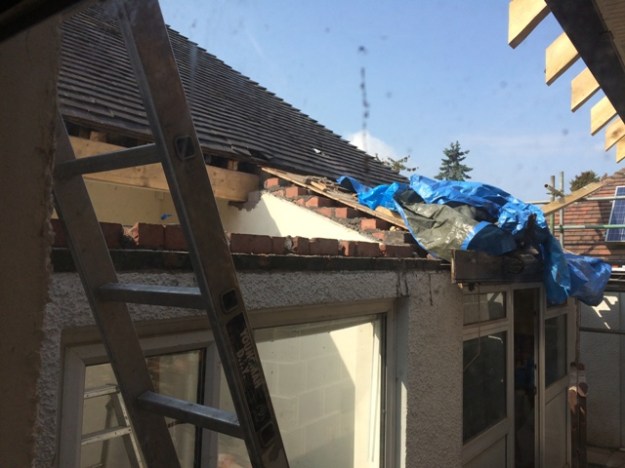

small-bedroom-roof-removed

small-bedroom-roof-removed-2

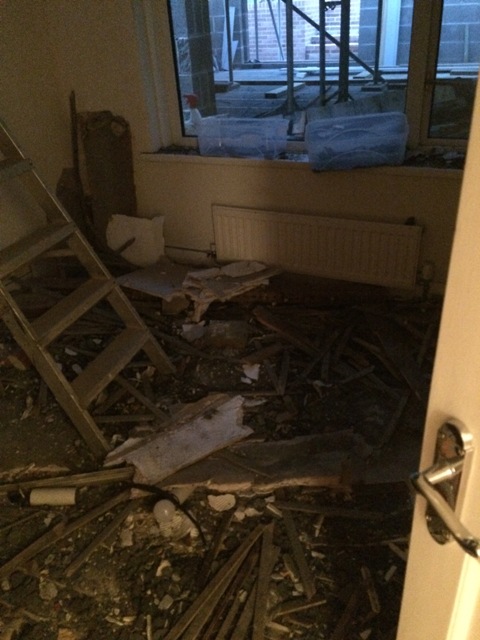

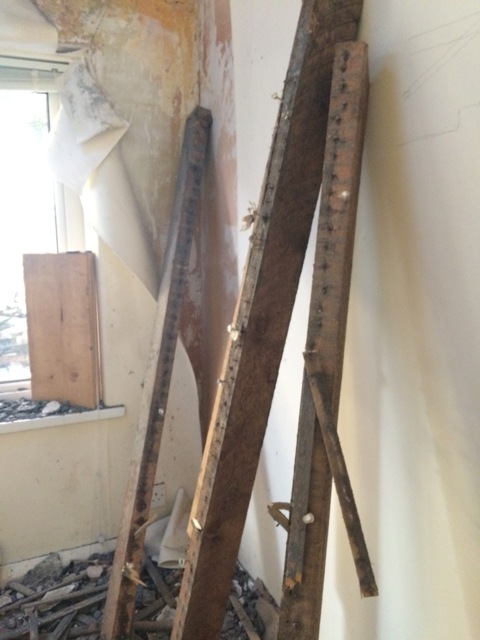

inside-small-bedroom

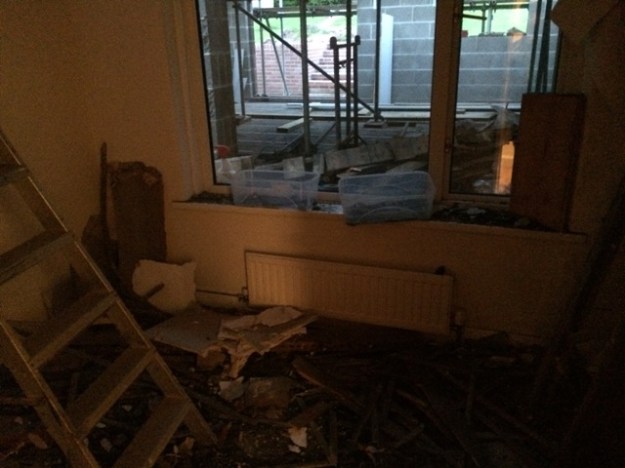

inside-small-bedroom-2

hallway-untouched-as-yet-new-supporting-beam-not-required-here-luckily
Day 48 – Friday 16th September 2016
New beams joining old building to new extension, supports for roof

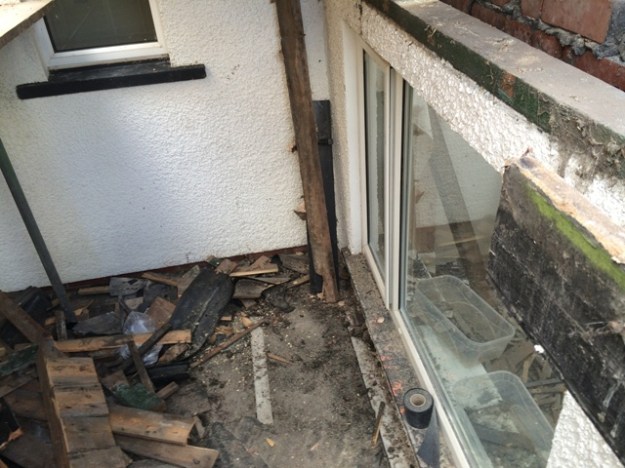

area-which-will-be-walk-way-into-new-kitchen-from-back-door-beside-old-bedroom-note-large-difference-in-floor-height-steps-will-be-needed

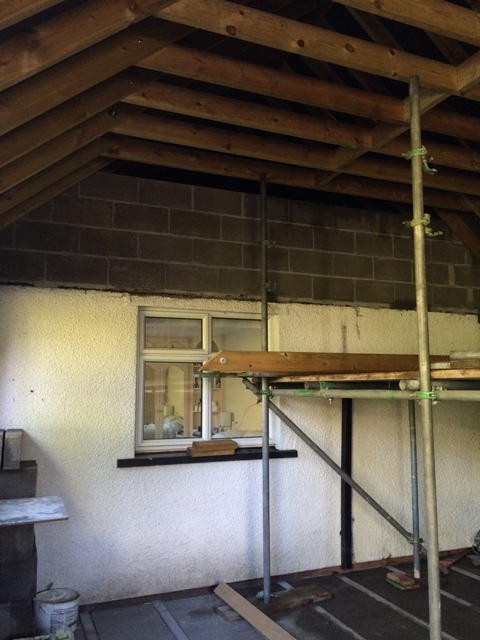

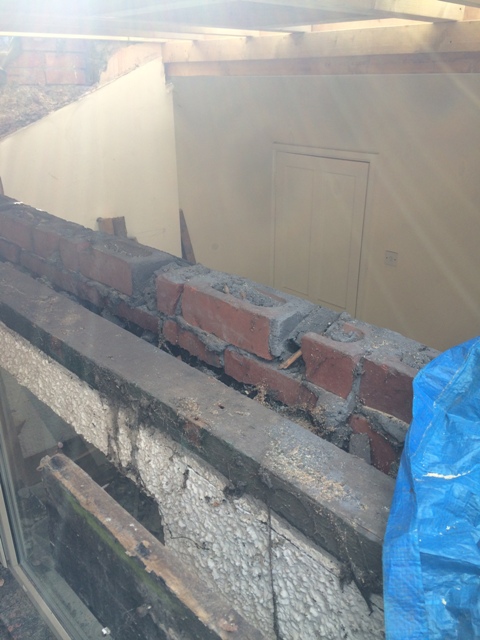

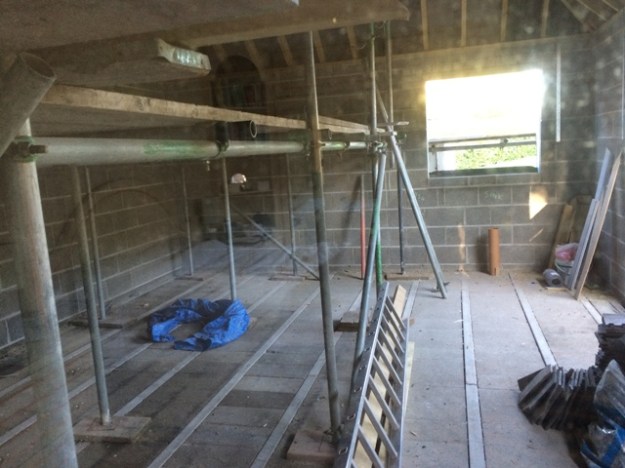

view-from-ladders-over-window-into-old-small-bedroom-with-ceiling-removed

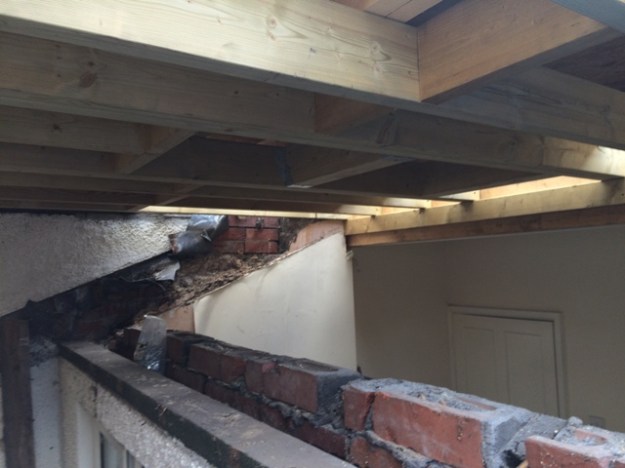

view-of-new-beams-now-in-place-for-new-roof-over-old-small-bedroom-soon-to-be-family-bathroom

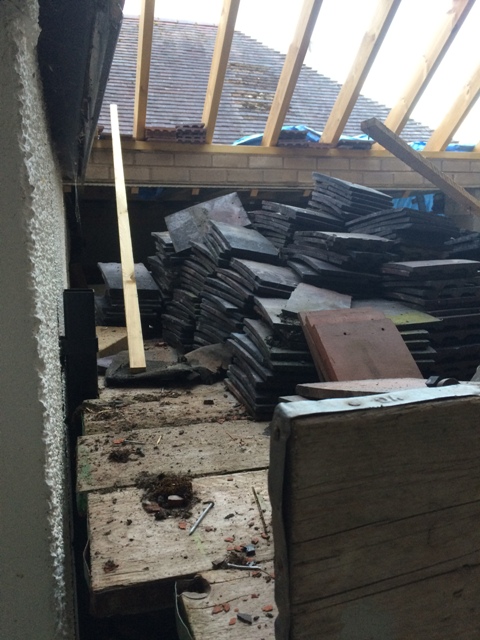

tiles-on-scaffolding
Day 49 – Saturday 17th September 2016

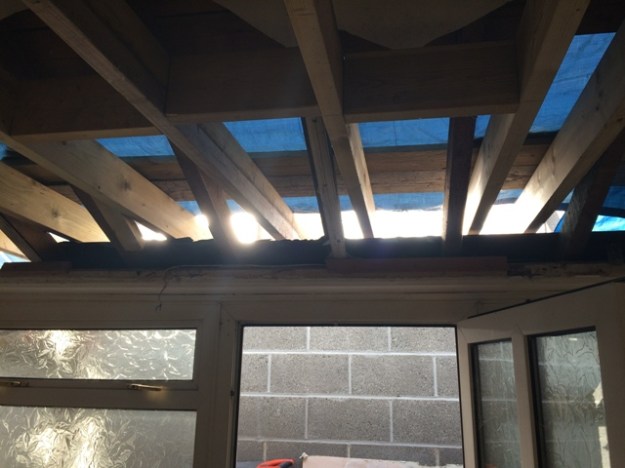

Removal of 2 ceilings discovered over the Utility Room

two-ceilings-had-to-be-removed-from-here-before-insertion-of-new-beams-over-utility-room-the-room-had-to-be-emptied-because-of-mess-caused-in-a-job-like-this

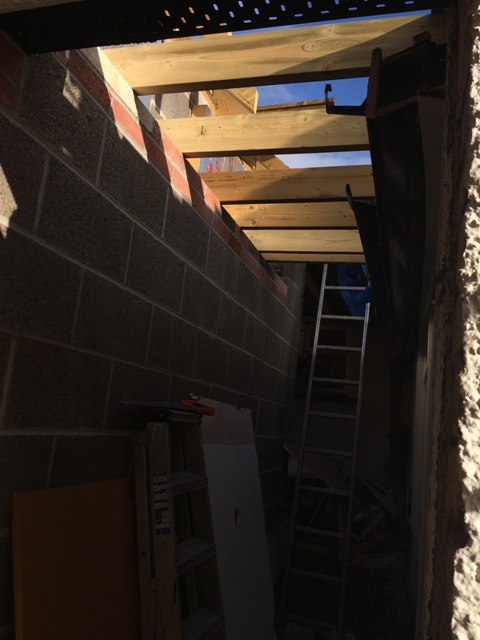

view-of-new-roof-beams-spanning-utility-room-fibre-glass-boards-will-be-used-over-this-part-of-the-roof

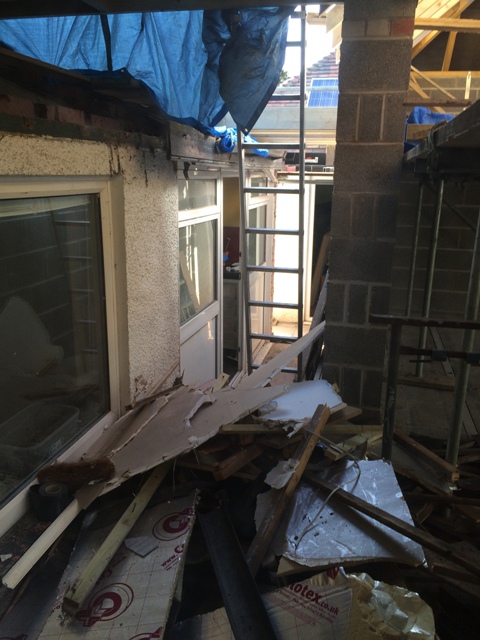

rubble-and-old-ceiling-to-be-removed-from-new-kitchen-walkway

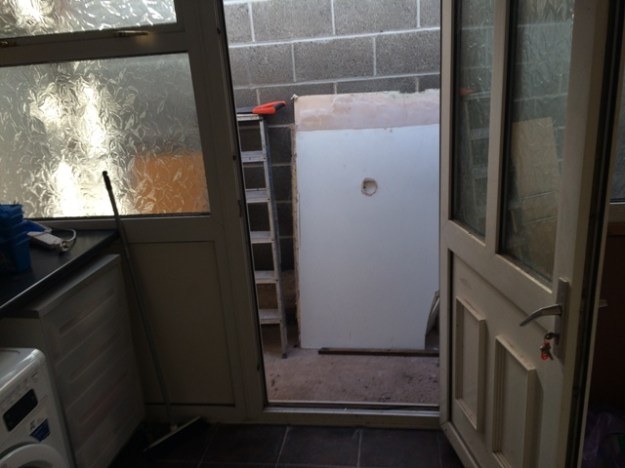

view-through-utility-door-old-ceiling-outside

electricity-box-all-exposed-in-utility

old-electricity-box-surround-which-fell-down-during-removal-of-ceiling-in-the-utility-room

rubble-to-be-removed-from-old-bedroom

old-wood-to-be-removed-from-old-bedroom
Day 50 – Sunday 18th September 2016
More Work on Utility Room

utility-outside-wall-now-removed

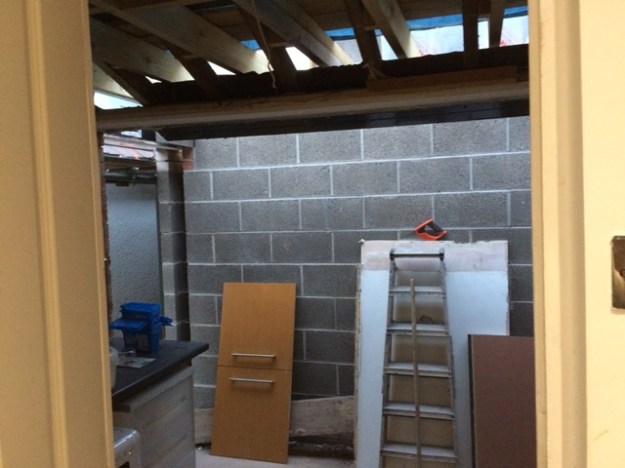

view-from-kitchen-through-utility-to-new-wall-of-utility

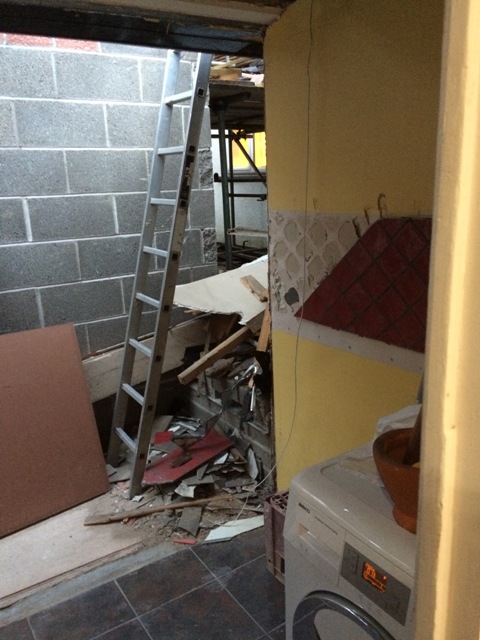

utility-room-with-old-wall-removed-right-hand-side

utility-room-with-old-wall-removed
Day 51 – Monday 19th September 2016
Work in and around Utility Room continues

rain-overnight-leaking-into-utility-room

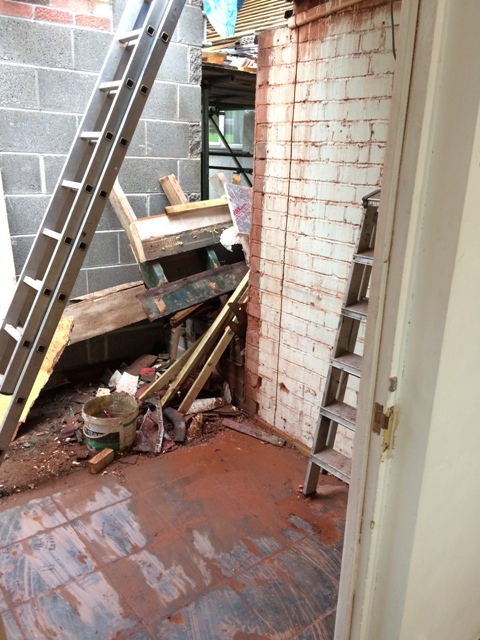

rubble-and-plaster-board-from-utility-wall-also-see-vertical-cuts-in-wall-which-will-be-the-door-opening-into-the-new-bathroom

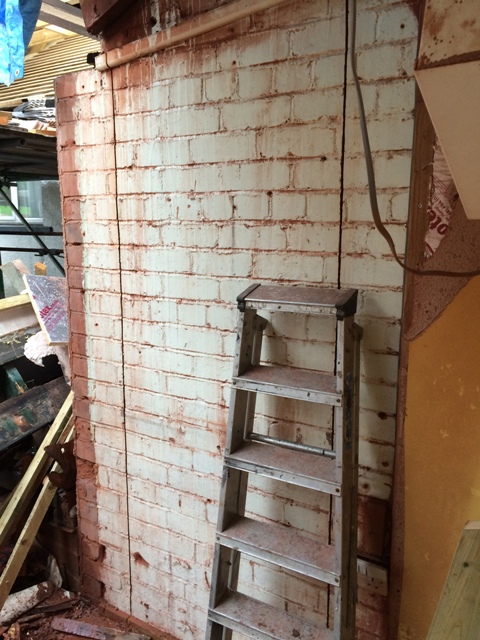

close-up-of-grooves-cut-for-door-to-new-bathroom

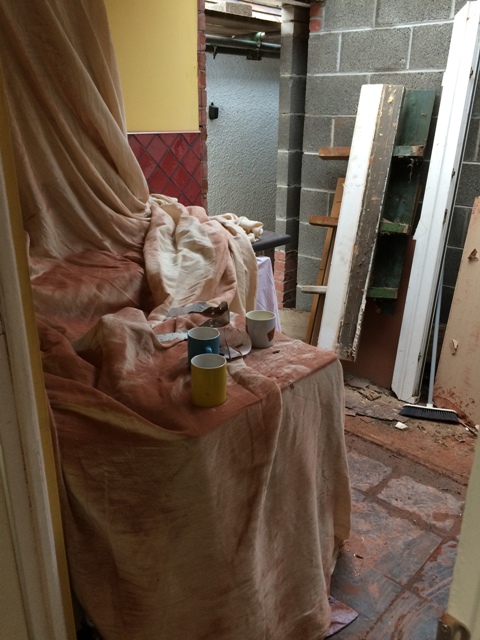

everything-covered-to-protect-from-very-fine-red-brick-dust-after-cutting-grooves-for-new-doorway-in-utility-room-2

dust-masks-essential

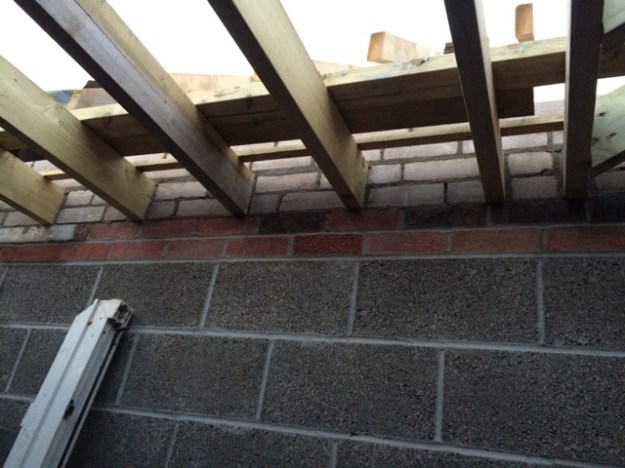

new-brickwork-around-timbers-in-utility-room

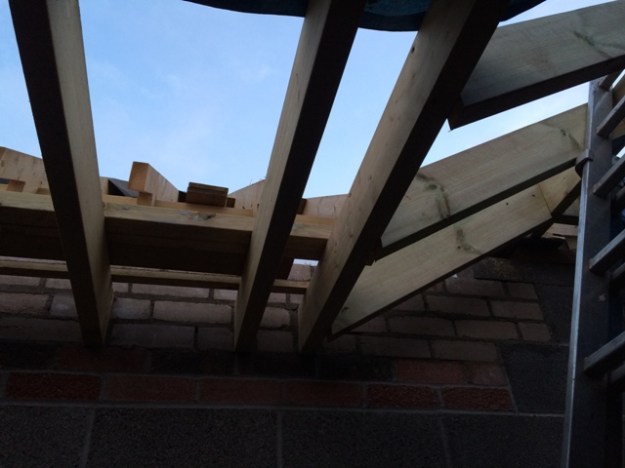

close-up-of-new-sloping-beams-to-accomodate-head-height-for-steps-which-have-yet-to-be-built-to-reach-new-level-of-kitchen
Day 52 – Tuesday 20th September 2016
Work to utility room, new bathroom, and brickwork

drilling-and-loosening-brick-work-in-new-doorway-before-inserting-2-new-lintels

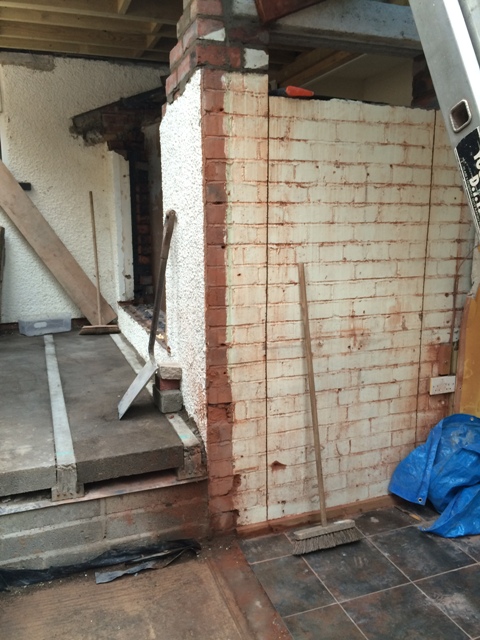

new-lintels-in-over-new-doorway-and-window-out-of-old-bedroom

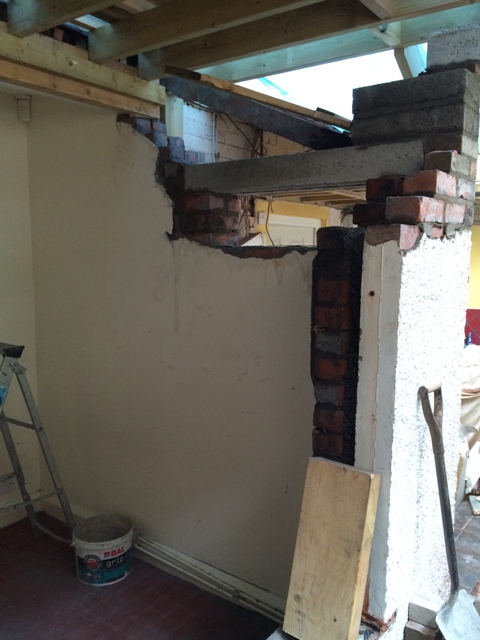

two-new-lintels-over-new-doorway Between old bedroom and utility room

old-bedroom-cleared-of-rubble-and-window-removed

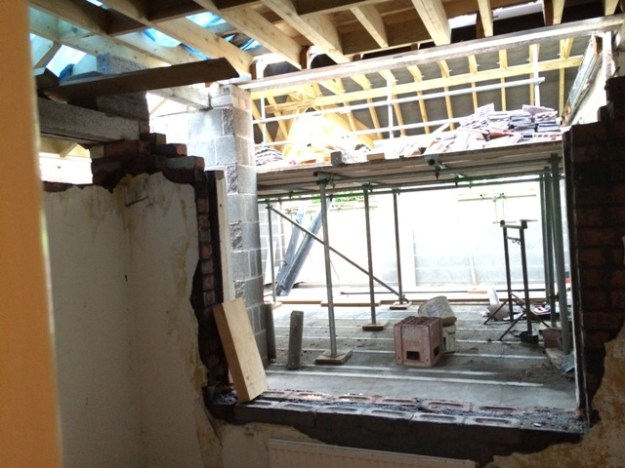

old-bedroom-window-removed

new-bathroom-old-bedroom-with-gap-for-flat-roof-light-bubble

position-of-new-polycarbonate-dome-for-light-for-new-bathroom

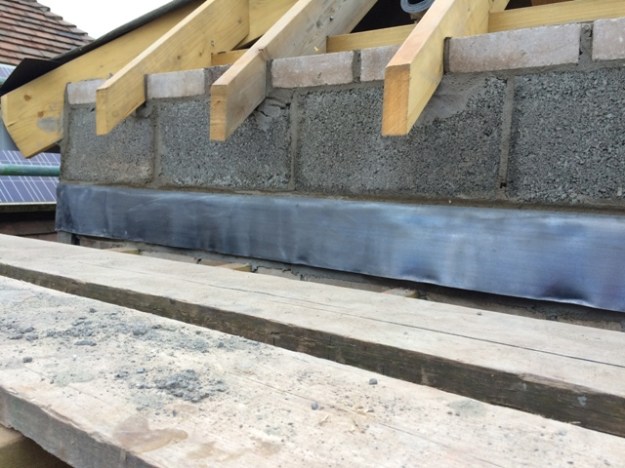

lead-inserted-into-roof-this-will-go-over-fibre-glass-board-double-wall-here-completed-between-rafters

lead-inserted-into-roof-and-wall-finished

sloping-roof-created-to-accomodate-enough-head-height-when-going-down-steps-from-new-kitchen-to-utility

sloping-roof-from-above-outside-view

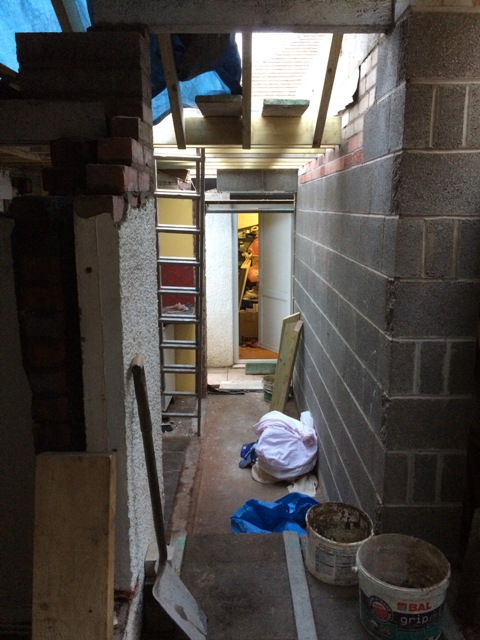

view-from-new-kitchen-area-through-to-back-door-position-and-garage
Day 53 – Wednesday 21st September 2016
Unfortunately the builder fell through the beams of the utility room today, landing on a stone floor. This meant a hospital check up. He is very sore, but luckily no broken bones.

gaps in beams, some unsecured
Day 54 – Thursday 22nd September 2016
Builder is very fortunately ok and back here, although very sore. A lot of work today on the roof over utility and new entrance to kitchen.

view-into-utility-room-from-new-kitchen-fibre-boards-in-place-on-roof

utility-roof-showing-slope

fibre-boarding-over-utility-room

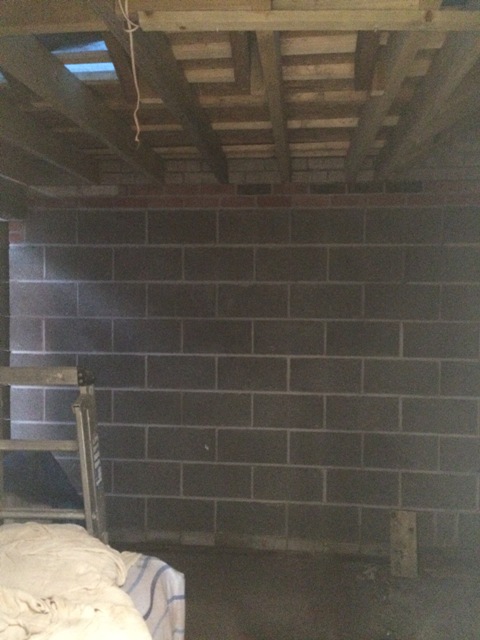

skylight-shown-in-blue-tarpaulin-over-top

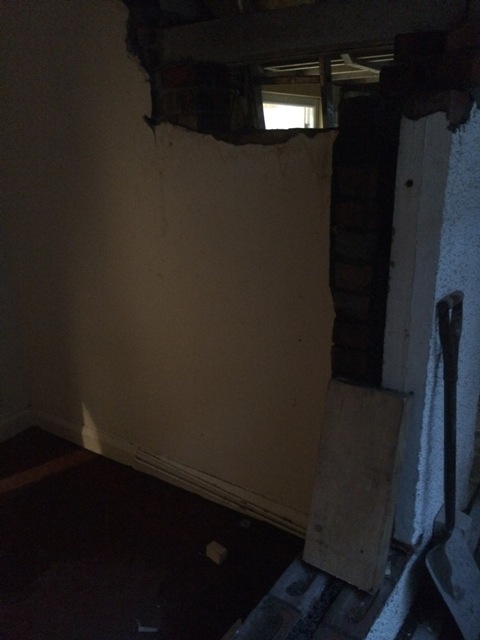

this-will-be-door-out-of-new-bathroom-to-utility-lintels-in-part-cut
Day 55 – Friday 23rd September 2016

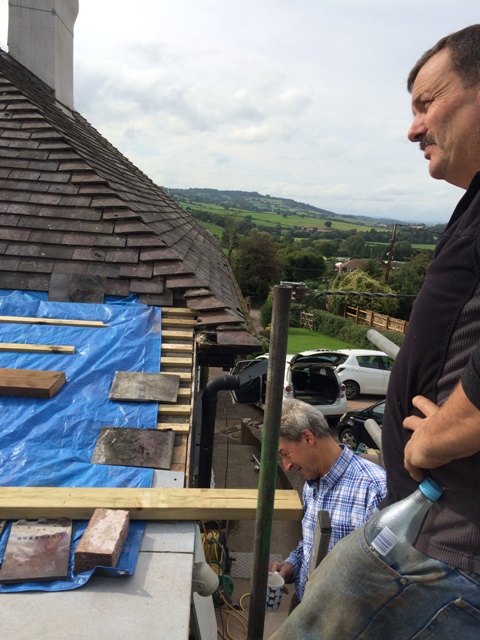

More roof work – pictures taken Saturday 24th September from scaffolding

view-from-scaffolding-of-tarpaulins-new-bathroom-and-utility-room-sloping-roof-can-be-seen-under-tarpaulin

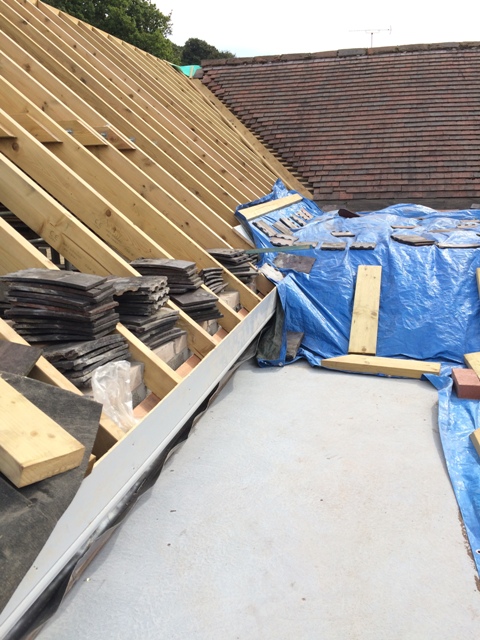

view-from-scaffolding-of-tarpaulins-over-part-of-new-bathroom-and-utility-room-lefthand-side-of-roof

view-from-scaffolding-of-tarpaulins-over-part-of-new-bathroom-and-utility-room

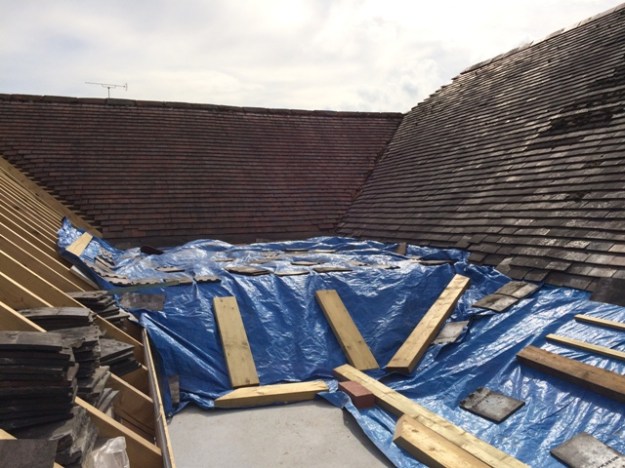

view-of-roof-over-utility-and-entrance-to-new-kitchen-between-the-three-sloping-roofs

view-from-scaffolding

scaffolding-between-new-kitchen-and-garage

view-across-scaffolding-along-back-of-house

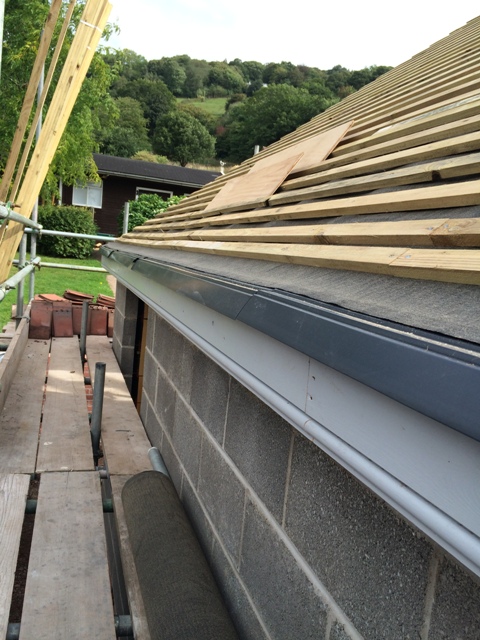

view-towards-back-garden-from-scaffolding-showing-felt-and-battening

view-to-back-garden-across-scaffolding

view-of-new-steps-from-scaffolding

view-into-new-kitchen-through-new-side-window-opening

rain-leaking-into-utility-roof-is-unfinished-as-yet

heavy-rain-has-totally-filled-tarpaulin-over-new-skylight-rain-is-leaking-in-again

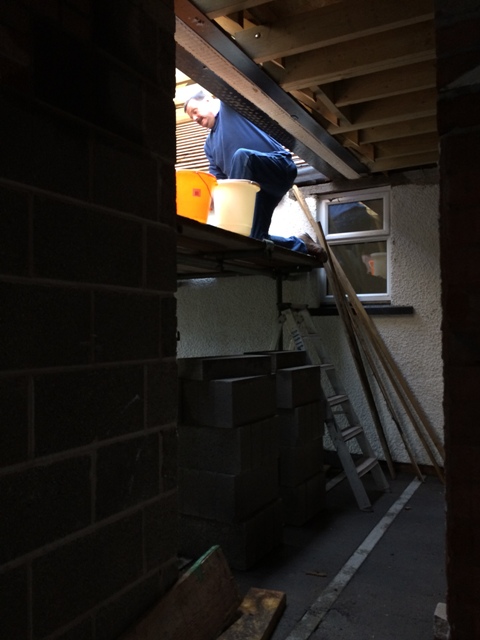

sunday-another-night-of-heavy-rain-8-buckets-of-water-removed-from-tarpaulin-covering-skylight
Day 56 – Monday 26th September 2016
Wet day – Work limited to undercover. Skylight gap previously covered in tarpaulin was recovered with board. This will be fitted and sealed within the next few days, so should soon be water tight. Hole was cut for doorway to new bathroom. Bricks laid to fill gap over new lintel above the new back door. Old bedroom window now blocked in. Photos below.

old-bedroom-window-blocked-up

old-little-bedroom-with-window-blocked-up-and-brickwork-cut-to-the-left-to-form-a-new-doorway-into-the-utility-room

new-doorway-cut-into-old-bedroom-which-will-be-new-bathroom-picture-taken-from-utility-side
Day 57 – Tuesday 27th September 2016
Fibre glass roofing over flat/sloping roof was completed today. Fibre glass roofing was chosen as it is strong and durable and can last for 20 years. It was the ideal solution to cover this kind of roof where all the tiled roofs meet. An expert came out to do the job and it had to be a dry day. There are several layers, the first of which is a fibre glass coated board, then a resin goes on, followed by the fibre glass matting, then more resin and finally a top coat. Photos are shown below.
Also today a mistake was noticed by the double glazing man in the hip above the patio doors when he was measuring, so this needs to be corrected.

hip-roof-has-been-constructed-incorrectly-one-angle-is-wrong-3-inches-out

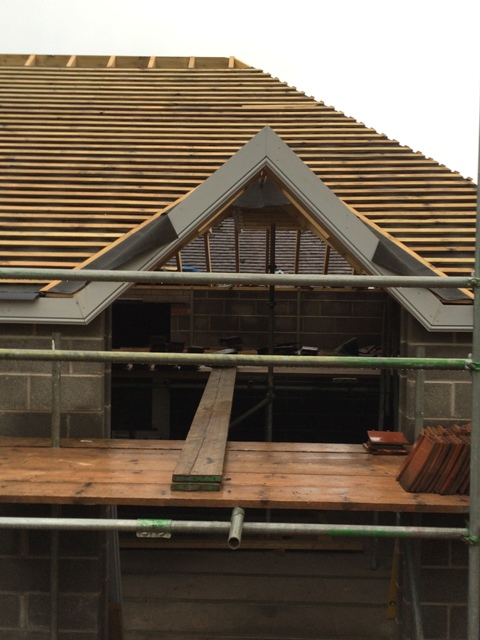

hip-roof-has-been-constructed-incorrectly-picture-2

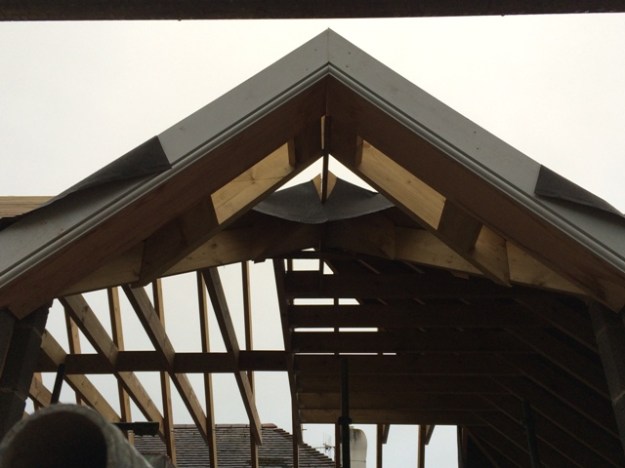

hip-roof-has-been-constructed-incorrectly-picture-3

hip-roof-has-been-constructed-incorrectly-picture-4

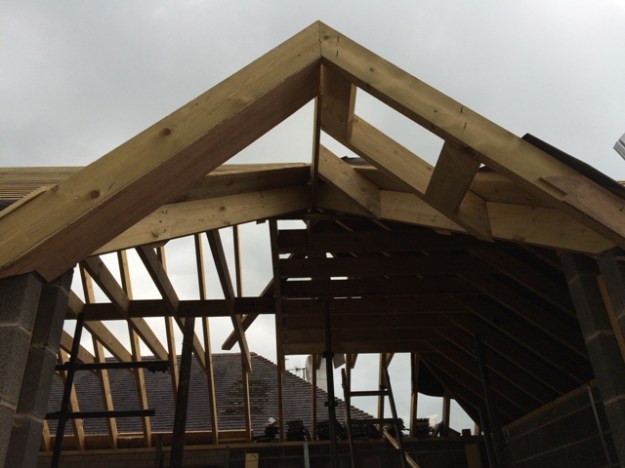

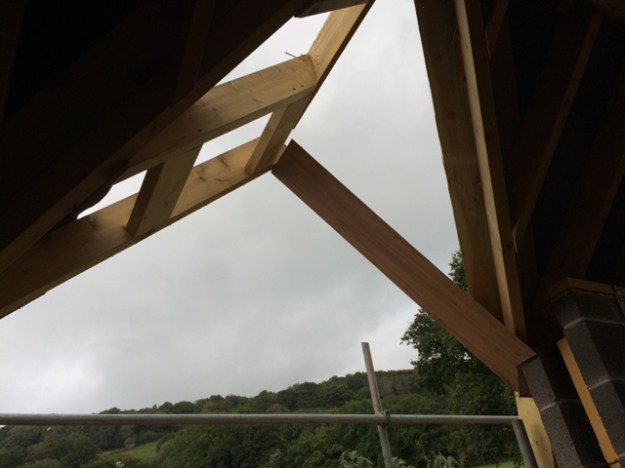

hip-roof-being-reconstructed

hip-roof-being-reconstructed-2

fibre-glass-roof-between-sloping-roofs-completed-today-all-sealed-and-watertight-skylight-and-vents-are-also-sealed-in

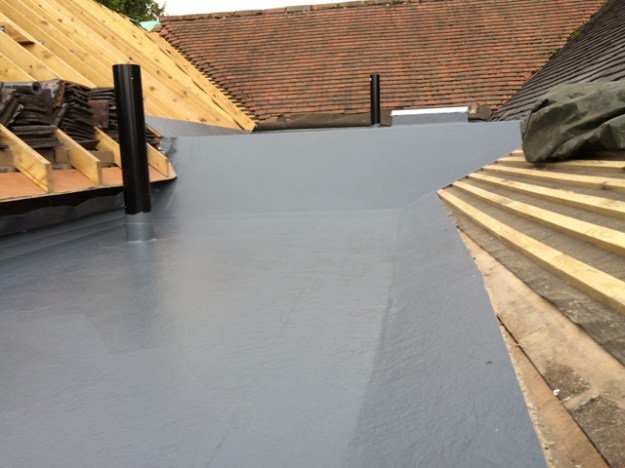

fibre-glass-roof-shows-sloping-sections-and-new-skylight-and-vents-all-put-in-place-today

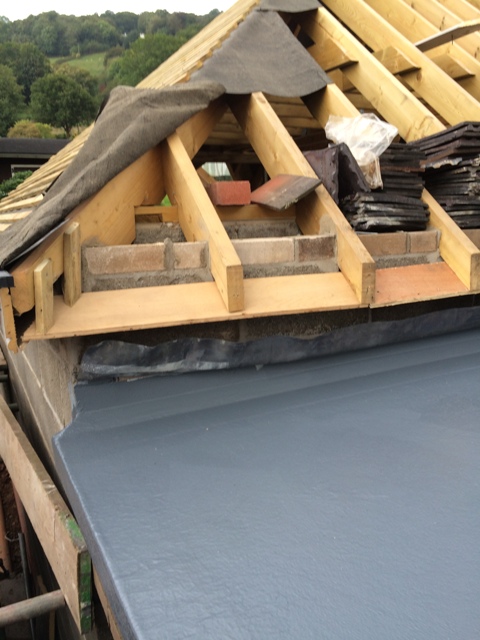

fibre-glass-roof-took-a-day-to-do-and-sealed-with-a-special resin and top coat

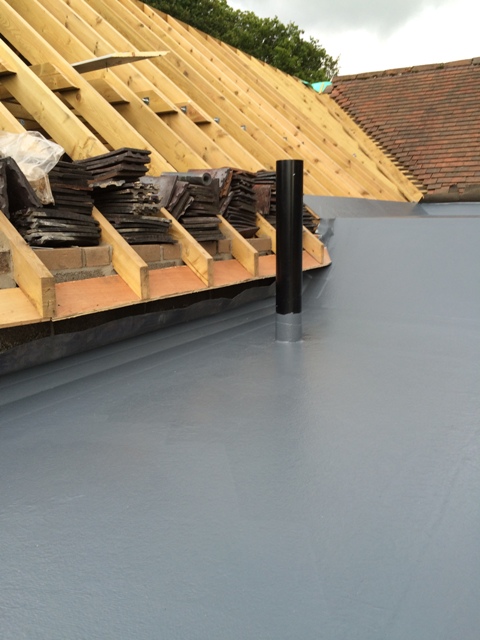

sealed-vent-for-utility-room-in-new-fibre-glass-roof

vent-put-in-new-bathroom

new-vent-can-be-seen-in-utility-room

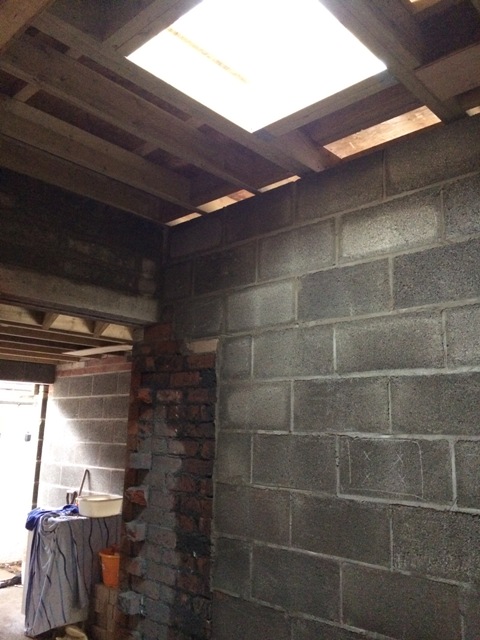

skylight-over-new-bathroom-to-be-in-place natural-light-coming-through-is-considerable

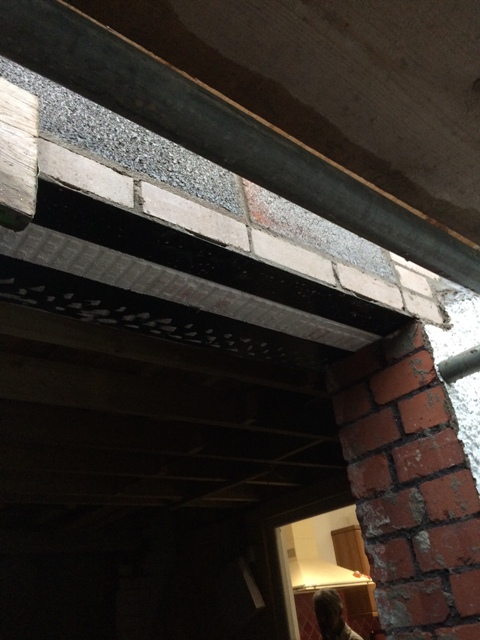

bricks-in-place-over-back-door-outside-doors-and-windows-have-been-measured

blocked-up-old-bedroom-window

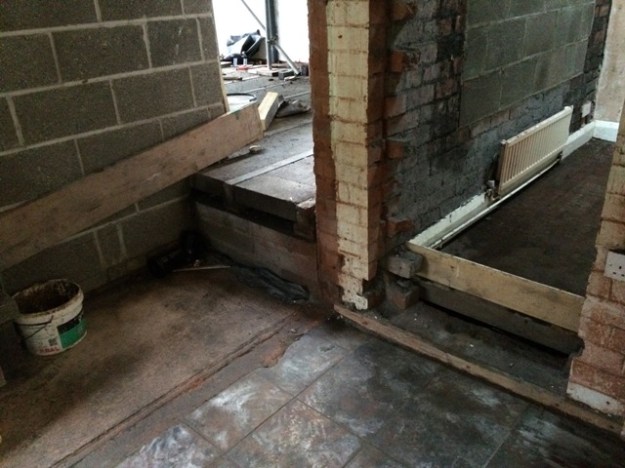

2-doorways-now-opened-up-left-to-kitchen-right-to-new-bathroom-rubble-all-cleared-away

a-fleet-of-white-vans-today
Day 58 Wednesday 28th September 2016

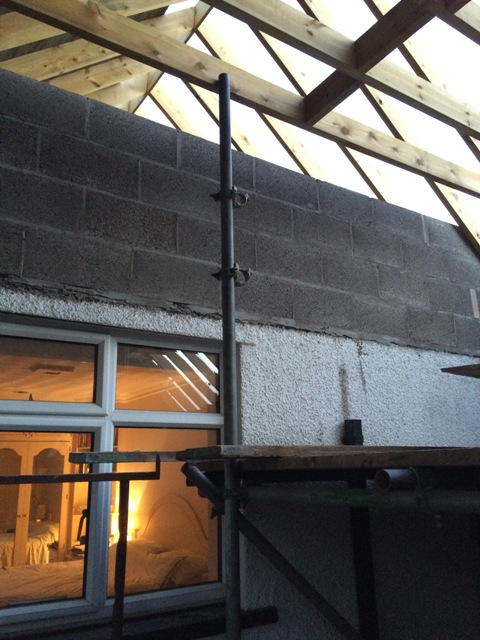

block wall between bedroom and new kitchen window will be removed next week

block wall going up between bedroom and new kitchen from scaffolding window to be filled in next week

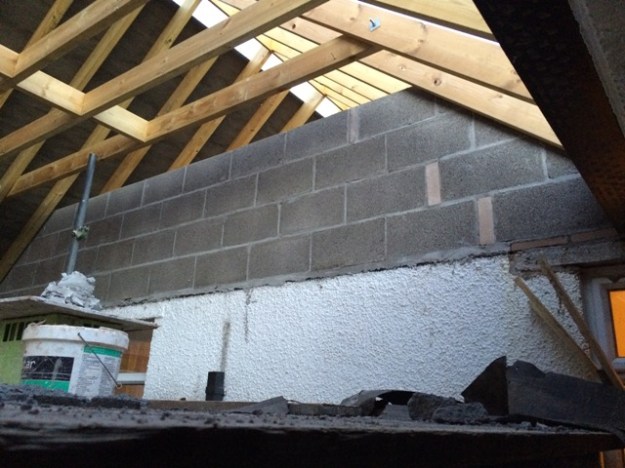

block-wall-going-up-between-bedroom-and-new-kitchen

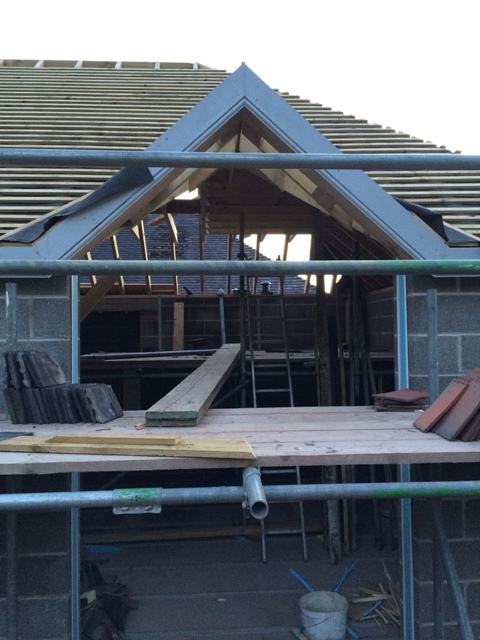

hip-roof-now-corrected-and-finished-now-in-at-correct-angle

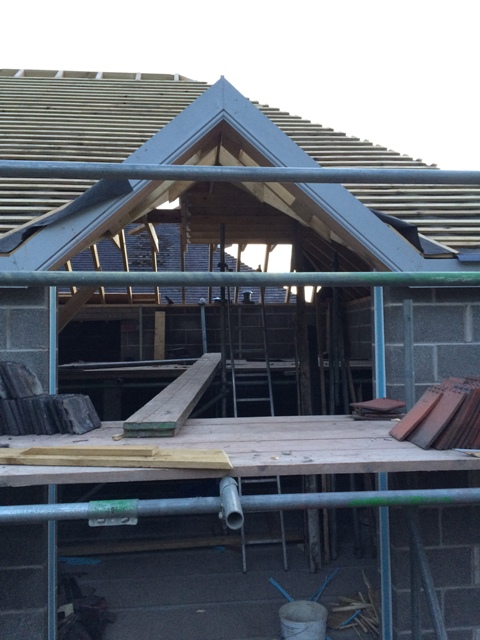

hip-roof-now-corrected-picture-2
Day 59 – Thursday 29th September 2016

installation-of-plastic-and-foam-lining-to-seal-cavity-around-door

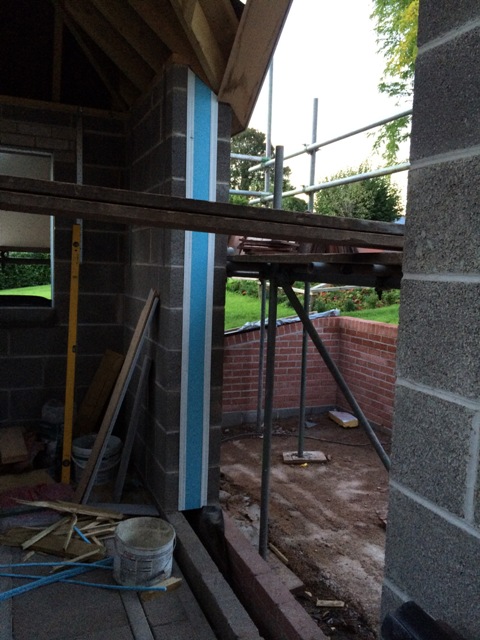

cavity-wall-closers-around-patio-doors

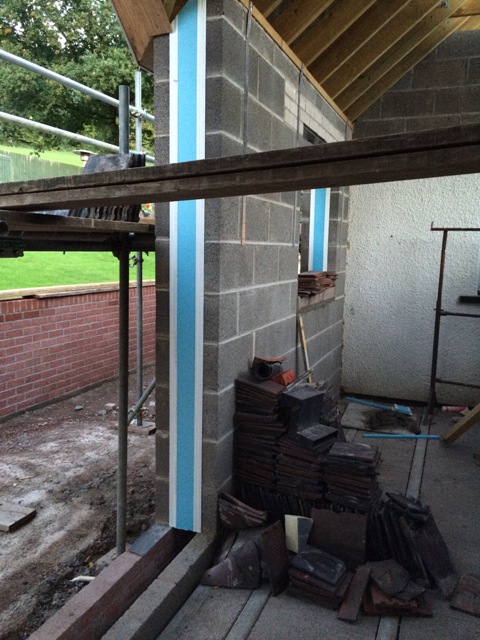

cavity-closers-around-windows

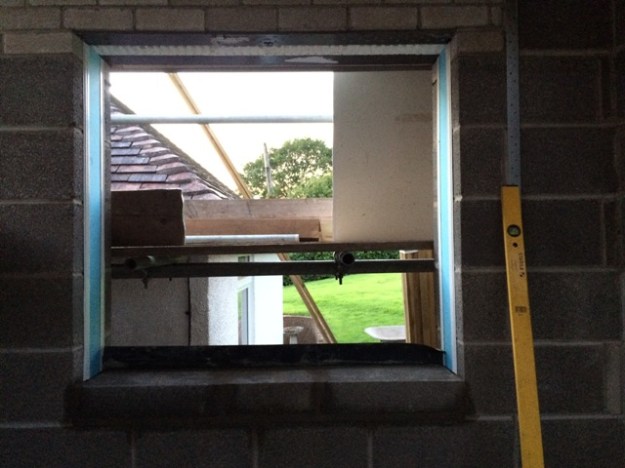

cavity-closers-around-windows-pic-3

cavity-closers-around-windows-pic-2

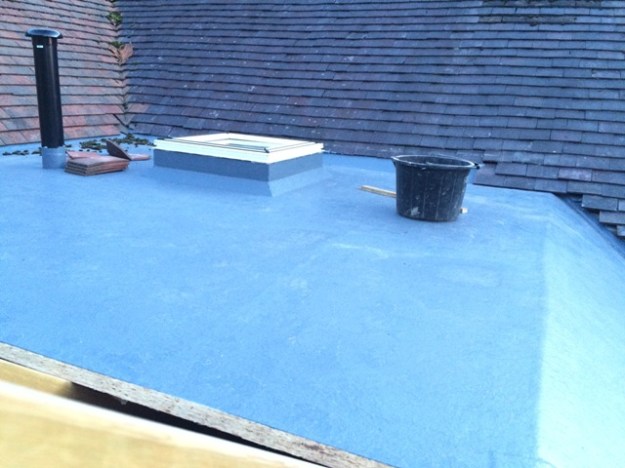

tiles-now-being-replaced-around-new-fibre-glass-roof-picture-from-scaffolding

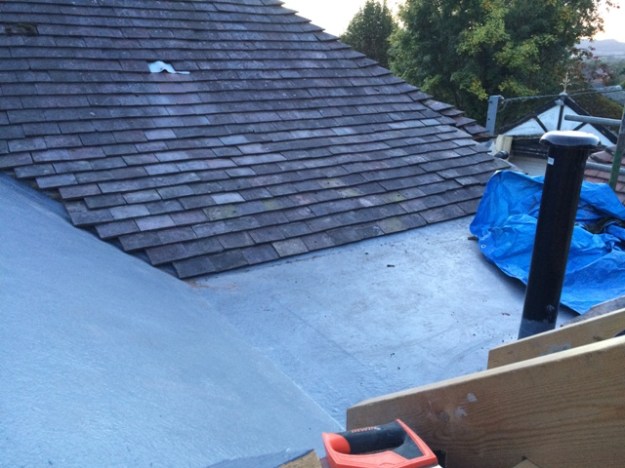

tiles-now-being-replaced-around-new-fibre-glass-roof-picture-2

fibre-glass-roof

fibre-glass-roof-2-showing-valley
Day 60 – Friday 30th September 2016

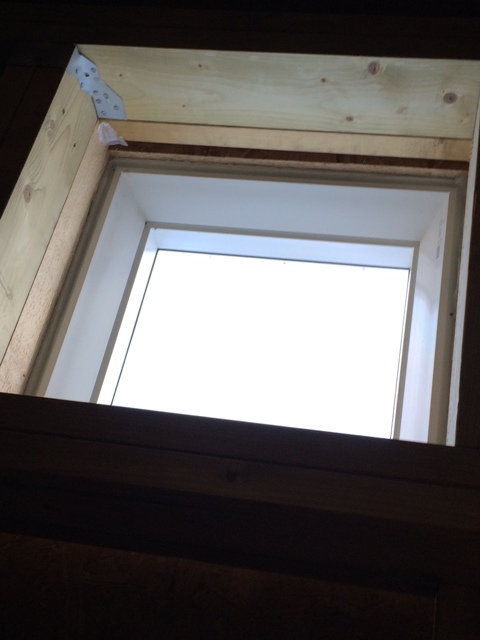

Leaking Skylight. Heavy rain overnight and water has been dripping through the skylight in one corner. The bubble has now been fixed on over the top so this should stop the problem

felt-nearly-completed-shown-from-inside-of-new-kitchen

felt-from-inside-of-new-kitchen

view-of-main-bedroom-through-window-to-be-blocked-up-scaffolding-still-in-place-inside

view-of-back-of-house-showing-completed-felt-and-battening

view-of-back-of-house-showing-valley-in-the-middle-between-the-two-roofs

top-of-drive-in-front-of-double-garage-with-materials-and-new-roof-structure-with-felt-and-battening-between-house-and-garage

materials still to be used at the top of the drive and top of the new kitchen roof can be seen with felt and battening

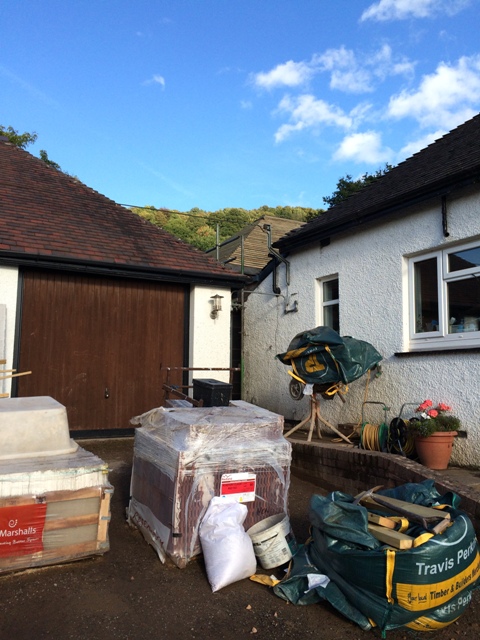

top-of-drive-in-front-of-double-garage-with-materials
Day 61 – Monday 3rd October 2016
Tiles starting to go on roof now

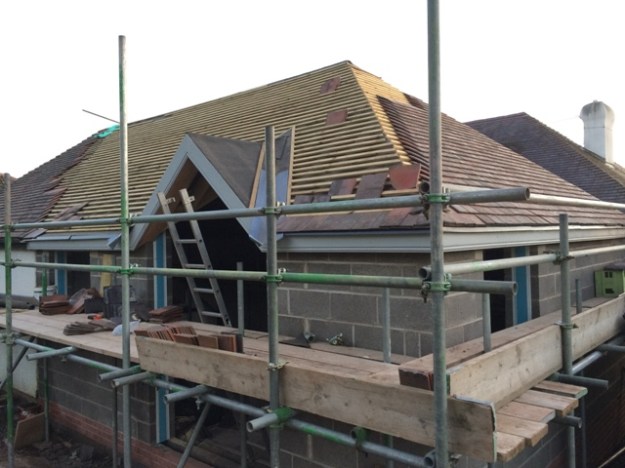

work-today-on-roof-tiles-on-righthand-side-roof-felt-on-peak-over-patio-doors-and-lead-in-valleys

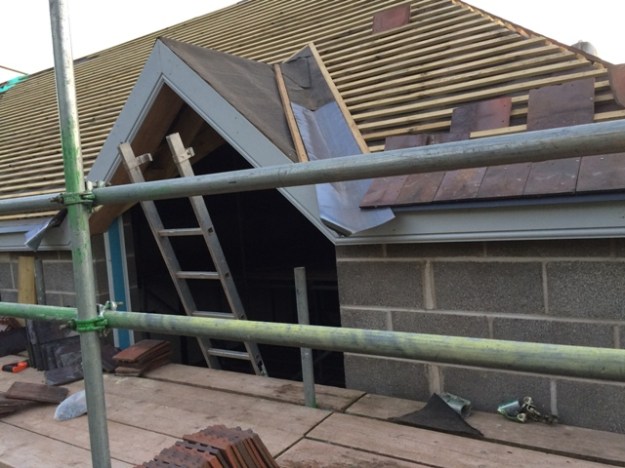

felt-on-new-hip-roof-and-lead-valley-on-right

lead-valley-on-lefthand-side-of-hip-roof

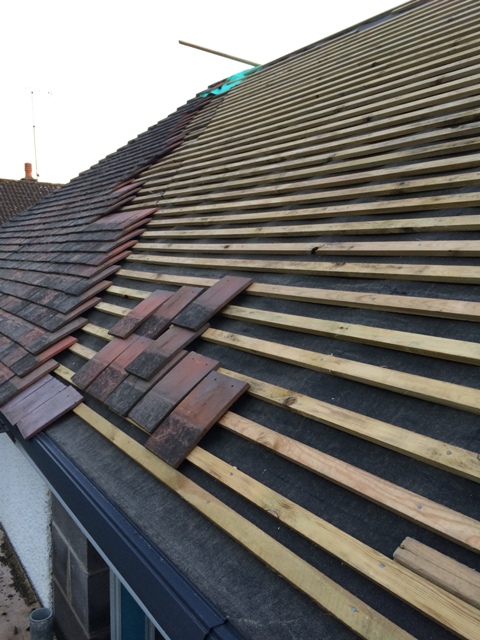

view-along-back-of-house-above-new-kitchen-and-main-bedroom

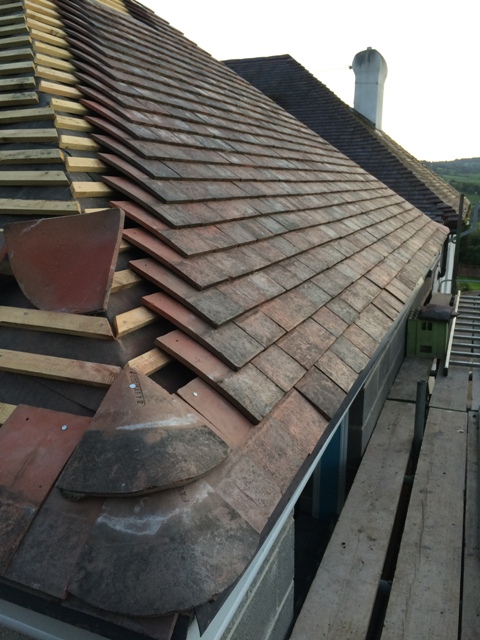

view-of-newly-tiled-right hand side-of-new-kitchen-roof

view-along-side-of-newly-tiled-kitchen-roof-towards-back-garden
Day 62 – Tuesday 4th October 2016
Tiling of the new roof continued. Much progress was made today.

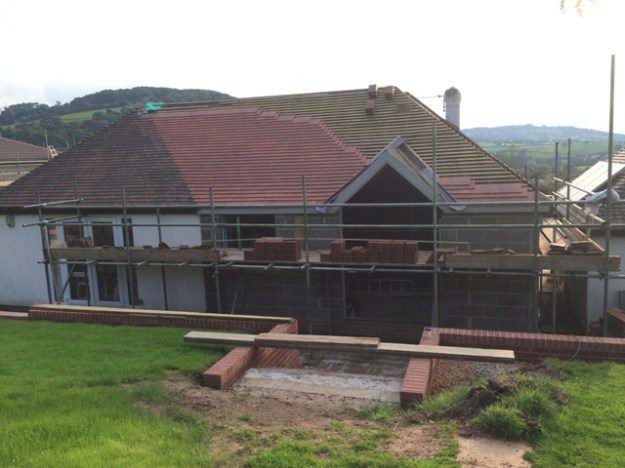

progress-of-tiling-over-kitchen-roof

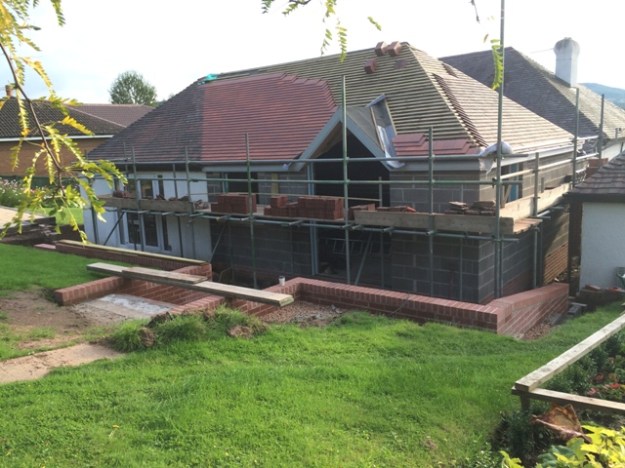

progress-of-tiling-over-kitchen-roof-picture-2

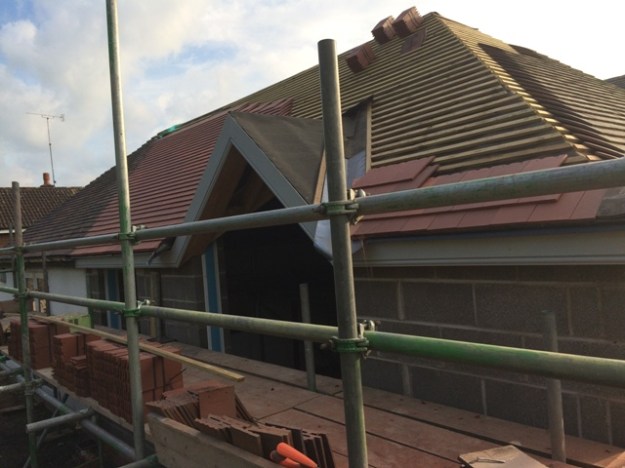

close-up-of-tiling-in-progress-through-scaffolding

back of house view

view-of-back-of-house-different angle
Day 63 – Wednesday 5th October 2016
Two windows and a door!

first-new-window-for-kitchen-partly-obscured-by-scaffolding

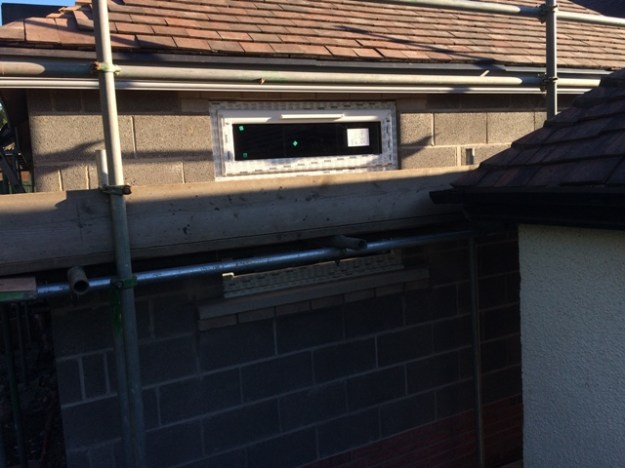

second-new-window-also-partly-obscured-by-scaffolding

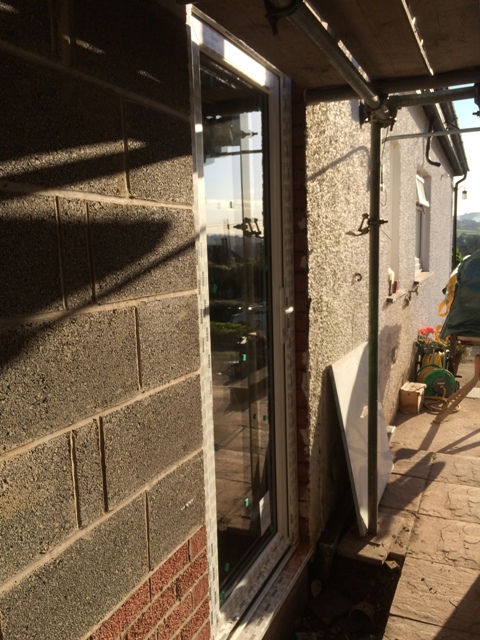

new-back-door-into-utility

view-through-window-from-main-bedroom-to-new-kitchen

view-through-window-from-main-bedroom-to-new-kitchen-marked-for-sik-dishwasher-cooker

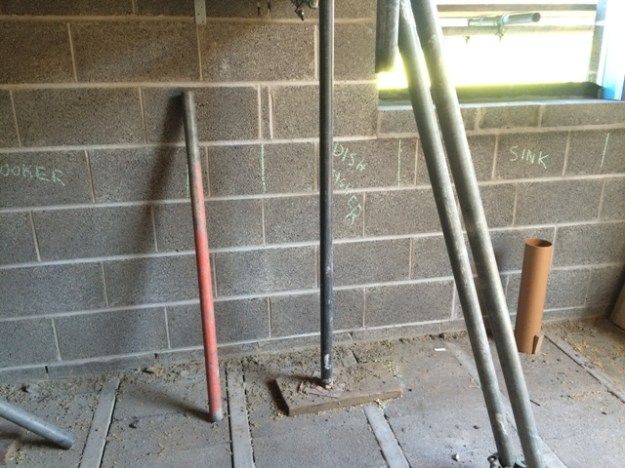

kitchen-planning

new-back-door-picture-taken-from-inside
Day 64 – Thursday 6th October 2016
Electrician today

electrician-came-today-and-started-wiring-kitchen

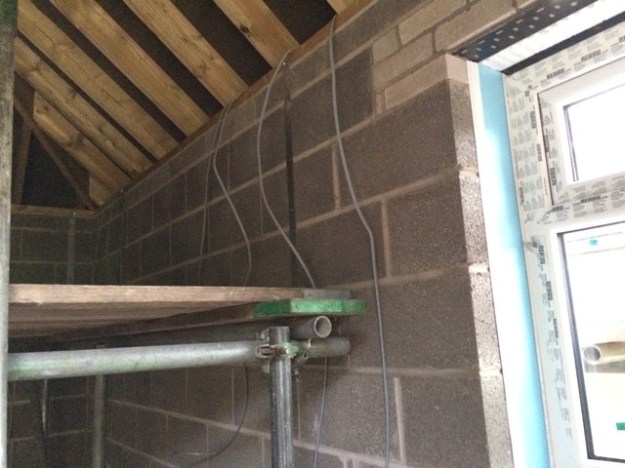

wiring-for-cooker-and-sockets-above-work-top-eventually in this position

wiring-for-fridge

wiring-in-corner-of-kitchen-new-hall-door-will-be-located-to-the-left-of-this
Outside work continues with the tiling of the new roof

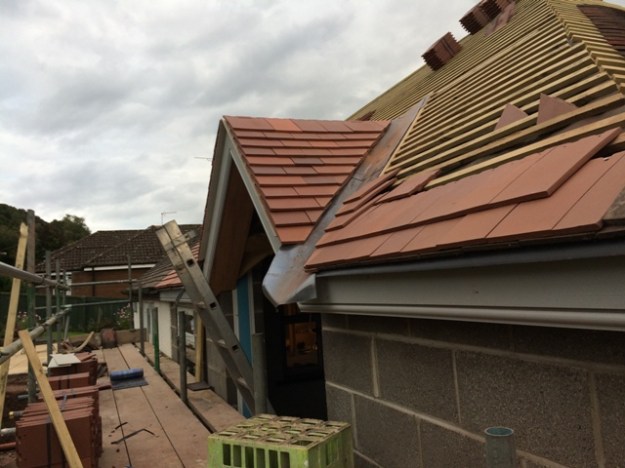

hip-roof-tiled-and-lead-in-valley
Day 65 – Friday 7th October 2016
Progress of tiling on new roof

roof-tiling-progress-adjacent-to-flat-roof

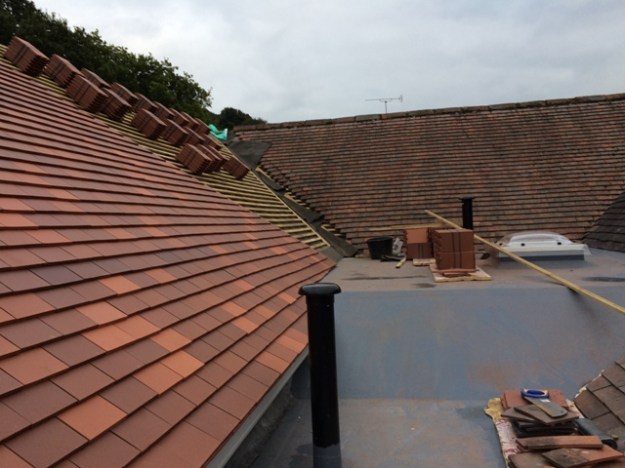

roof-tiling-progress-adjacent-to-flat-roof-picture-2

roof-tiling-showing-progress-of-tiling-at-back-of-kitchen-roof

roof-tiling-along-side-of-roof-adjacent-to-garage

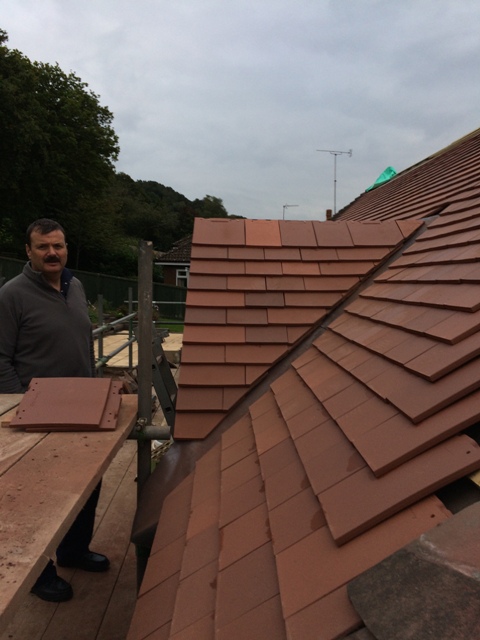

inspection-of-work

lead-valley-down-side-of-hip-roof

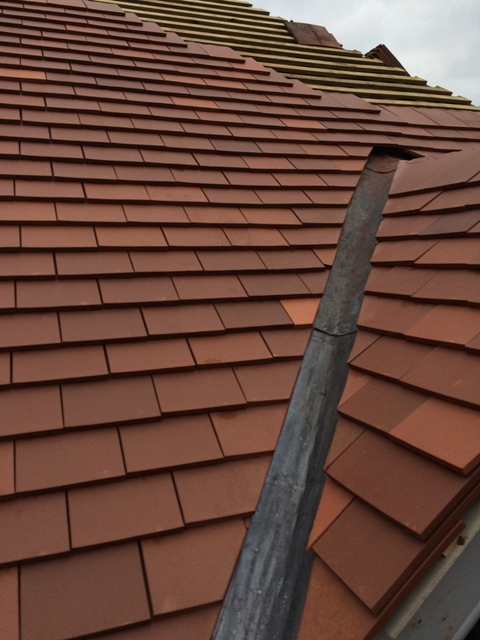

lead-valley-down-left-side-of-hip-roof

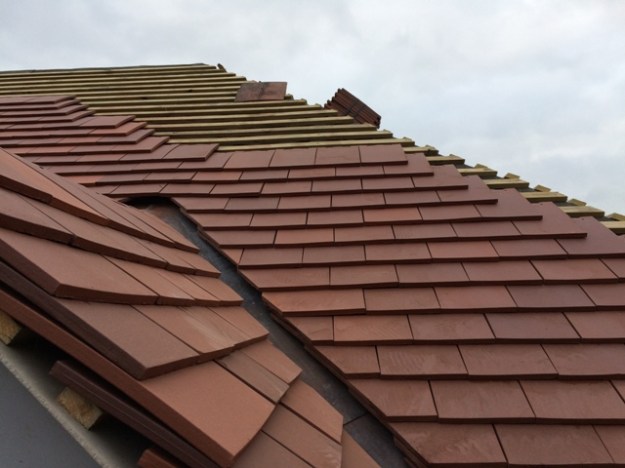

progress-on-tiling-7-10-16
Day 66 – Monday 10th October 2016
Progress on roof

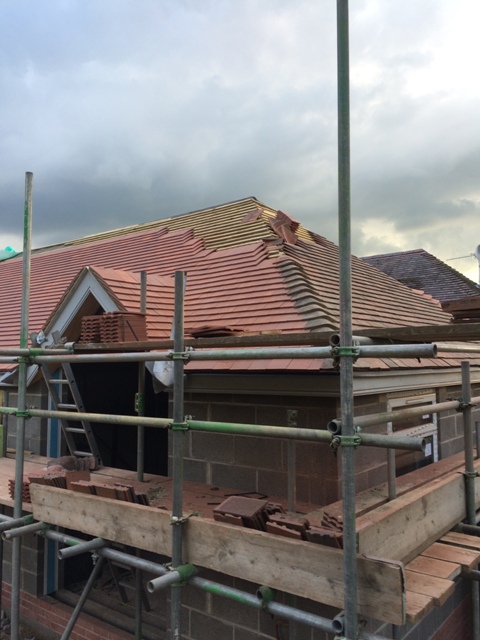

the-roof-so-far-at-the-back-of-house-over-new-kitchen

corner-of-roof-adjacent-to-garage-and-sloping-onto-flat-roof

corner-of-roof-adjacent-to-garage-and-sloping-onto-flat-roof-cemented-in

new-and-old-corner-rosemary-tiles-the-old-ones-are-much-smaller-and-have-a-shallower-curve

new-kitchen-roof-sloping-to-flat-roof
Day 67 – Tuesday 11th October 2016
Lovely day

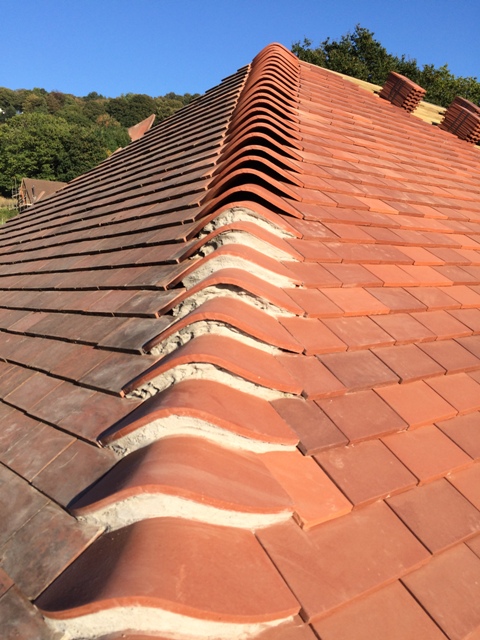

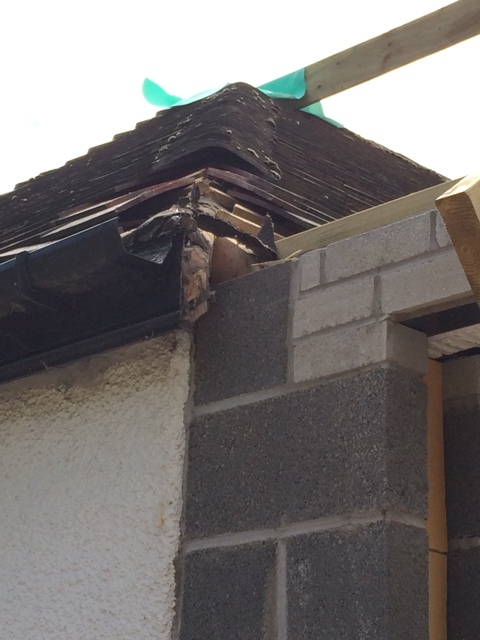

completed-corner-all-down-roof-to-over-new-back-door

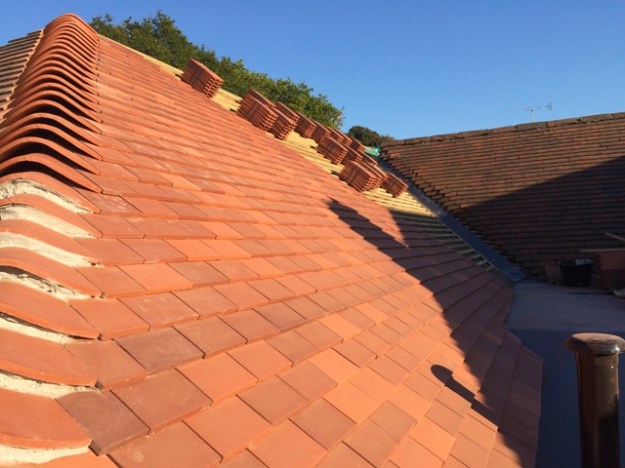

completed-corner-all-down-roof-to-over-new-back-door-picture-2

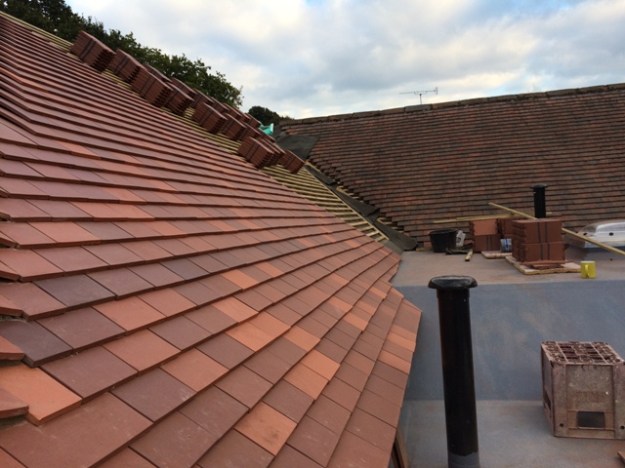

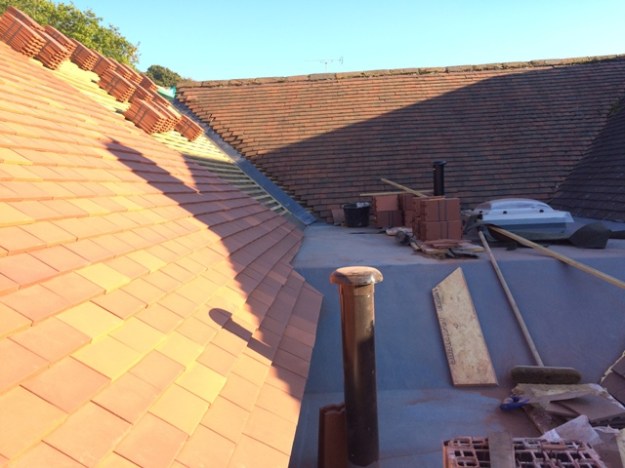

new-kitchen-roof-sloping-onto-flat-roof-area

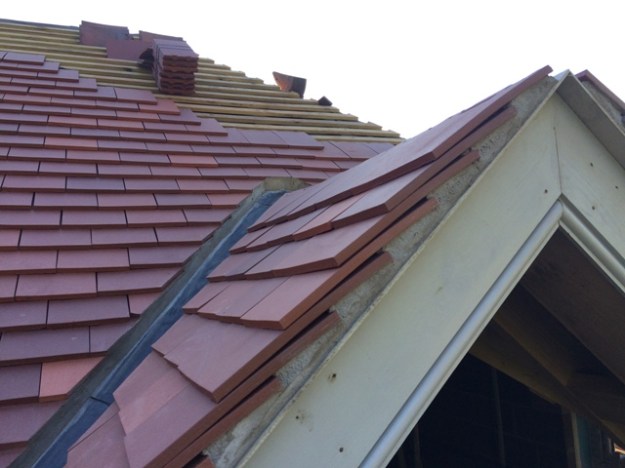

hip-roof-cemented

electrician-at-work-in-kitchen

electricians-work-so-far-installing-electricity-and-plug-sockets-in-new-kitchen

showing-wiring-coming-over-the-top-of-the-wall-into-the-new-kitchen-from-scaffolding-level

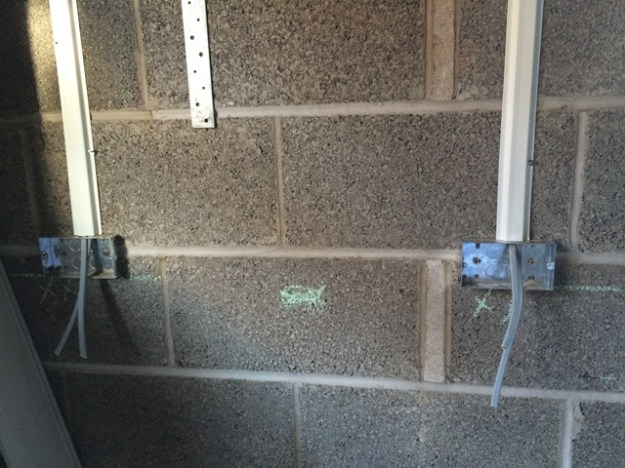

new-sockets-in-kitchen

new-box-for-plug-socket

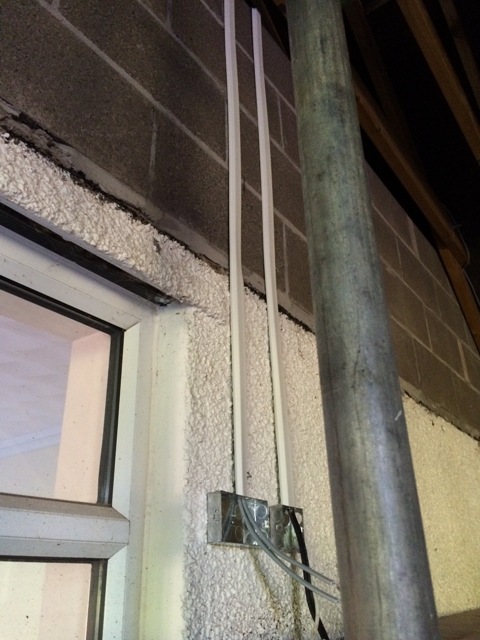

cable-coming-down-for-sky-aerial-and-power-for-tv

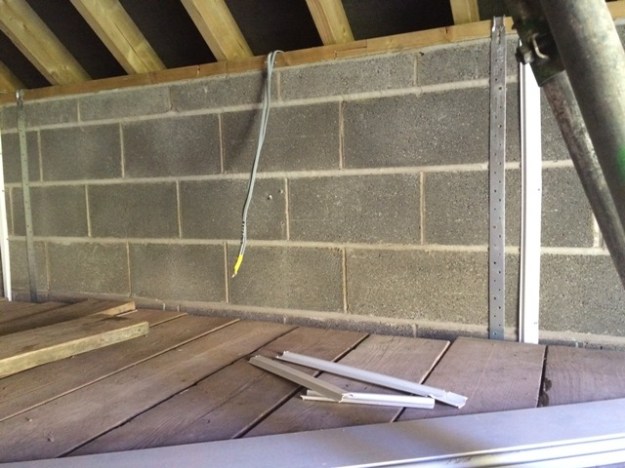

wiring-coming-over-wall-in-new-kitchen

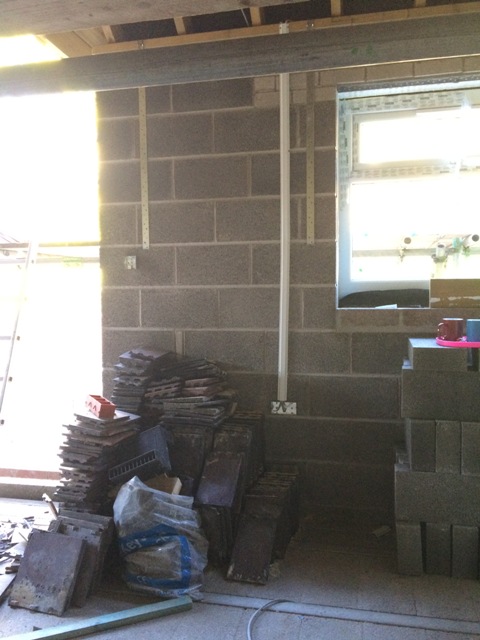

wiring-for-plug and switch

wiring-in-kitchen
Day 68 – Wednesday 12th October 2016

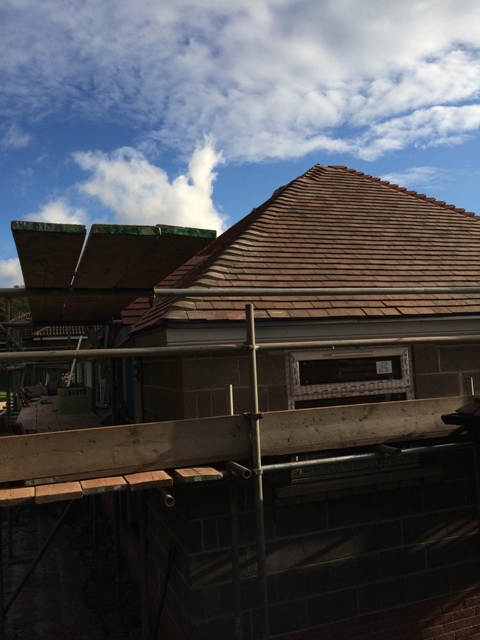

back-of-house-over-kitchen-a-few-corner-tiles-to-be-sourced-for-roof

back-of-house-over-kitchen-a-few-corner-tiles-to-be-sourced-for-roof-close-up
Day 69 – Thursday 13th October 2016
Electrician and builder today

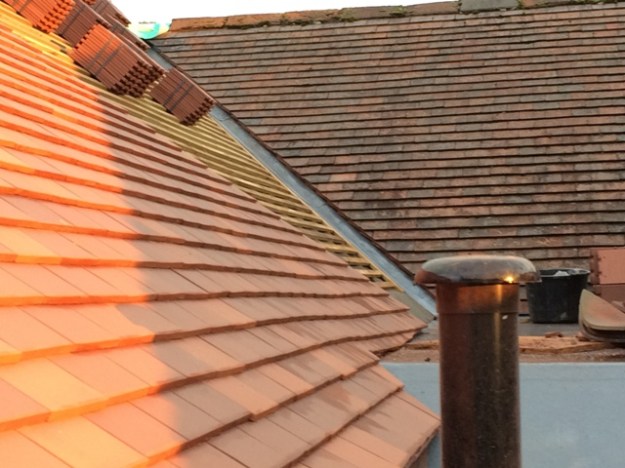

valley-tiles-all-cut

tiles-down-valley-all-neatly-cut

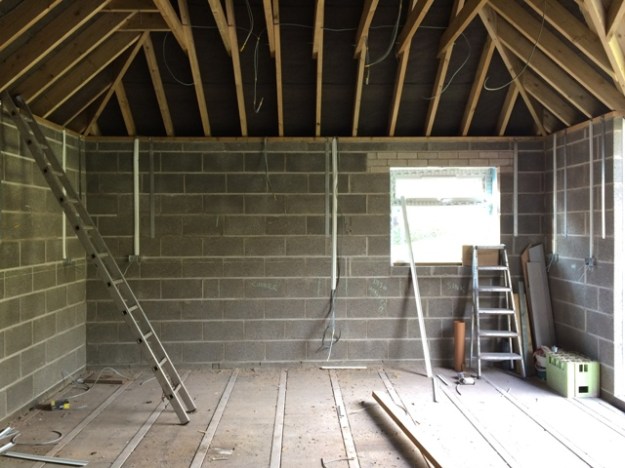

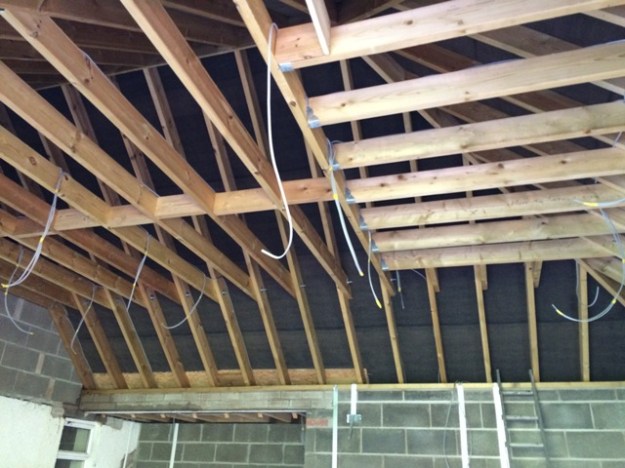

wiring-now-fed-through-in-readiness-for-kitchen-lights

wiring-now-fed-through-in-readiness-for-kitchen-lights-picture-2

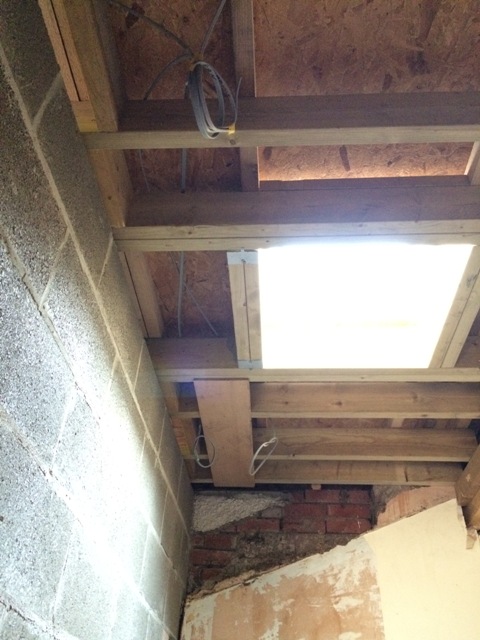

wiring-in-new-bathroom-for-ceiling

wiring-in-ceiling-between-new-kitchen-and-utility
Day 70 – Friday 14th October 2016
Indoor work today – builder and plumber

bedroom-prepared-for-removal-of-window

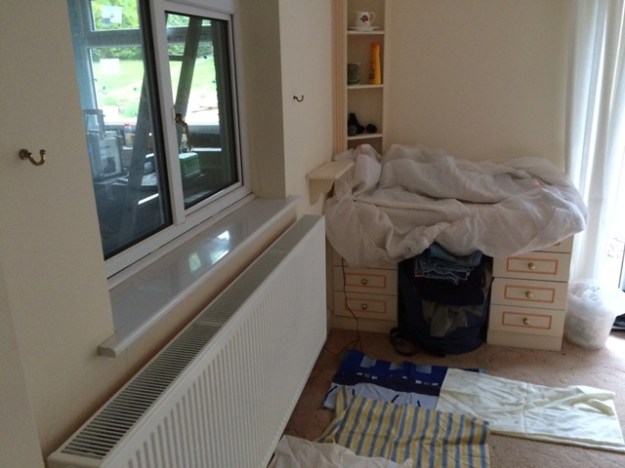

window-before-removal-between-kitchen-and-bedroom

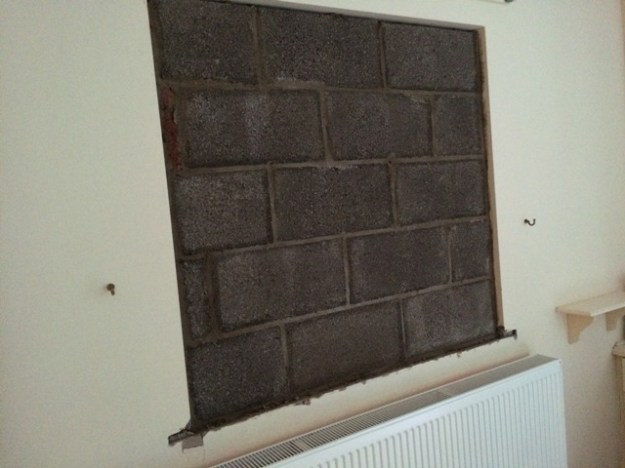

After! blocked-up-window-between-new-kitchen-and-bedroom-from-bedroom-side

After blocked-up-window-between-new-kitchen-and-bedroom

wall-partly-cut-in-readiness-for-new-door-to-kitchen-from-hallway

kitchen-now-cleared-of-scaffolding-and-building-materials

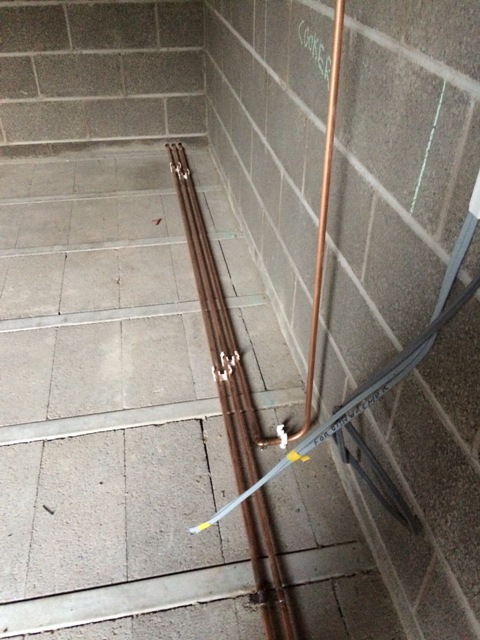

new-pipework-for-hot-and-cold-water-to-new-kitchen-and-gas pipe -to-gas-cooker-partly-installed

gas-and-water-supply-pipes-partly-installed-for-new-kitchen-through-new-wall
Day 71 – Monday 17th October 2016
Builder, Electrician and Plumber today. Heavy showers too, so roof not complete yet.

wall at front where the patio doors are going has been levelled

Looking through to new kitchen – window-from-hall-soon-to-be-removed and replaced with a door

New steps-built-today-from-utility-to-new-kitchen. They are-not-level-at-the-top-as-the-kitchen-floor-has-not-been-built-up-yet

new-pipe-for-radiator-in-kitchen

new-pipe-for-radiator-in-kitchen picture 2

radiator-pipes-going-through-wall-to-new-bathroom

radiator-pipes-running-around-flooring-will-be-below-level-of-floor-when-floor-has-been-put-in

switch-in-kitchen-on-left-at-the-top-of-the-new-steps

new-switch-for-outside-light-just-outside-back-door

old outdoor window sill now chiselled away
Day 72 – Tuesday 18th October 2016

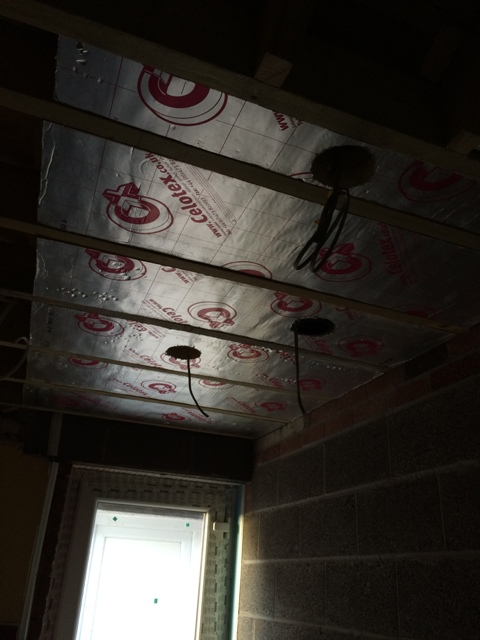

beginning-of-celotex-insulation-between-roof-and-beams-in-utility-room-cut-around-extractor

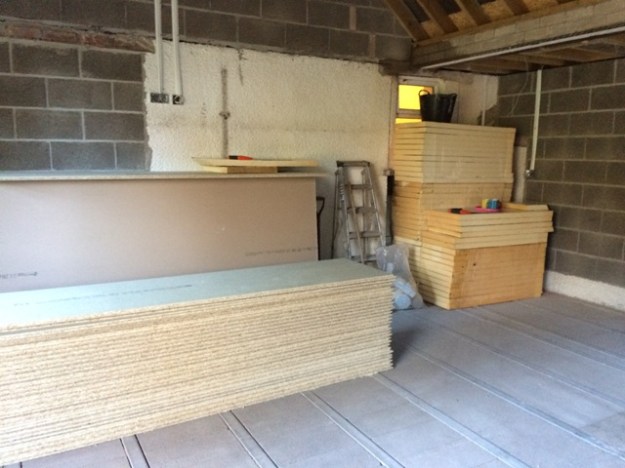

plaster-board-for-walls-and-insulation-for-ceiling-has-been-delivered

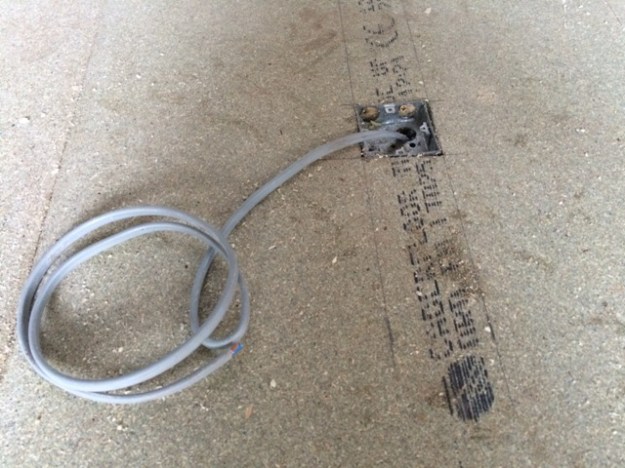

wiring-for-floor-plug-socket-in-new-kitchen

roof-over-back-of-kitchen-nearly-complete

wire-for-outside-light-through-back-wall

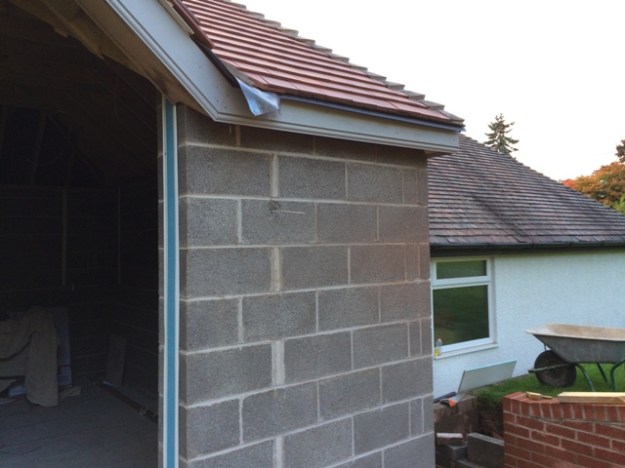

wire-for-outside-light-through-back-wall-on-other-side-of-patio-window

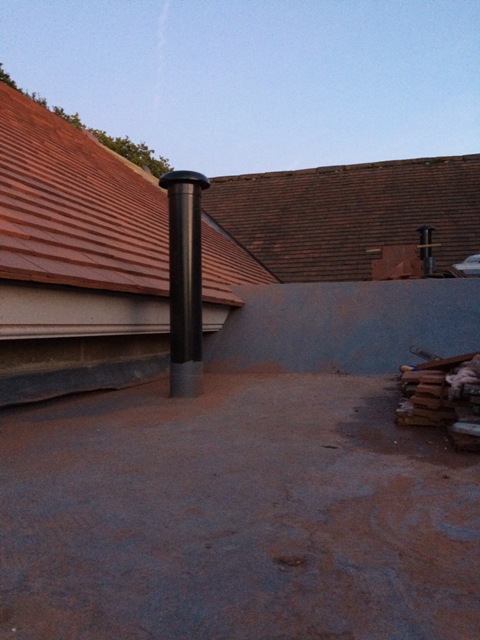

roof-sloping-down-to-flat-roof-nearly-complete

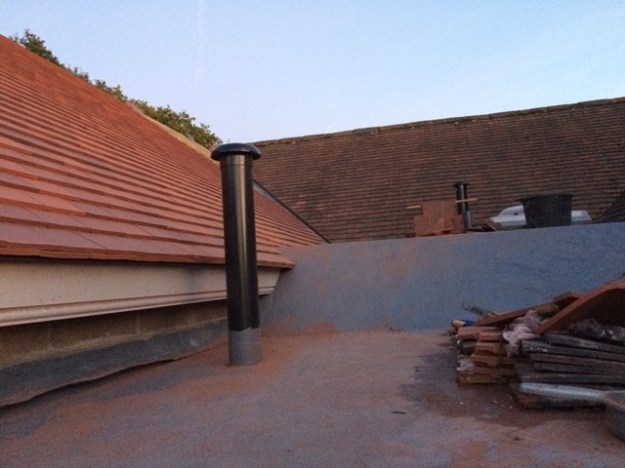

different-view-of-flat-roof-and-tiling-nearly-complete
Day 73 – Wednesday 19th October 2016
Double layers of insulation have been inserted into ceiling area. This has been a tricky job as all pieces need cutting and shaping. The main kitchen area should not be so time consuming as larger straight pieces can be cut.

Celotex insulation in Utility Room

Celotex insulation in Utility Room View from Back Door

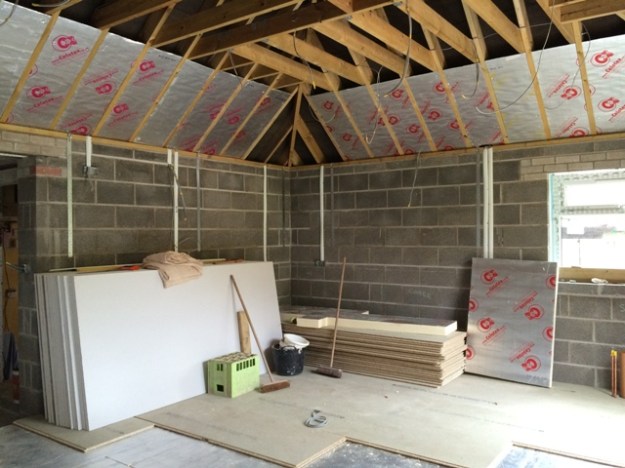

celotex-insulation-in-new-kitchen-entrance
Day 74 – Thursday 20th October 2016
Insulation, insulation, insulation

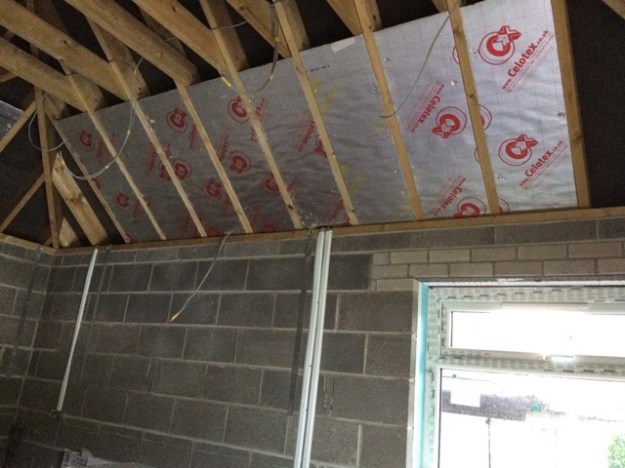

insulation-in-new-kitchen-roof-going-in

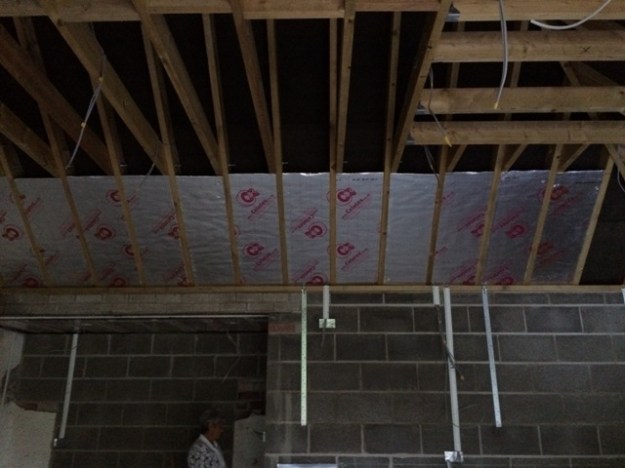

insulation-in-new-kitchen-roof-at-back-of-kitchen-sloping-roof

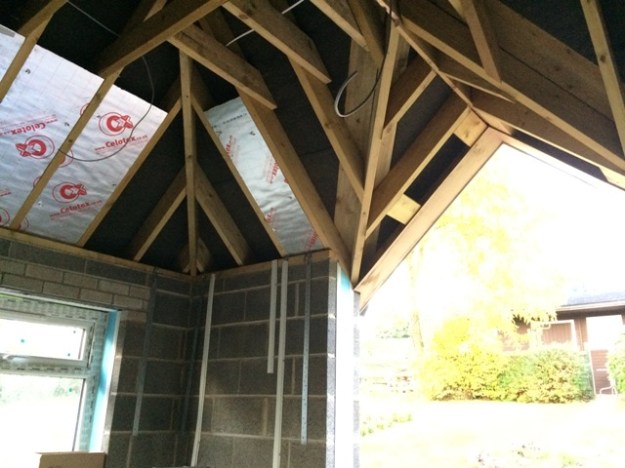

insulation-in-new-kitchen-roof-on-sloping-roof-over-left-hand-window

insulation-in-new-kitchen-roof-on-sloping-roof-over-right-hand-window

insulation-in-new-bathroom-flat-roof

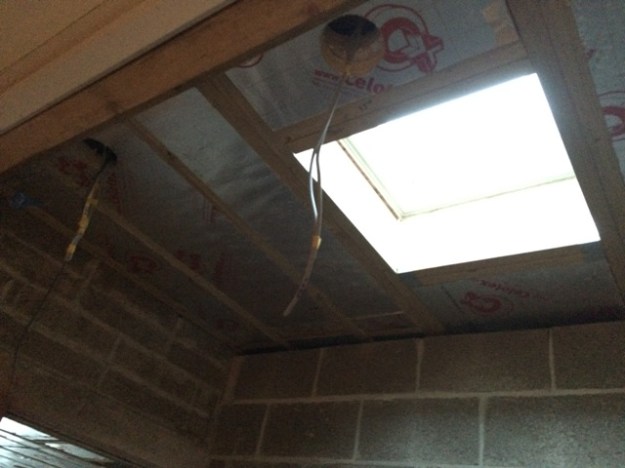

insulation-in-new-bathroom-flat-roof-picture-2
Day 75 – Friday 21st October 2016
More insulation and roof nearly completed

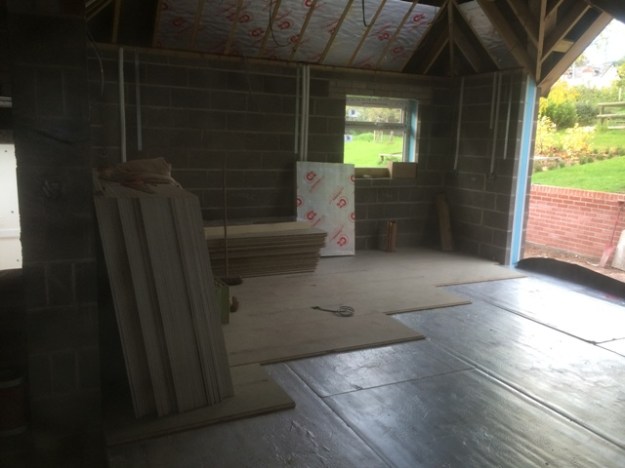

kitchen partly floored and partly insulated

New Kitchen partly floored and partly insulated

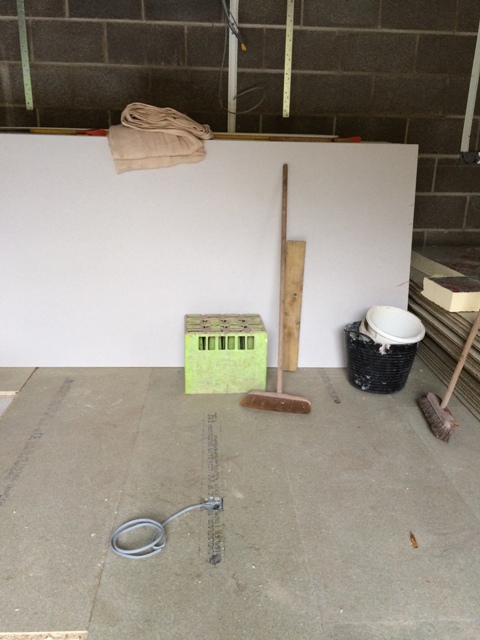

kitchen-with-insulation-partly-complete-and-flooring-also-shows-electrical-plug-socket-in-floor-for-island-unit

electrical-socket-in-flooring-not-yet-connected-in-kitchen-floor-for-island-unit

Roof nearly completed

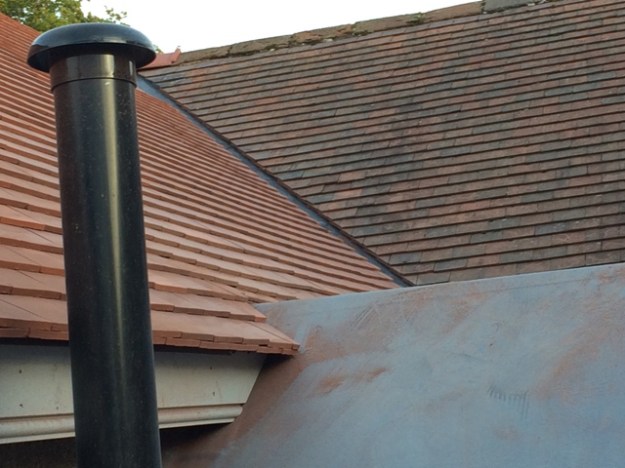

roof-between-old-kitchen-and-new-kitchen
Day 76 – Saturday 22nd October 2016

Kitchen flooring base now complete Insulation on floating floor followed by chipboard

kitchen-flooring-insulation-and-chipboard-complete-view-2
Day 77 – Monday 24th October 2016

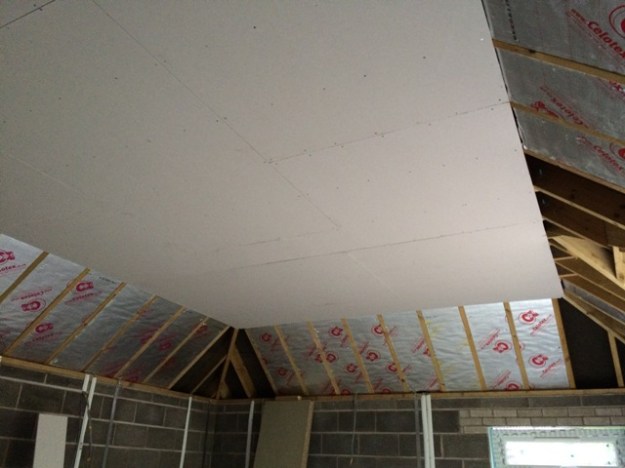

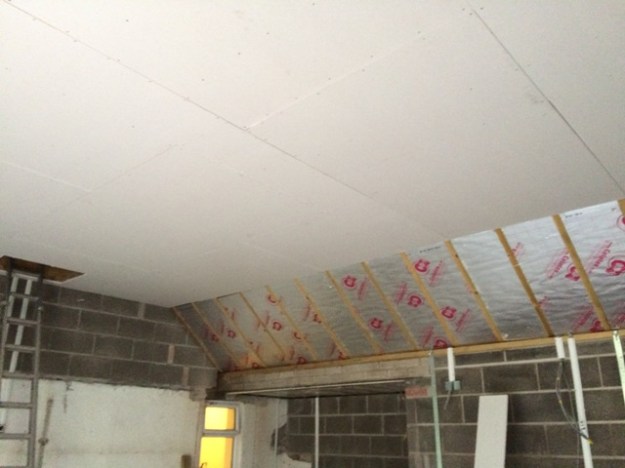

Plaster board is now up on the 10 foot high ceiling. A mobile plasterboard hoist was used to lift it into place

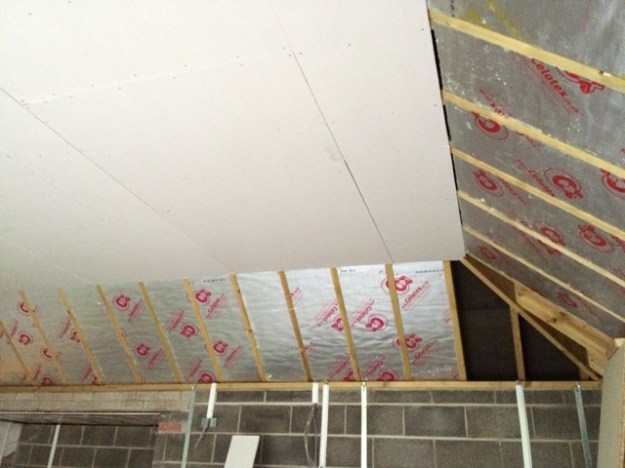

plaster-board-up-on-new-kitchen-ceiling-picture-2-taken-from-front-to-back

plaster-board-on-right-hand-side-of-kitchen

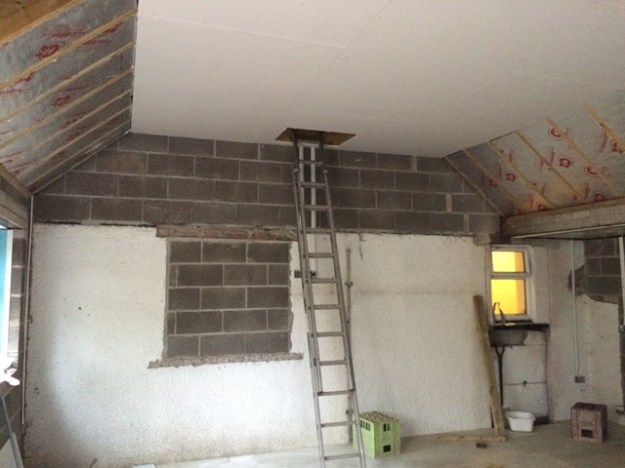

left-hand-side-of-kitchen-showing-new-plaster-board-and-hatch

A damp day today. The view of part of the back garden through the gap for the patio doors.
Day 78 – Tuesday 25th October 2016
Builder and plumber today

View of progress of House from the back

house-from-back-day-78-pic-2

Progress with the plaster boarding in the kitchen

Plaster boarding in the kitchen

plasterboard-window-sill-in-kitchen

plasterboard-2nd-window-sill-in-kitchen-on-right

positions-for-sink-and-toilet-in-new-bathroom

position-for-radiator

position-for-bath-in-new-bathroom

position-for-toilet-in-new-bathroom

position-for-sink-in-new-bathroom

gas-and-water-pipes-in-utility-room

capped-water-pipes-ready-for-sink
Day 79 – Wednesday 26th October 2016

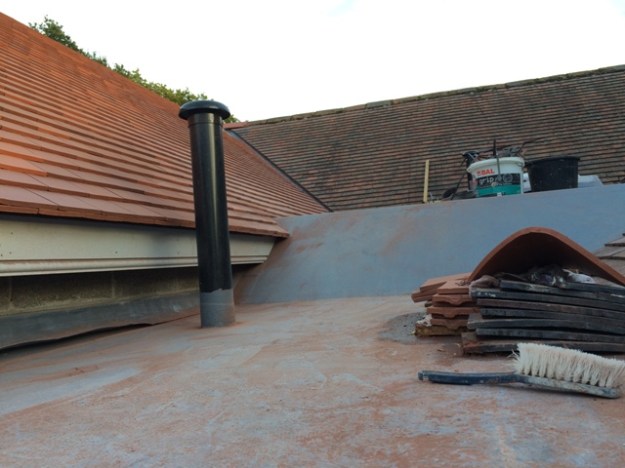

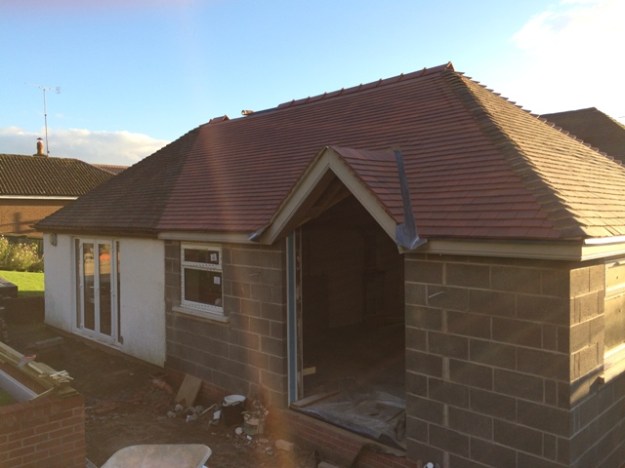

Progress on the roof – Day 79

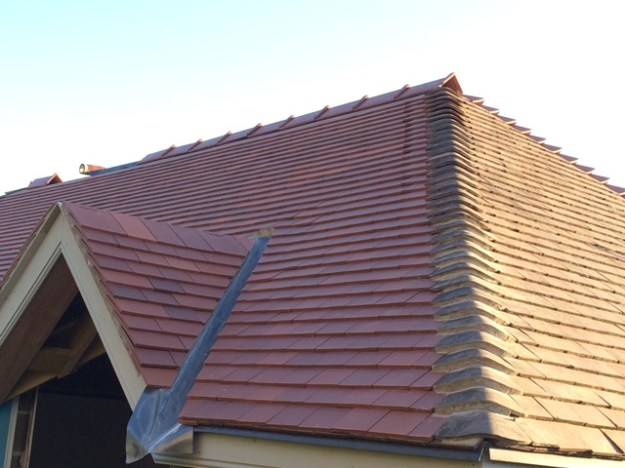

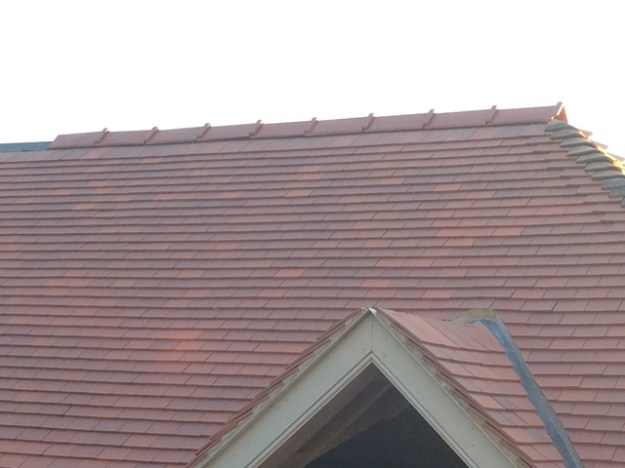

close-up-of-roof-progress

Ridge tiles not yet in final position

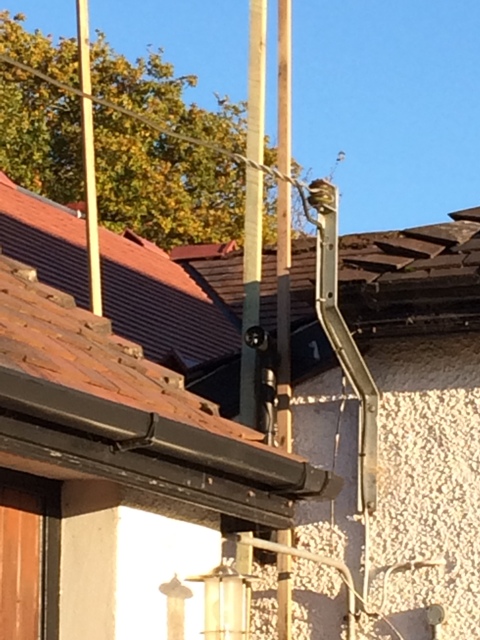

roof-between-old-and-new-building

roof-between-old-and-new-building-from-step-ladder

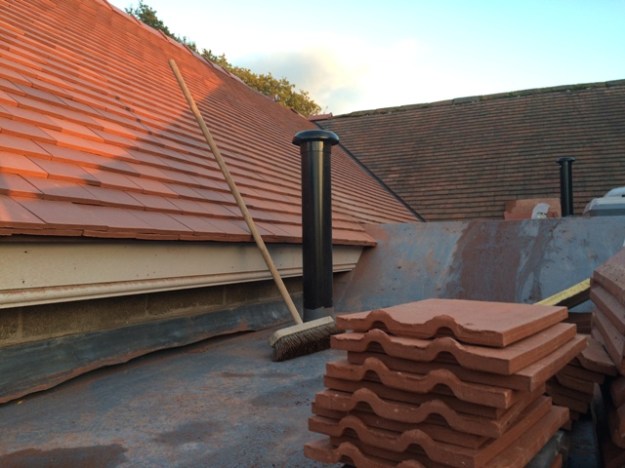

roof-between-old-and-new-building-from-step-ladder-2

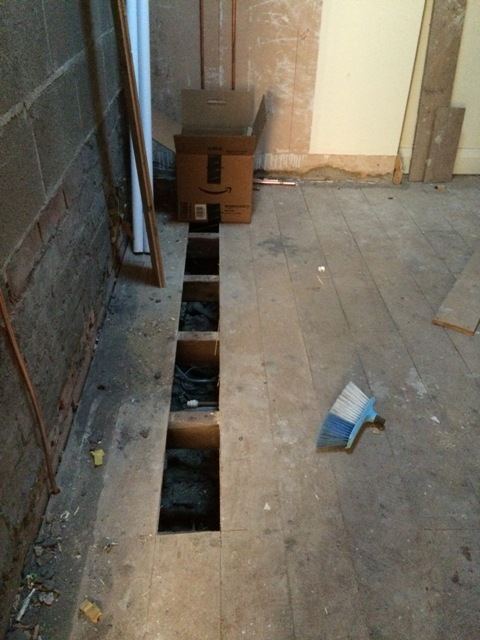

new-bathroom-pipework-under-floor-boards

new-bathroom-pipework-under-floor-boards-2

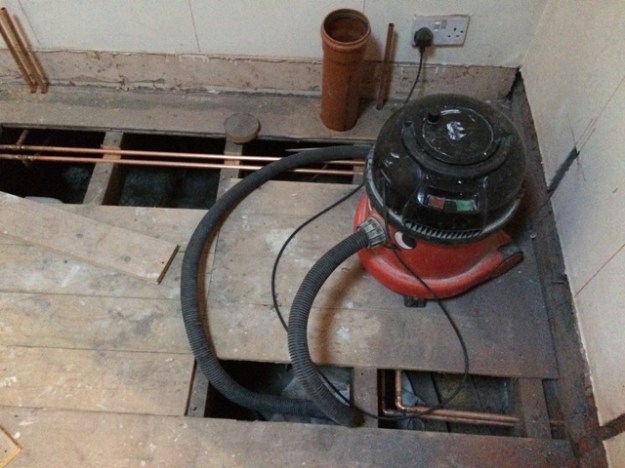

new-bathroom-pipework-under-floor-boards-3

new-bathroom-pipework-for-shower
Day 80 – Thursday 27th November 2016

Spot Marcus, our plumber, in a very tight spot, under the floor in the new bathroom

under-the-new-bathroom-floor-where-toilet-and-sink-will-go

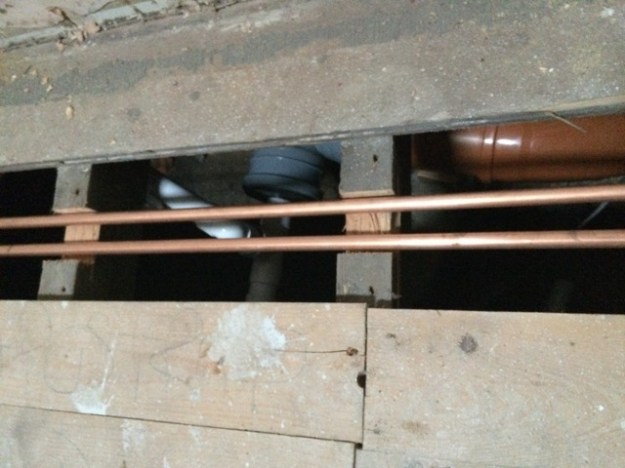

drain-and-pipework-under-floor

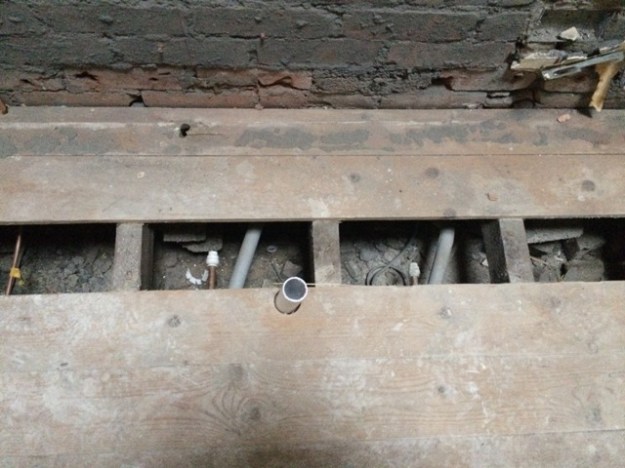

under-the-new-bathroom-floor-where-bath-will-be-positioned

new-plasterboard-ceiling-in-utility-room

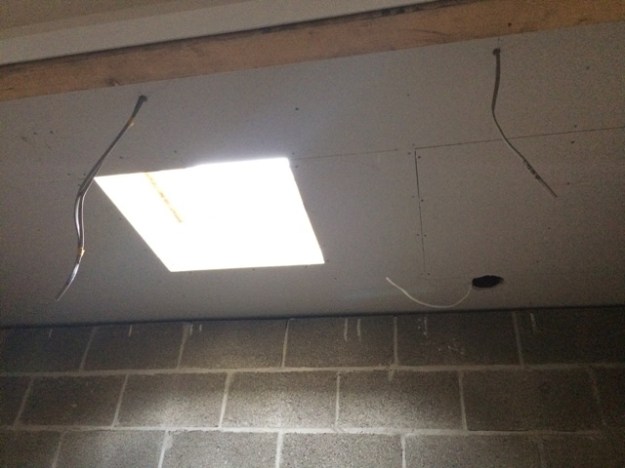

new-plasterboard-ceiling-in-new-bathroom

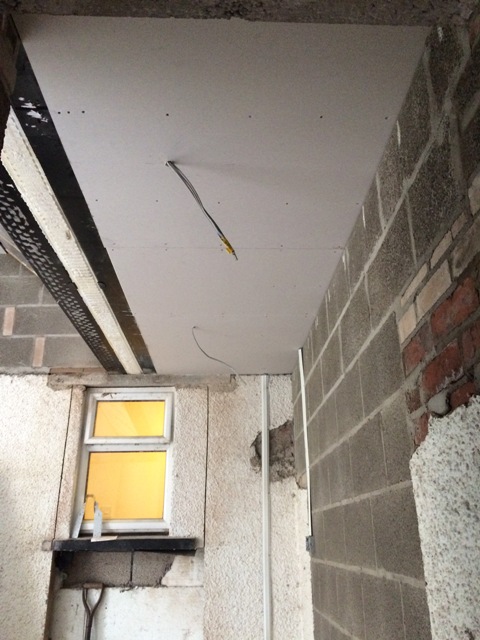

new-plasterboard-ceiling-in-entrance-to-kitchen-beneath-flat-roof
Day 81 – Friday 28th October 2016
Patio doors for kitchen arrived today

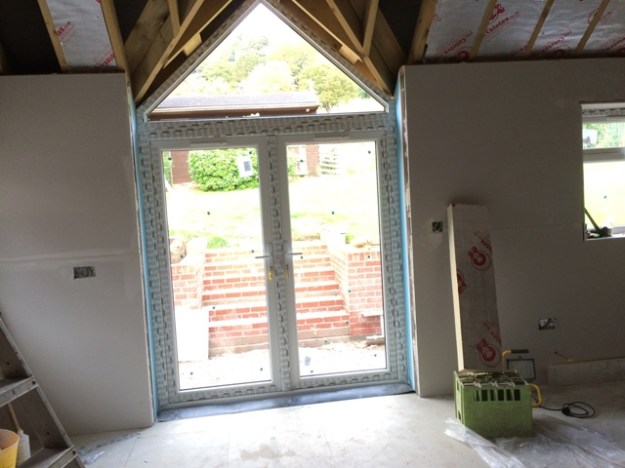

new-patio-doors-in-new-kitchen-from-inside

New patio doors minus the apex window on order fitted by Clive and Chris

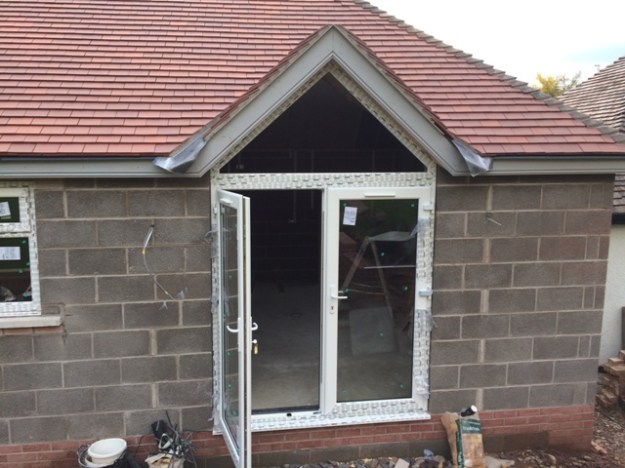

new-patio-doors-to-new-kitchen-from-outside

new-patio-doors-to-new-kitchen-from-outside-2
Day 82 – Saturday 29th October 2016
Plumber today, connecting up pipework under the house.

New drainage pipe for a sink in the utility room and hot and cold water pipes

In new bathroom the pipes-for-towel-rail-capped

pipework-in-place-for-new-bath-in-bathroom

old-radiator-in-utility-reconnected-now-re-routed-under-house

pipework-through-wall-to-new-kitchen

pipework-for-radiator-under-the-window-in-the-new-kitchen-capped

pipework-capped-ready-for-large-radiator-in-new-kitchen-this-blockwork-was-the-old-small-bedroom-window
Day 83 – Monday 31st October 2016

back-right-kitchen-corner-now-plasterboarded

double-plasterboarding-under-lintel

front-right-kitchen-corner-now-plasterboarded

utility-room-now-plasterboarded
Day 84 – Tuesday 1st November 2016

foil-insulation-going-into-sloping-roof-of-kitchen

foil-insulation-in-kitchen

wiring-holes-in-plasterboard

wiring-through-plasterboard-ceiling

ridge-tiles-nearing-completion
Day 85 – Wednesday 2nd November 2016

foil-insulation-in-corner-of-kitchen

foil-insulation-in-left-corner-of-kitchen

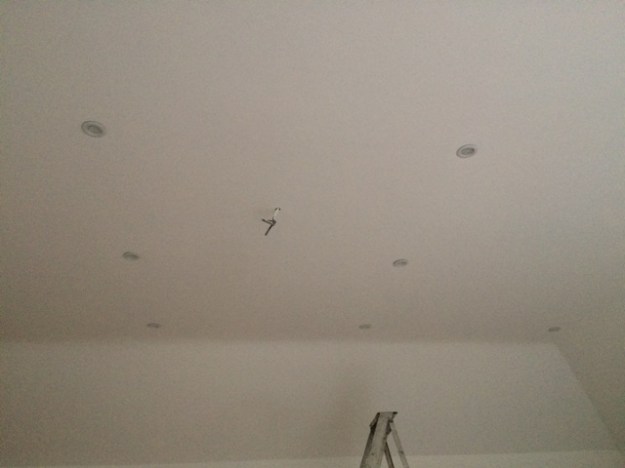

Holes cut in plasterboard for lighting – lots-of-it!
Day 86 – Thursday 3rd November 2016

new-bathroom-plasterboarding-double-in-places-to-fill-gaps

new-bathroom-plasterboarding

new-door-frame-around-new-bathroom-door-picture-2

new-door-frame-around-new-bathroom-door

new-door-frame-around-new-kitchen-door-top-of-steps
Day 87 – Friday 4th November 2016

Plasterboarding in new bathroom – old beam boxed in

plasterboarding-new-bathroom-beam-boxed-in

plasterboarding-in-utility
Day 88 – Monday 7th November 2016

New step built into new bathroom

plasterboard-and-plastering-around-new-doorway-into-new-bathroom

kitchen-at-present

Made Cotswold Crunch bread whilst waiting for the plumber!
Day 89 – Wednesday 9th November 2016

new-loft-area-over-new-kitchen

new-loft-area-over-new-kitchen-pic2

new-loft-area-over-new-kitchen-pic3

new-loft-area-from-new-kitchen-to-old-existing-roof

mess-after-holes-drilled-for-new-doorway-from-hall-to-new-kitchen

holes-in-wall-ready-for-doorway-to-be-cut-through-pic-3

holes-in-wall-ready-for-doorway-to-be-cut-through-pic-2

holes-in-wall-ready-for-doorway-to-be-cut-through
Day 90 – Thursday 10th November 2016

blanket-insulation-in-sloping-roof-covered-by-plasterboard

close-up-of-blanket-insulation-above-patio-doors

view-through-new-kitchen-patio-windows-up-the-hillside-lovely-autumnal-day
Day 91 – Friday 11th November 2016
New Triangular Shaped glass, made to measure went in today over patio doors. Also plaster boarding above hip roof inside new kitchen now finished.

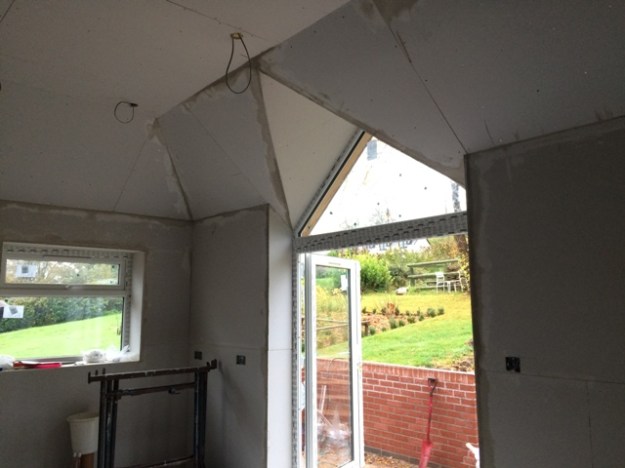

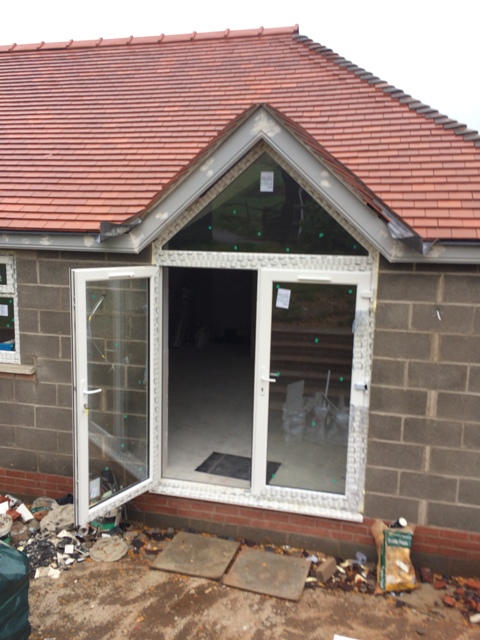

Plasterboarding over the hip roof around patio doors now complete

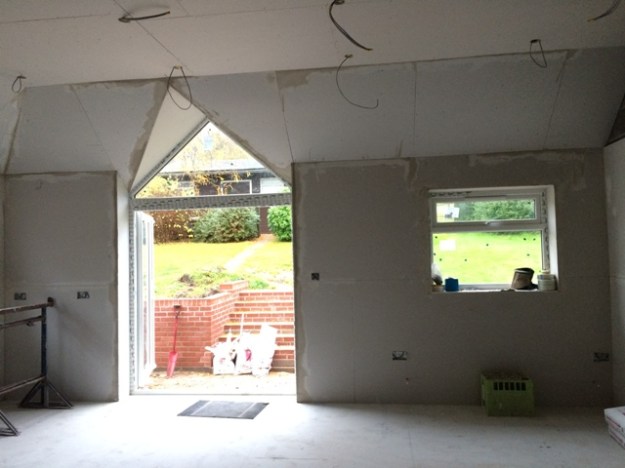

plaster-board-complete-in-new-kitchen-over-hip-roof

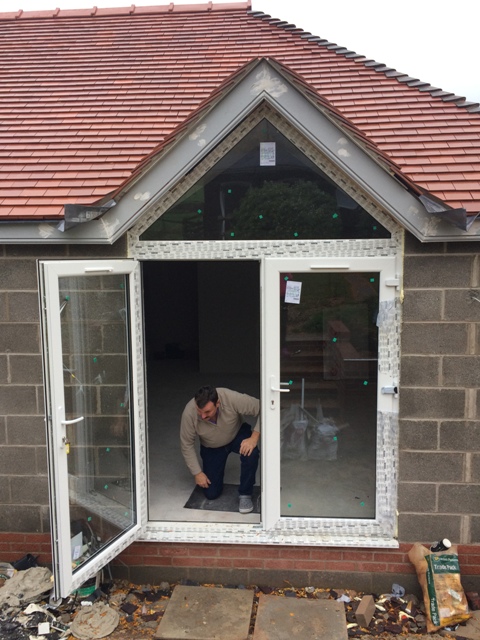

patio-doors-and-triangular-glass-fitted-above

new-patio-doors-with-triangular-window-fitted-above

new-triangular-window-over-patio-door
Day 92 – Monday 14th November 2016
The break through into the house.

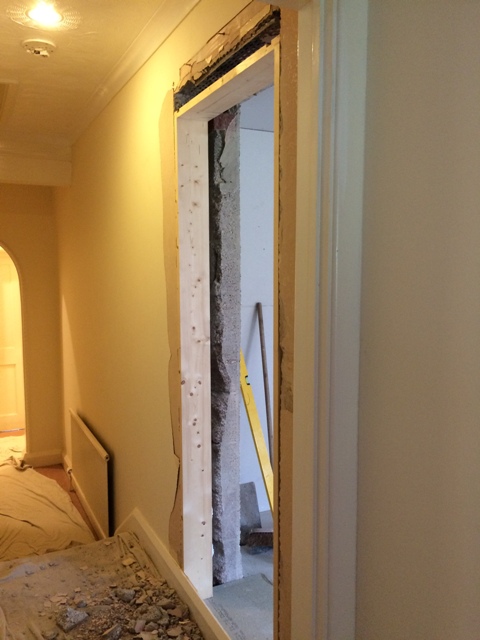

breaking-out-of-the-hall-into-the-new-kitchen

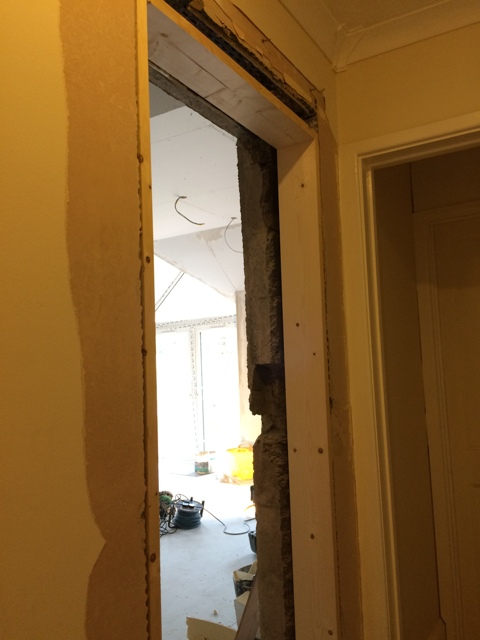

doorway-knocked-through-to-kitchen

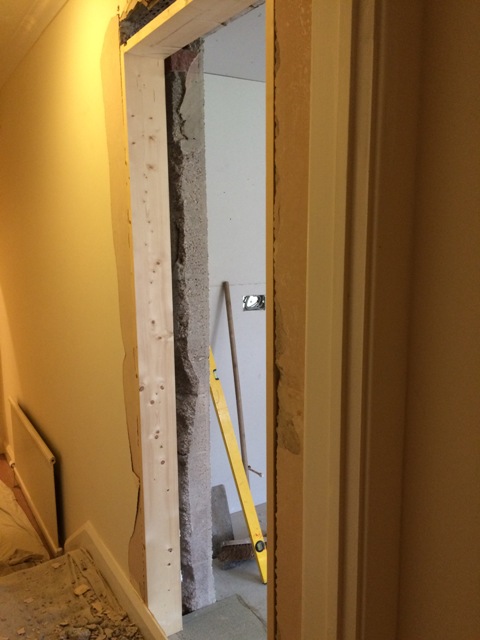

finally-a-link-to-the-new-kitchen

new-doorway
Day 93 – Tuesday 15th November 2016
Then and Now

28th September this is what the wall looked like!

Today 15th November wall looks like this New Kitchen wall finished with dot and dab plaster board technique, ready for plasterer

Window to left of wheel barrow is now the doorway in the next picture. This photo taken on 26th July 2016.

New doorway into main house, with frame and plasterboard surround ready for plasterer. This was the small window in the photo above.

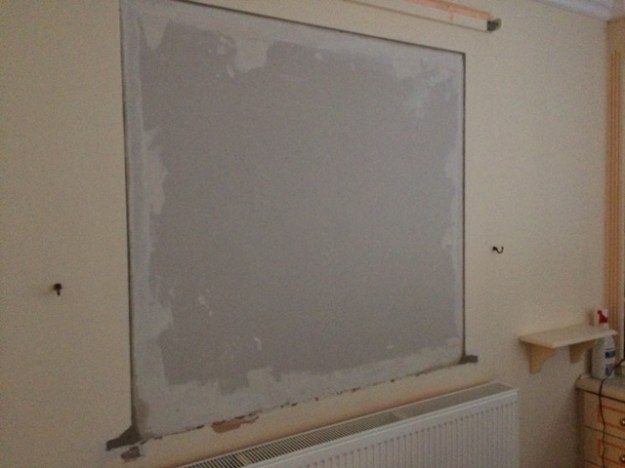

old-window-position-from-main-bedroom-to-outside-now-bricked-up-new-kitchen-on-the-other-side
What it used to look like below

Before being bricked up – 29th August 2016
Day 94 – Wednesday 16th November 2016
Plasterer in new kitchen today

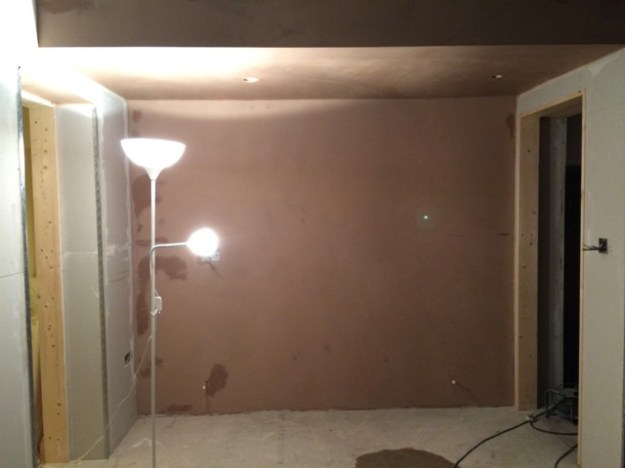

Plastering along the back wall of the kitchen adjacent to the two doorways

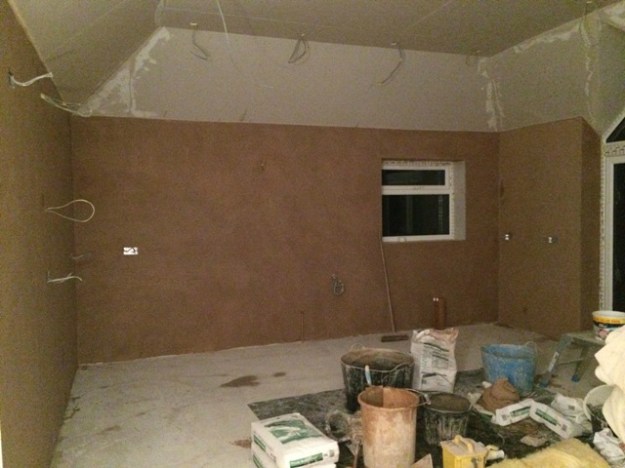

Plastering along the wall adjacent to the garage. All the kitchen units are planned for this area

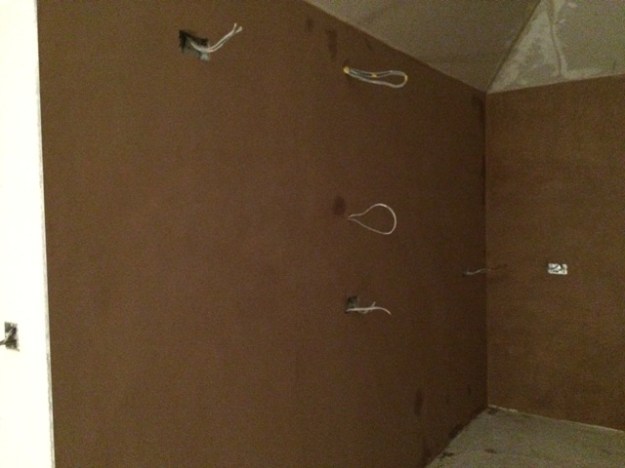

plastering-along-wall-where-fridge-freezer-will-sit-hence-high-plug-sockets-easy-to-turn-on-and-off-for-defrosting

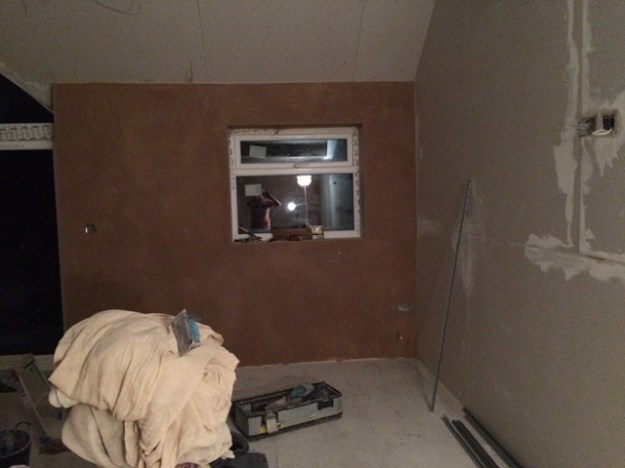

plastering-on-right-hand-side-of-patio-doors

ceiling-plastered-between-2-doorways
Day 95 – Thursday 17th November 2016

large-wall-adjacent-to-main-bedroom-now-plastered

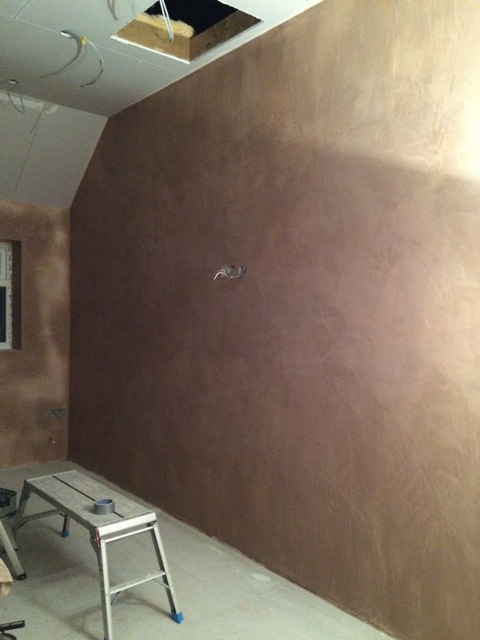

large-wall-adjacent-to-main-bedroom-now-plastered-pic-2

Plasterer’s van

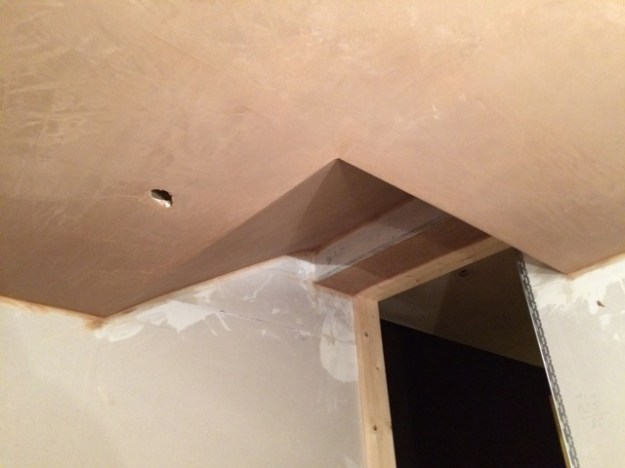

sloping-ceiling-to-new-kitchen-plastered

utility-room-ceiling-plastered

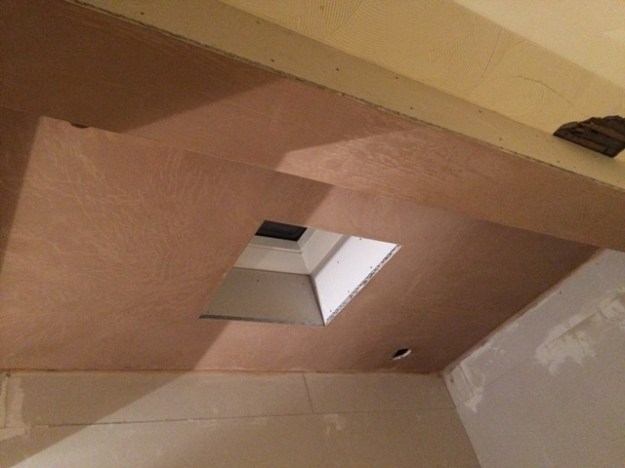

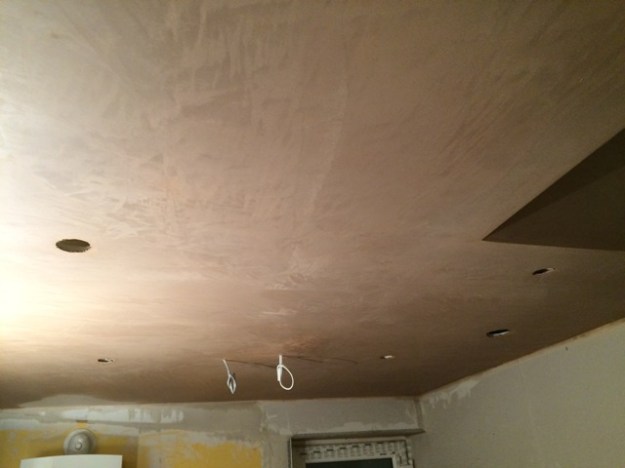

new-bathroom-ceiling-partly-plastered
Day 96 – Friday 18th November 2016
Wall beside patio – preparation and rebuild of existing wall. Also plastering progress in new bathroom and kitchen.

bathroom-plastering

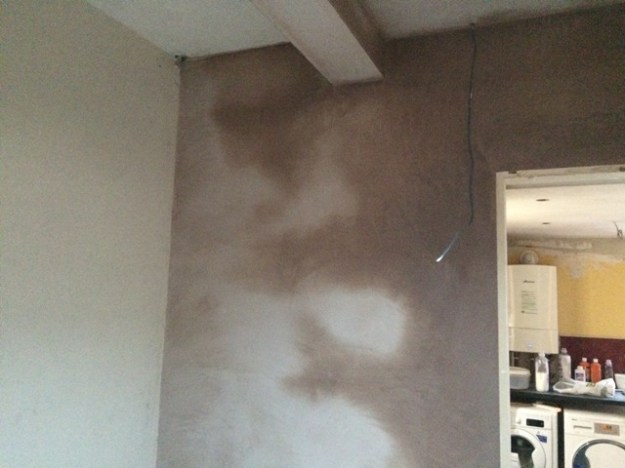

bathroom-plastering-2

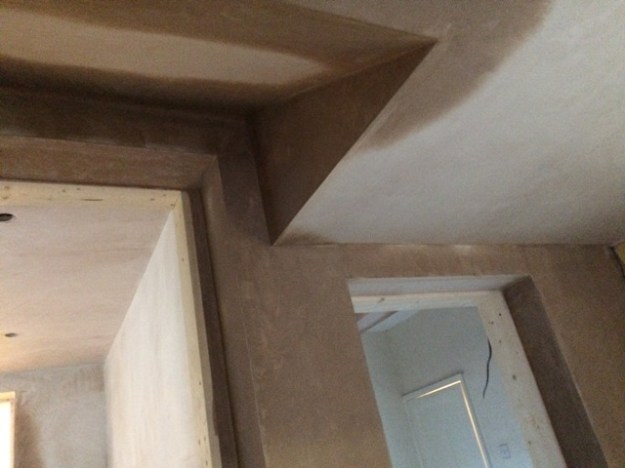

sloping-ceiling-to-new-kitchen

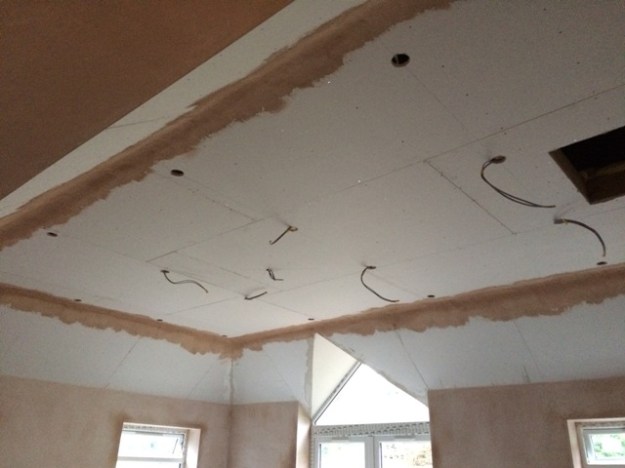

plaster-around-ceiling-in-new-kitchen

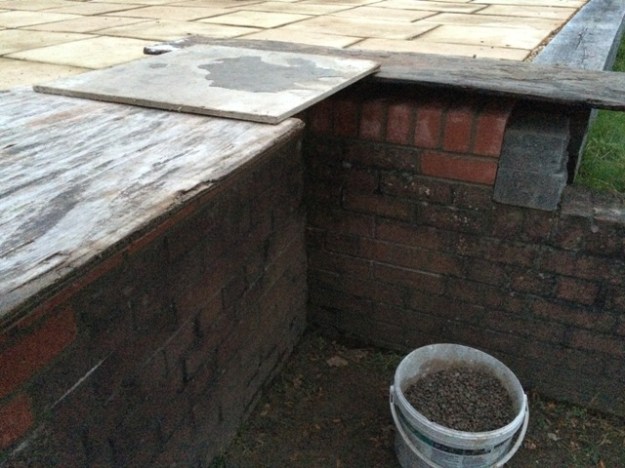

Rebuild of old wall in front of patio

Old wall merges into new

Five steps are to be constructed here up to patio
Day 97 – Monday 21st November 2016
So wet today – torrential rain all day
Plasterer was off sick and rain stopped play on the wall outside for the builder.
Some architraves around doorways were fixed on and husband started stripping wallpaper in the old bedroom which is now a bathroom.

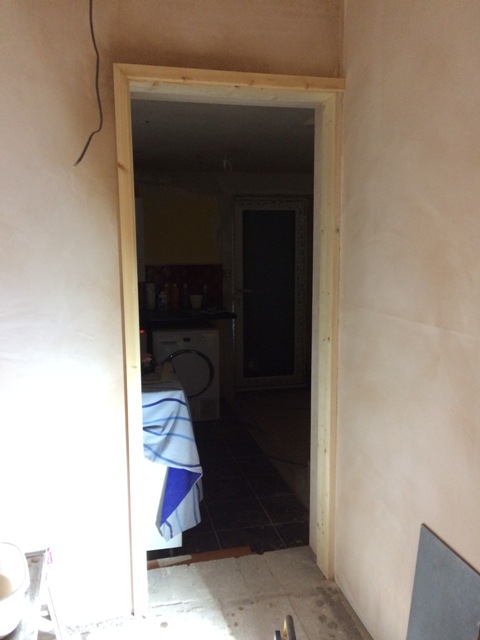

architraves-around-doorway

Removing old wallpaper
Day 98 – Tuesday 22nd November 2016

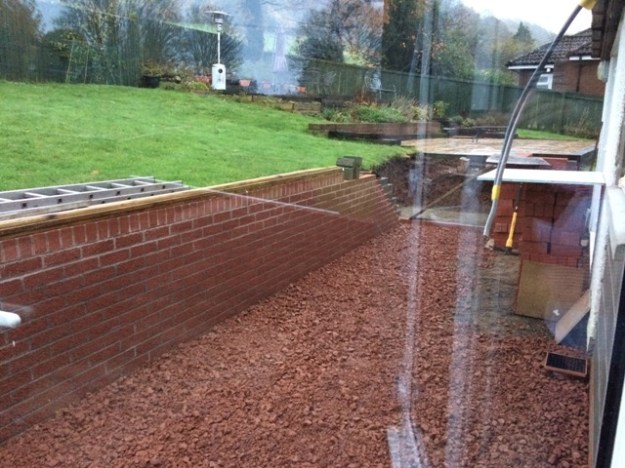

delivery-of-chippings-10-tons-for-bottoming-under-new-patio

delivery-of-chippings-10-tons-for-bottoming-under-new-patio-pic-2

delivery-of-chippings-10-tons-for-bottoming-under-new-patio-pic-3

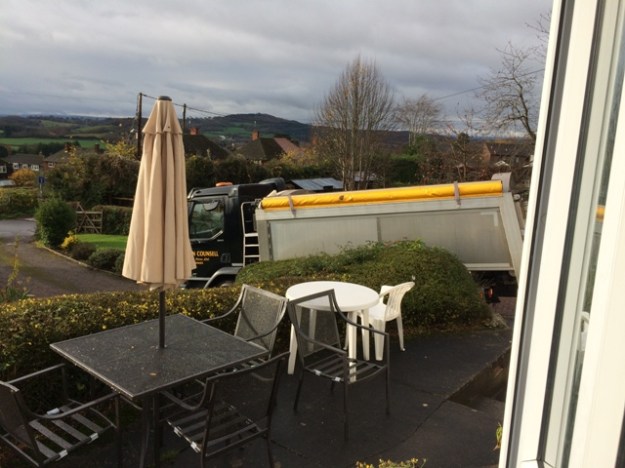

delivery-of-chippings-10-tons-for-bottoming-under-new-patio-pic-4

delivery-of-chippings-10-tons-for-bottoming-under-new-patio-dumped-on-drive

chippings-used-right-along-the-back-of-the-house-in-preparation-for-new-slabs-being-laid

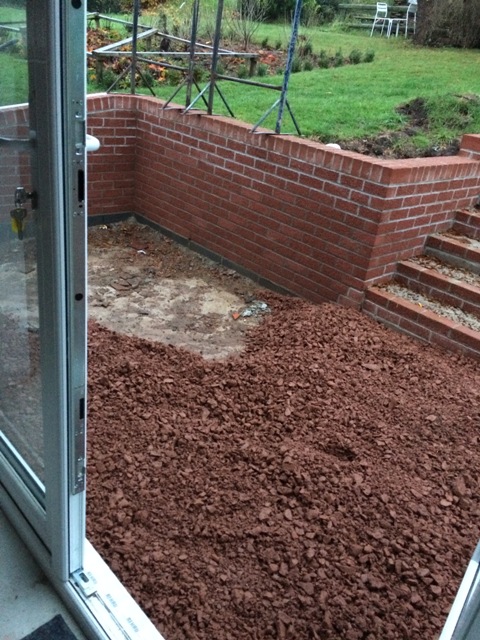

chippings-used-at-the-back-of-the-kitchen

first-coat-of-paint-over-plaster-in-kitchen-watered-down-so-it-does-nor-flake-when-second-coat-is-applied

first-coat-of-watered-down-paint-applied-but-ceiling-not-plastered-yet-so-no-painting-higher-up

kitchen-painting

painting-at-the-back-of-kitchen
Day 99 – Wednesday 23rd November 2016
Amazing pictures of our plasterers on stilts!!!

a-lot-of-workmen-this-morning-builder-2-plasterers-and-guy-to-do-fibre-glass-roof-repair
Quite funny really, had a Viv, a Matt, and a Tom working here today! All names of family members!

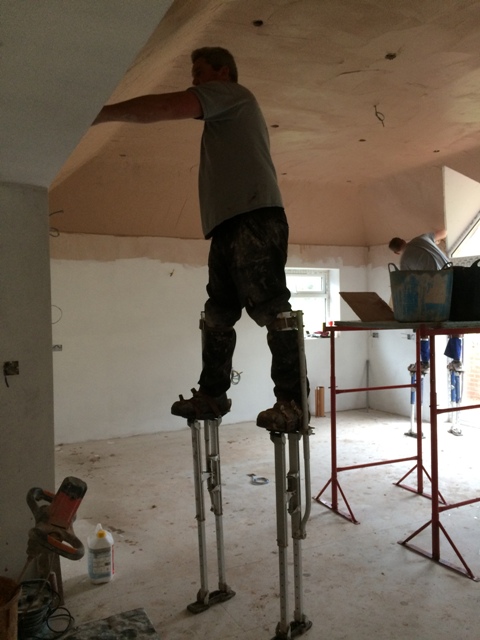

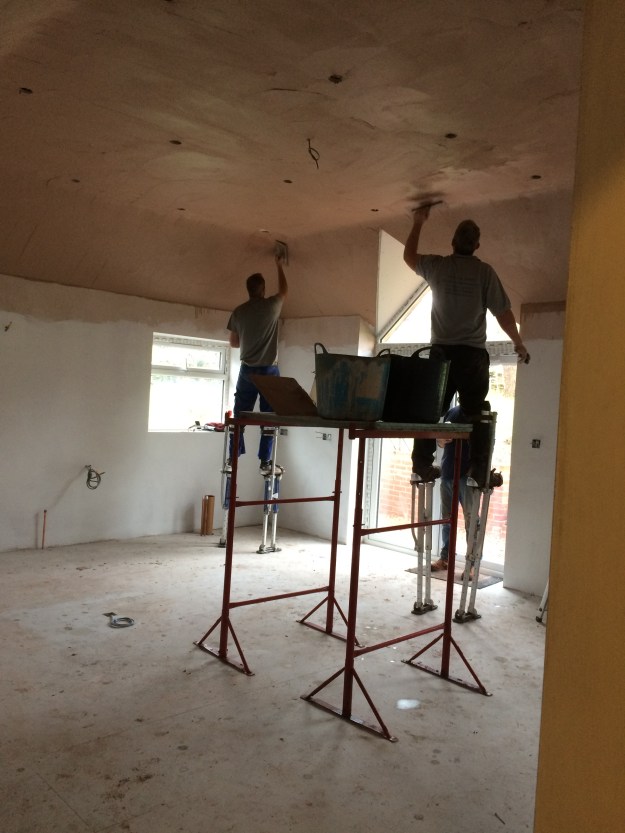

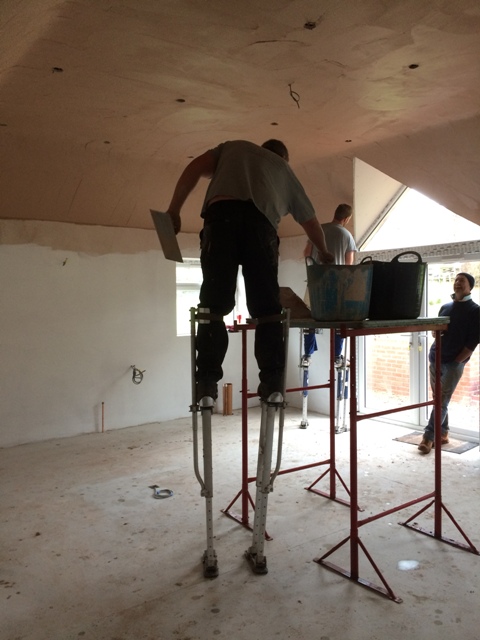

plasterers-on-stilts-skimming-the-very-high-ceiling-this-was-amazing

plasterers-at-work-on-stilts

plasterers-at-work-on-stilts-3

plasterers-at-work-on-stilts-2

base-for-steps-laid

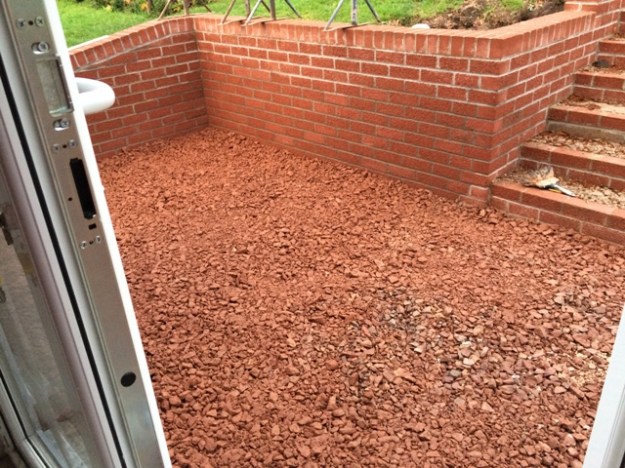

bottoming-for-patio-slabs-to-be-laid-on

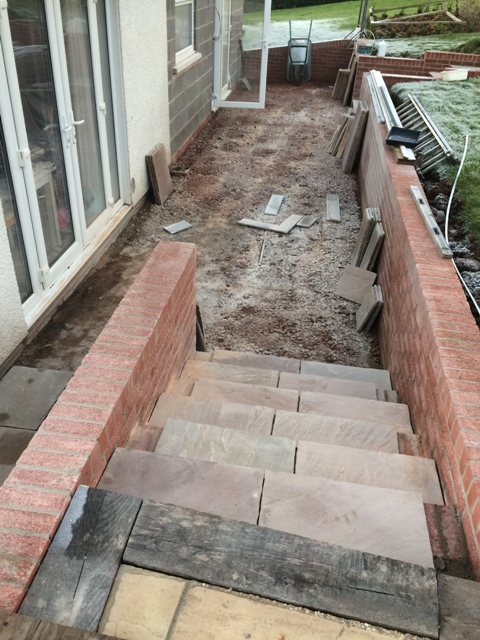

Day 100 – Thursday 24th November 2016
Plastering and outside work on new patio

Back of new kitchen and Bedroom – scaling all levelled

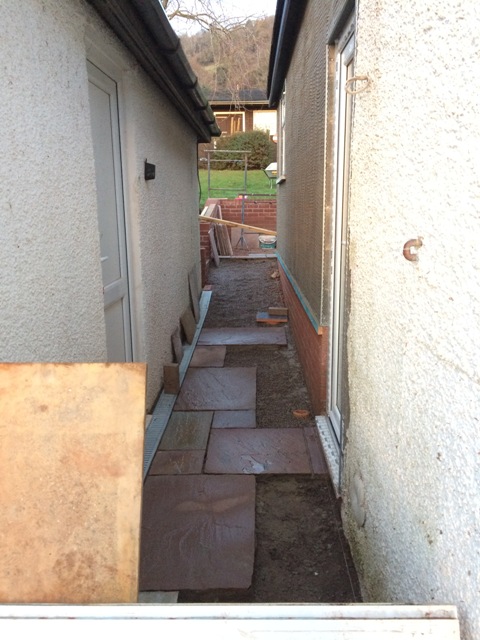

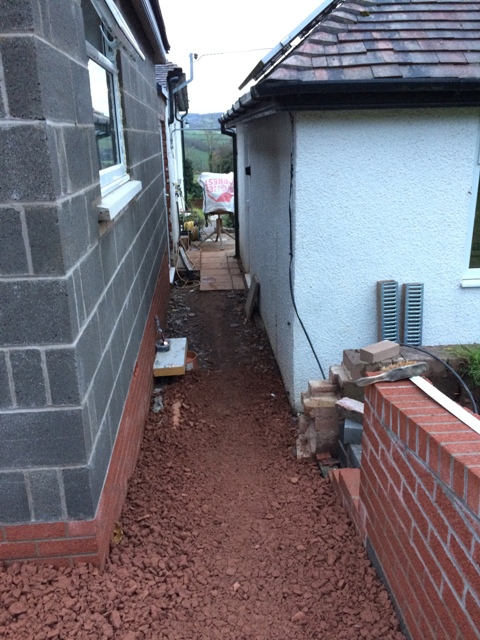

walkway-between-garage-and-new-kitchen-stones-laid-to-form-a-ramp

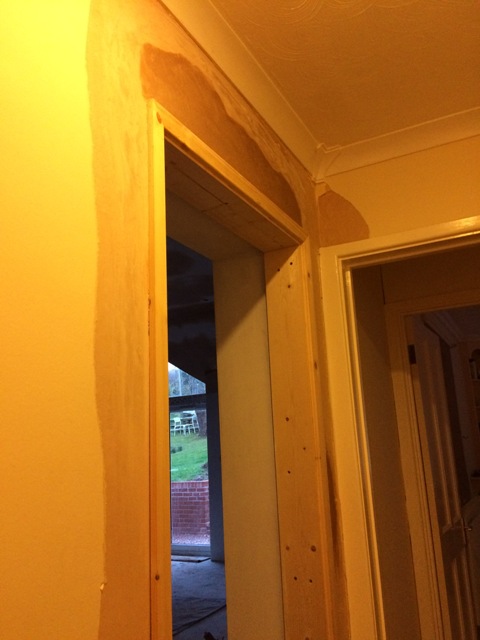

plaster-repaired-around-new-doorway-entrance-to-kitchen-from-corridor

ceiling-in-new-bathroom-now-totally-replastered

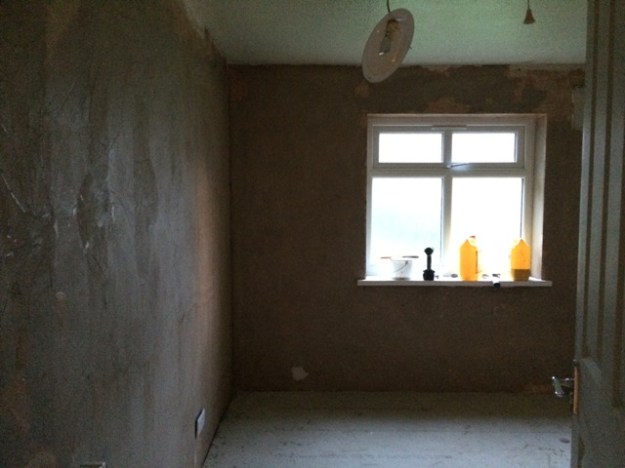

new-small-bedroom-converted-from-sauna-last-year-walls-prepared-and-patched-ready-for-skim-coat-of-plaster

new-small-bedroom blurred-picture-no-light-walls-prepared-for-plastering

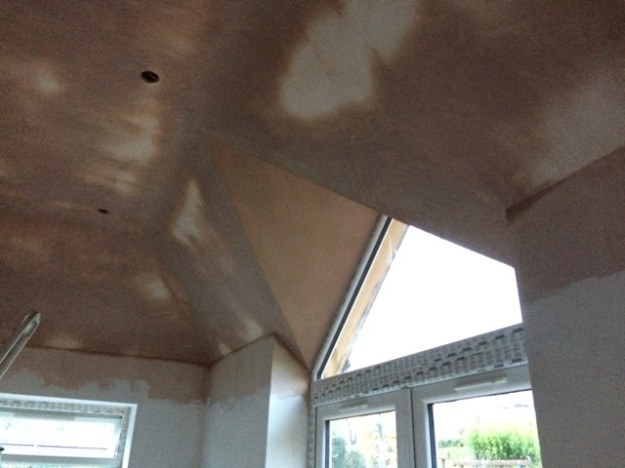

hip-roof-area-plastered-inside

new-kitchen-ceiling-plaster-starting-to-dry-out-slowly

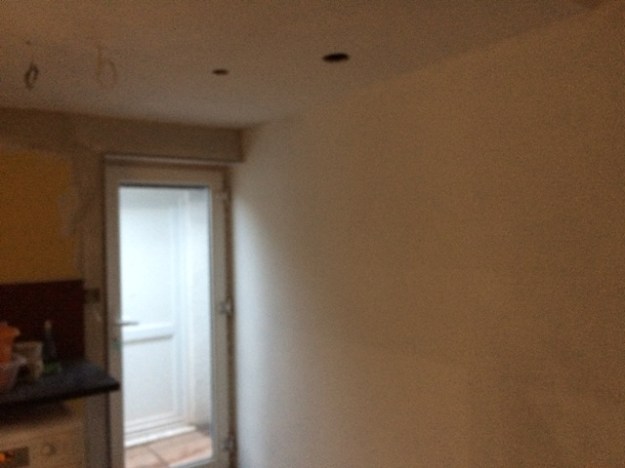

utility-area-ceiling-painted

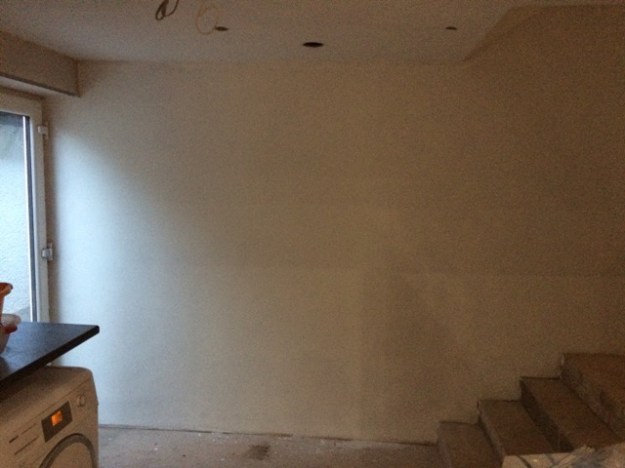

utility-area-wall-and-ceiling-painted
Day 101 – Friday 25th November 2016

steps-up-to-patio-from-new-patio-area-taking-shape

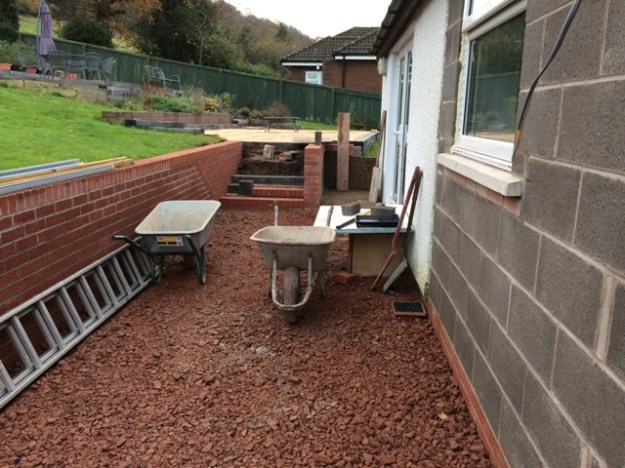

another-view-of-step-progress-up-to-patio

new-bedroom-plastered-now-drying-out

new-bedroom-plastered-now-drying-out-pic-3

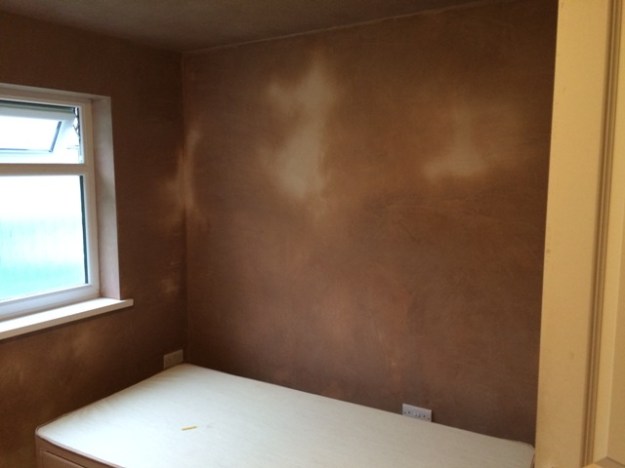

new-bedroom-plastered-now-drying-out-pic-2

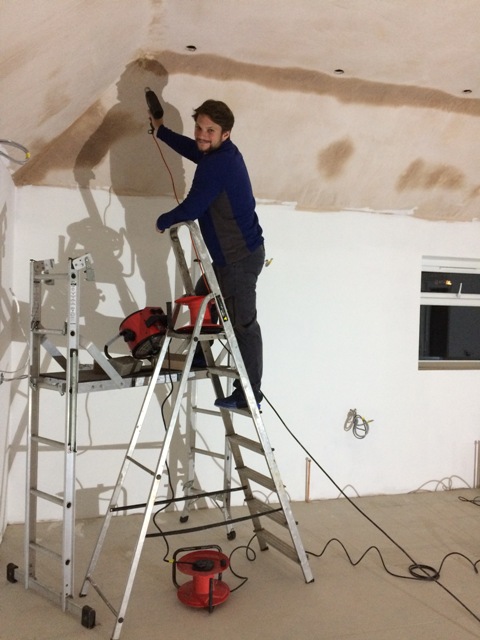

wills-helping-out-drying-the-plaster-on-ceiling-ready-for-painting

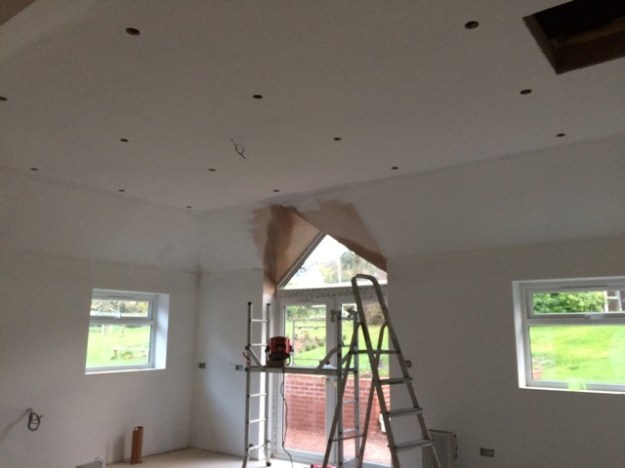

new-kitchen-with-1st-coat-of-paint-on-ceiling

painted-kitchen-another-coat-to-go

kitchen-with-another-coat-of-paint

hip-roof-plaster-now-drying-out

laminate-flooring-for-kitchen-delivered
Day 102 – Saturday 26th November 2016

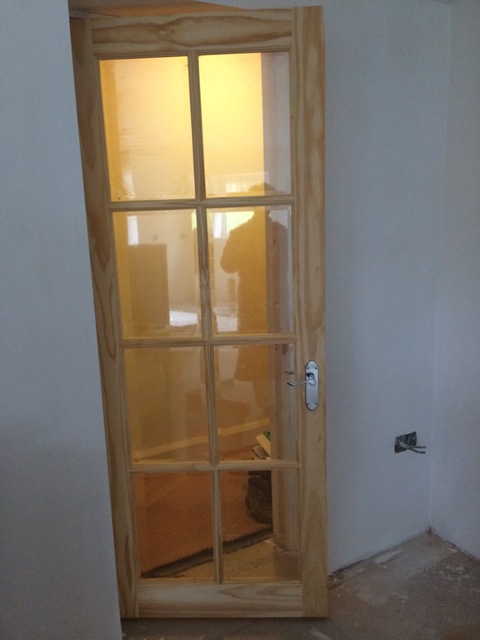

Kitchen delivered! Painting continues and the first internal door is fitted!

The kitchen has arrived all the way from Hull

Wrens Kitchens

Delivery vehicle just about got up the driveway. Had to back up the road

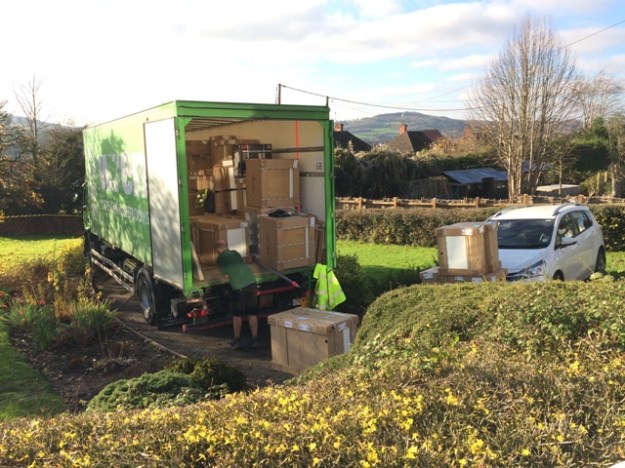

kitchen-delivery-from-wrens

kitchen-delivery

Kitchen in Kitchen!

The first internal door to be fitted from new kitchen to hallway.
Day 103 – Sunday 27th November 2016

Close up of laminate for new kitchen floor

Tony laying the laminate flooring on a layer of underlay

Progress of laminate floor so far

Paul-painting-another-coat-to-utility-ceiling before electrician on Monday

Utility area painting
Day 104 – Monday 28th November 2016
Electrician in today wiring up all sockets in the kitchen ready for the power switch on, later this week! Also builder finishing brick work on steps to main patio.

brickwork-for-steps-up-to-main-patio-now-finished-new-indian-sandstone-slabs-to-be-put-on

steps-beside-side-kitchen-window-base-prepared-and-protected-from-frost

new-plug-sockets-in-small-bedroom-prepared-no-electrics-in-here-before-as-this-was-a-bathroom

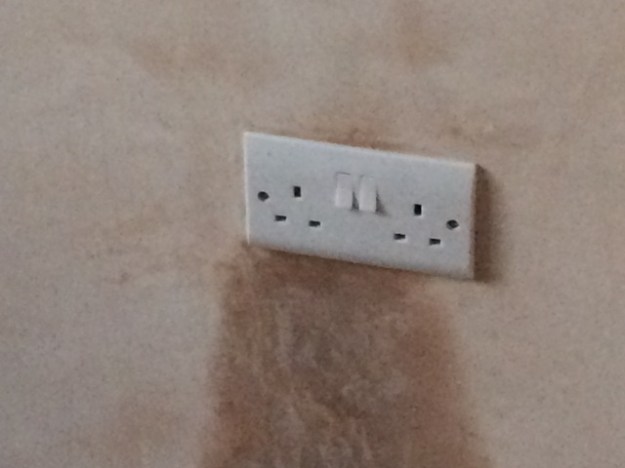

plug-sockets-wired-up-in-small-bedroom-after-plastering
Day 105 – Tuesday 29th November 2016
Temperatures below zero today, -5C. No work on the wall, steps or slabs. Tap outside frozen. New little bedroom painted with first coat of paint over newly plastered walls.

base-for-new-step-beside-kitchen-window-no-work-on-it-today-due-to-temps-below-zero-5-c-this-morning

new-small-bedroom-with-first-coat-of-paint
Day 106 – Wednesday 30th November 2016

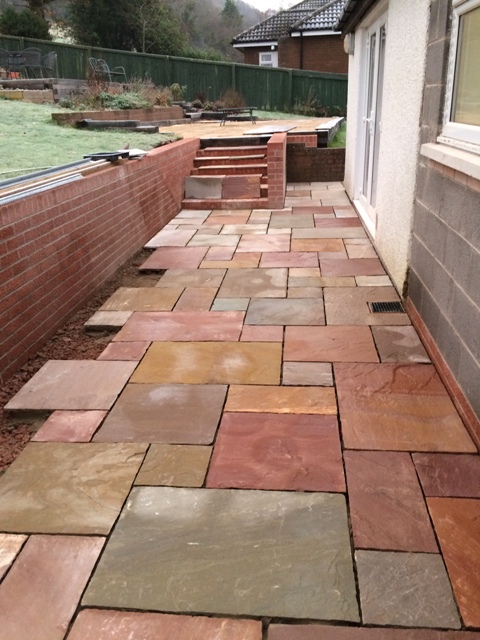

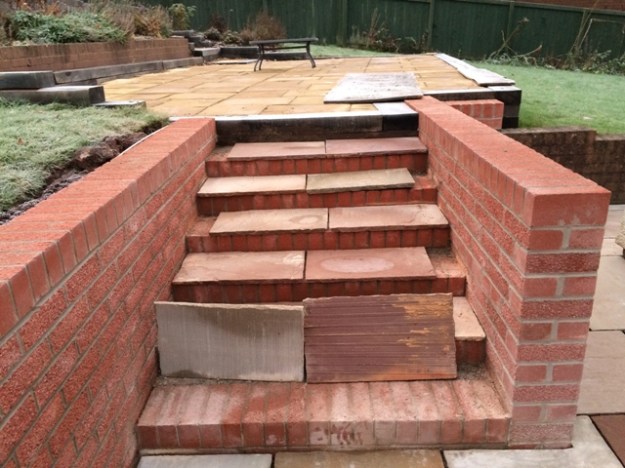

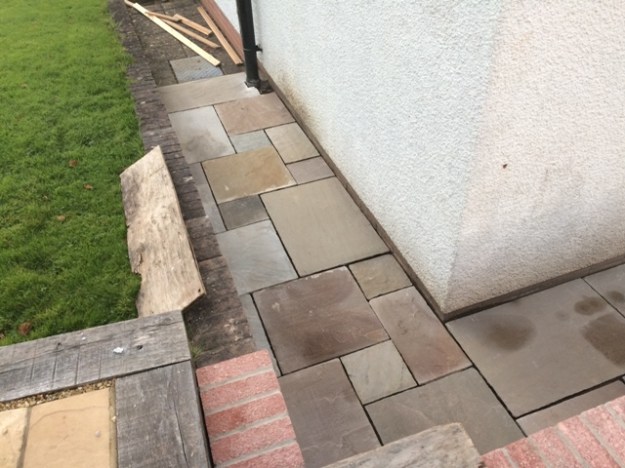

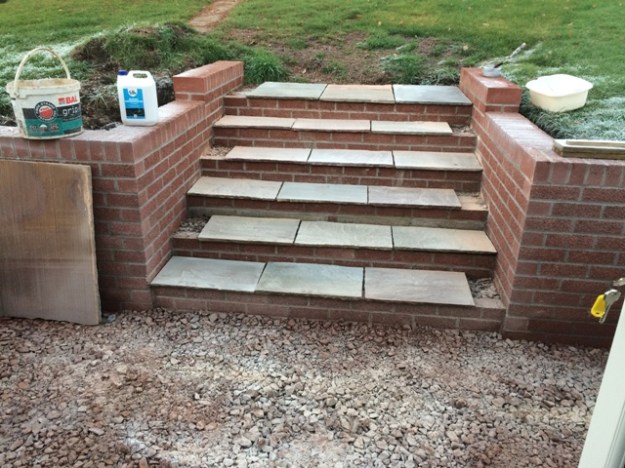

Steps with Indian Sandstone slabs placed on- all have been cut to size today but too-cold-for-laying

Steps with -Indian-sandstone-slabs, cut today, up the new side-steps-to-main-patio

view-from-main-patio-along-back-of-house-slabs-cut-ready-for-laying

slabs-cut-at-side-of-house

some-of-16-lights-installed-in-kitchen-ceiling
Day 107 – Thursday 1st December 2016

We have lights! In new kitchen

new-lights-in-kitchen-pic-3

new-lights-in-kitchen-pic-2

lights-now-connected-in-new-kitchen

lights-in-utility-room-this-is-a-great-light-has-an-occupancy-sensor-so-light-comes-on-immediately-on-entering-from-which-ever-of-the-4-doors-you-come-through
Day 108 – Friday 2nd December 2016

steps-to-patio-slabs-cut-and-laid-waiting-to-be-fixed-when-weather-is-above-freezing

slabs-cut-for-patio-indian-sandstone-all-vary-in-colour-creating-a-patterned-effect
Day 109 – Saturday 3rd December 2016

patio-with-slabs-cut-ready-to-be-secured

inside-of-hip-roof-now-painted-twice

bathroom-ceiling-now-painted-for-a-3rd-time
Day 110 – Sunday 4th December 2016

view-of-flooring-from-window-new-units-in-centre – Flooring now finished

flooring-finished-new-kitchen-units-now-sitting-in-centre-of-kitchen-whilst-floor-is-laid

hatch-put-in Access to roof space

slabs-now-being-cemented-into-place-for-new-patio-at-back-of-new-kitchen
Day 111 – Monday 5th December 2016
Delivery of kitchen unit to replace damaged one. Step at side of kitchen window put in. Plasterers/roughcast guys returned to put metal and wood edgings on new walls, in preparation for scratch coat

new-bathroom-suite-arrived-today-for-new-downstairs-family-bathroom

view-from-bathroom-to-utility-no-door-on-yet

3-shower-boards-1-shower-screen-and-heated-towel-rail

ramp-and-walkway-between-garage-and-new-kitchen-now-built-up-wall-completed-to-tie-in-with-existing-wall

battening-and-metal-strips-now-in-place-for-rough-casting-of-bricks-on-new-extension

new-side-step-to-back-of-garage
Day 112 -Tuesday 6th December 2016
Aco drains

aco-drains-put-in-today-down-the-side-of-the-garage-ground-built-up-to-provide-a-downward-flow-and-ramp-away-from-house-and-to-stop-water-going-into-the-garage

aco-drain-down-side-of-garage

view-of-aco-drain-from-back-of-new-kitchen
Day 113 – Wednesday 7th December 2016

Pathway between new kitchen and garage. Slabs being laid. Also scratch coat on new kitchen wall has been applied.

boards-up-to-stop-us-treading-on-freshly-laid-slabs

main-steps-to-garden-from-new-kitchen-partially-laid

scratch-coat-on-walls-and-more-freshly-laid-slabs

scratch-coat-on-outside-of-walls-of-kitchen-back-and-sides

scratch-coat-on-outside-of-new-back-of-kitchen
Day 114 – Friday 9th December 2016 (no work carried out on Thursday)

Path between garage and kitchen. More Indian Sandstone slabs were delivered and have been cut.

path-between-garage-and-new-kitchen-from-back-to-front-of-house

progress-of-patio-at-back-of-kitchen
Day 115 – Saturday 10th December 2016
Assembly of kitchen units begins. This will not be completed till after Christmas.

Base Kitchen Units going into place along with dishwasher

tall-kitchen-cabinet-and-base-kitchen-units-going-into-place
Days 116 and 117 December 12th and 13th 2016

Plumber has now installed 2 radiators in kitchen very warm now

2nd-radiator-on-back-wall-of-kitchen

Final slabs cut on Monday and cemented in Tuesday, still to be jointed

final-patio-slabs-cut-on-Monday-and-cemented-in-Tuesday
Days 118, 119 and 120 – 14th, 15th, 16th December 2016

New family bathroom – Old doorway from old bedroom to hall now plaster boarded over. Then new bathroom floor is laid. First a wooden flooring is laid and marked with a grid.

grid-pattern-marked-out-on-wood-flooring

new-bathroom-wood-screwed-down-in-a-grid-pattern-to-ensure-tiles-will-be-laid-on-a-solid-base

New bath in place

close-up-of-tiles-in-new-bathroom

some-floor-tiles-and-wall-tiles-laid-in-new-bathroom

walkway-up-between-garage-and-new-kitchen-slabs-have-been-jointed-filled-between-each-slab

view-from-main-patio-of-new-patio

slabs-laid-on-steps-not-cemented-between-slabs-yet

patio-behind-house-now-all-finished-cement-between-slabs-jointing
Day 121 – Monday 19th December 2016

Newly tiled bathroom

progress-in-new-bathroom-shower-boards-up-bath-fitted-shower-fitted

view-of-bath-shower-shower-board-and-tiles
Bath filled with water whilst it sets in place. This will prevent movement of bath when using shower and bath.
Day 122 – Tuesday 20th December 2016

New Bath and Shower

New family bathroom with towel radiator toilet and sink

toilet-and-wash-hand-basin
Day 123 – Thursday 22nd December 2016

New door for bathroom too tall, cut to fit
Kitchen fitting over Christmas holiday

tv-fitting

Smart TV

Kitchen unit and island assembly

The mobile island!

High Gloss Wall Cabinets from Wrens Kitchens

wall-units-and-base-units-now-fitted-measurements-can-now-be-taken-for-worktops

Wall and Base units
Day 124 – Tuesday 3rd January 2017
Delivery of new dual fuel RangeMaster cooker 1100

rangemaster-cooker-delivery-3-1-17

kitchen-3-1-17

kitchen-3-1-17 before delivery of cooker

rangemaster-arrives-3-1-17

rangemaster-132kg
Day 128 also -Wednesday 11th January 2017 – phase 1

outside-of-kitchen-has-had-more-layers-of-roughcast-added

roughcast-on-outside-of-kitchen

From the scratch-coat-on-walls-to a smooth coat as below

roughcast-outside-patio-doors-of-kitchen
Part of phase 1 being completed, the outside rendering of the new kitchen, Friday 20th January Day 135 and Saturday 21st January day 136

new-tyrolean-render-applied-today

new-tyrolean-render-applied-side-of-new-kitchen
Day 137 – Sunday 22nd January 2017 – back to phase 1 – near completion of the new family bathroom
Fitments all in place, door needs painting or varnishing and also handle required.
Interesting to compare it with how it used to look in September 2016. See the transformation below.

Small bedroom to new bathroom

small bedroom

rubble-to-be-removed-from-old-bedroom

old-bedroom-cleared-of-rubble-and-window-removed

drilling-and-loosening-brick-work-in-new-doorway-before-inserting-2-new-lintels

new-doorway-cut-into-old-bedroom-which-will-be-new-bathroom-picture-taken-from-utility-side

Spot Marcus, our plumber, in a very tight spot, under the floor in the new bathroom

new-bathroom-pipework-for-shower

plasterboarding-new-bathroom-beam-boxed-in

New family bathroom Old doorway from old bedroom to hall now plaster boarded over. Then new bathroom floor is laid. First a wooden flooring is laid and marked with a grid.

some-floor-tiles-and-wall-tiles-laid-in-new-bathroom

progress-in-new-bathroom-shower-boards-up-bath-fitted-shower-fitted

New Family Bathroom

New Family bathroom – right hand side

new-family-bathroom-picture-3
Day 145 – Tuesday 31st January 2017 – phase 1+2
Roof tiles all stripped off today under supervision from bat licensed ecologist. Balcony window taken out and flat roof taken off. From phase 1, worktop for new kitchen which had been measured and cut to size has now been fitted.

newly-fitted-worktop-for-kitchen-and-island-unit

New worktop fitted – a transformation
Day 149 – Monday 6th February 2017 – phase 1 – kitchen

New under kitchen unit lighting. Kitchen cooker hob still to be connected to the gas supply. Our electrician came up trumps with the lighting! So pleased with it – it is so smart! All electrical work in the kitchen completed by Ballan Electrical Ltd. First Class job!

new-under-cupboard-unit-lighting-in-new-kitchen

new-under-cupboard-unit-lighting – Kitchen not quite completed – More photos soon
Weekend work – Sunday 5th March 2017 – phase 1
Phase 1 work this weekend – Tony (brother-in-law) has fitted handles to bathroom and kitchen door and has begun to tile the kitchen (white tiles!)
Phase 2 work this weekend – Paul has been working on the upstairs, beginning the painting of the ceiling in the new upstairs bedroom in readiness for Joe to return and fit the lights.

Handles now in place on door to kitchen from utility and door to new family bathroom. Fitted by Tony

The start of the tiling in the kitchen – thanks Tony!

This is what is called the ‘back buttering’ of tiles. It ensures a thin even coverage of the cement

New white tiles with spacers

Tiling starts from the centre of the cooker and works out the way in both directions

Spirit levels are essential

tiling in new kitchen

tiling in new kitchen pic 2
More photos soon when tiling is complete and grouting done.
11th and 12th March – Weekend Work

Tiles above cooker before being grouted

Tiles after the grouting in kitchen

Tiling and grouting all completed, thanks Tony!

Kitchen ready to use

Kitchen finished! Just need to fill cupboards now!

Island unit for all our baking needs!
